Being consistently wrong
Remote, distributed team Make a performance product Team morale not
great

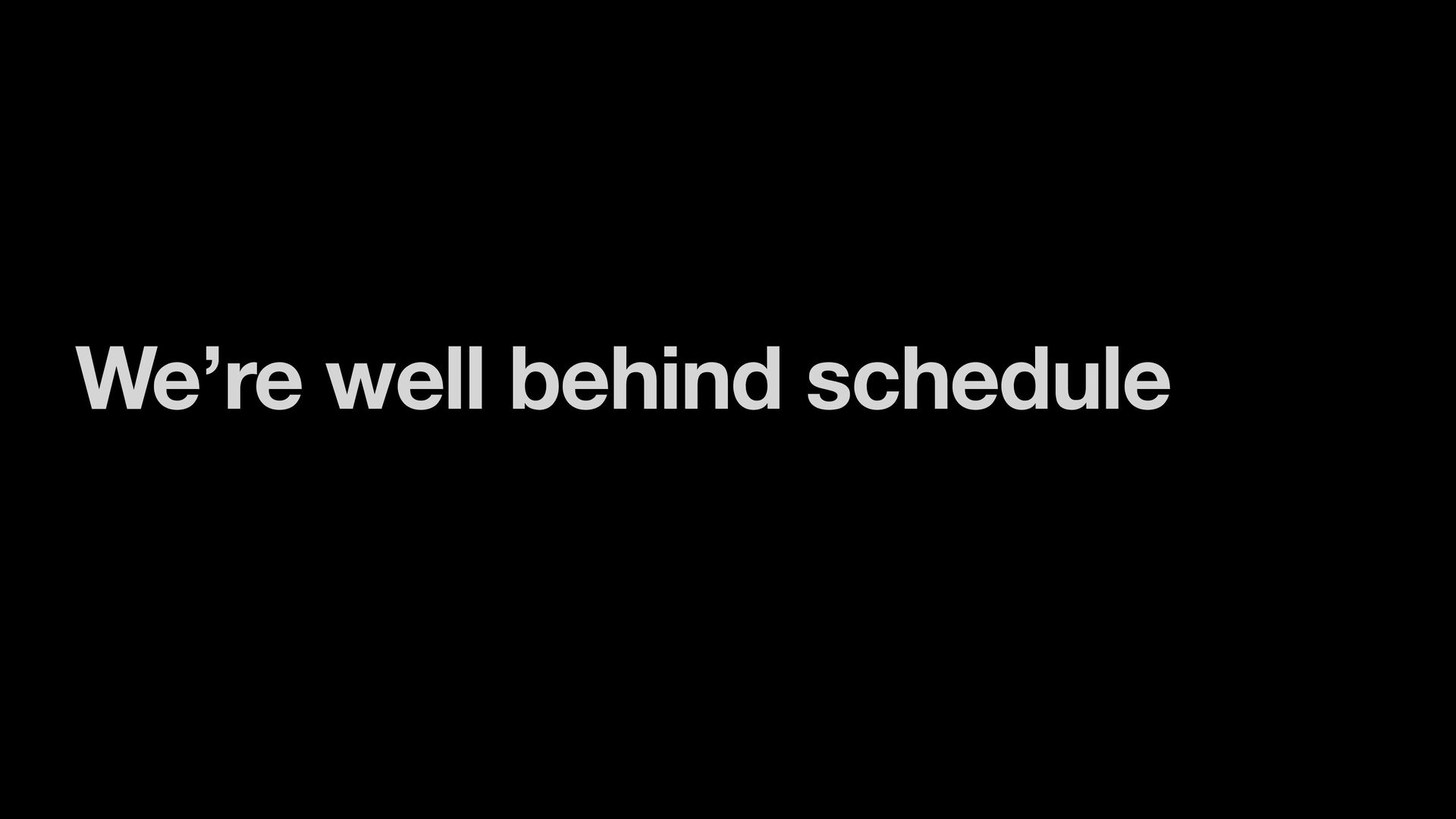

We’re well behind schedule

12 24 Weeks
We’re stuck in this loop

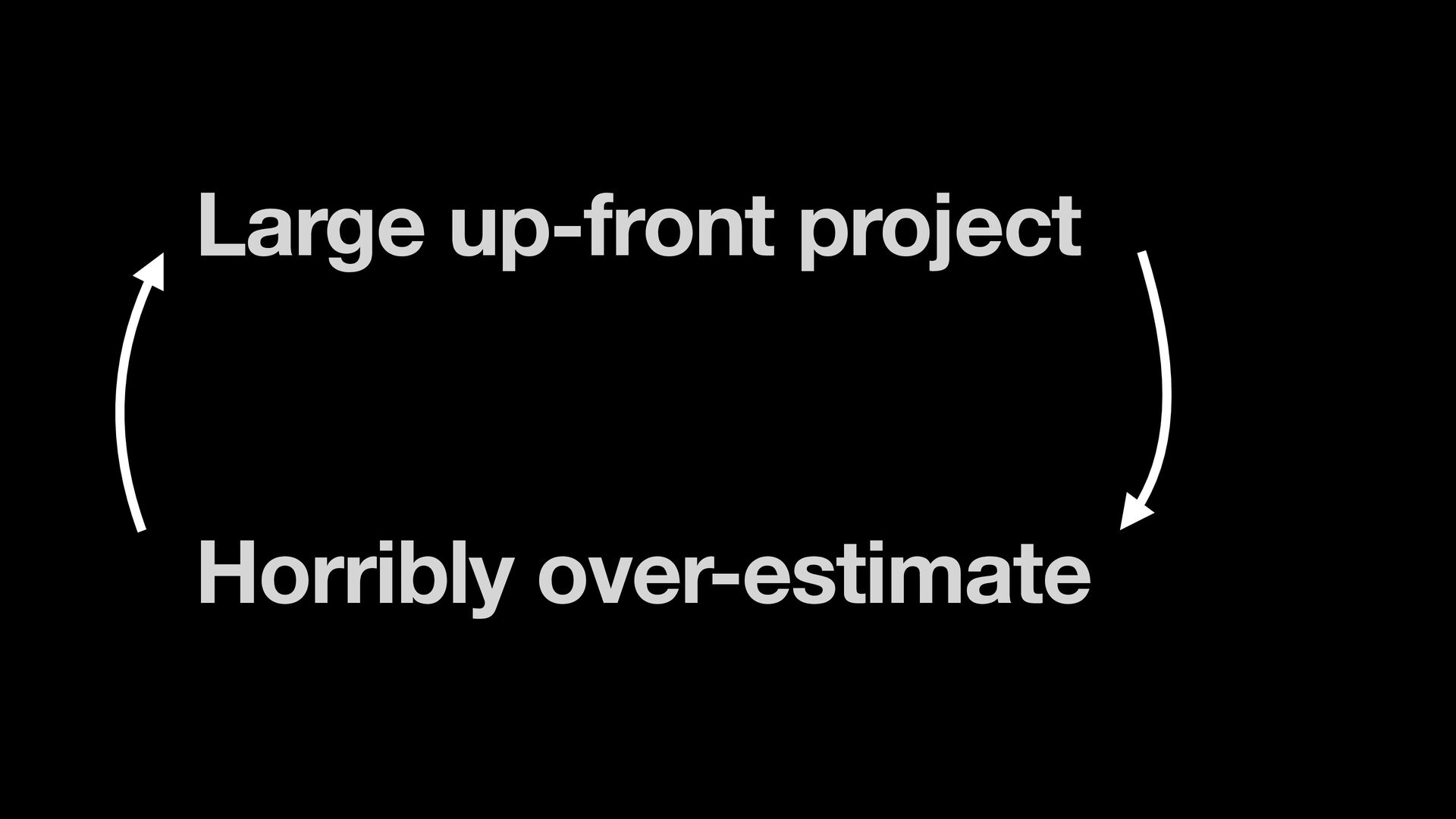

Large up-front project Horribly over-estimate

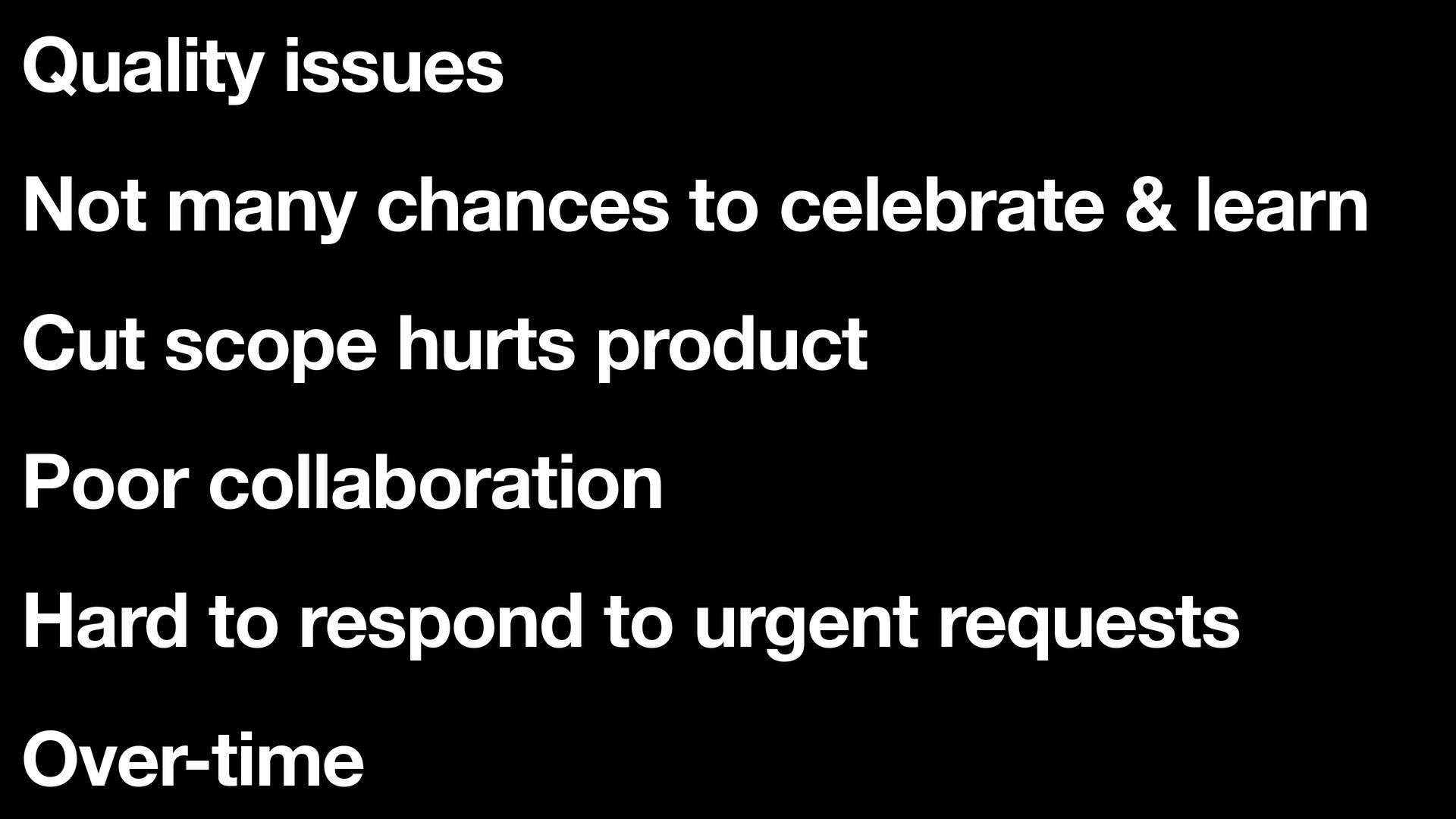

Quality issues Not many chances to celebrate & learn Cut
scope hurts product Poor collaboration Hard to respond to urgent requests Over-time

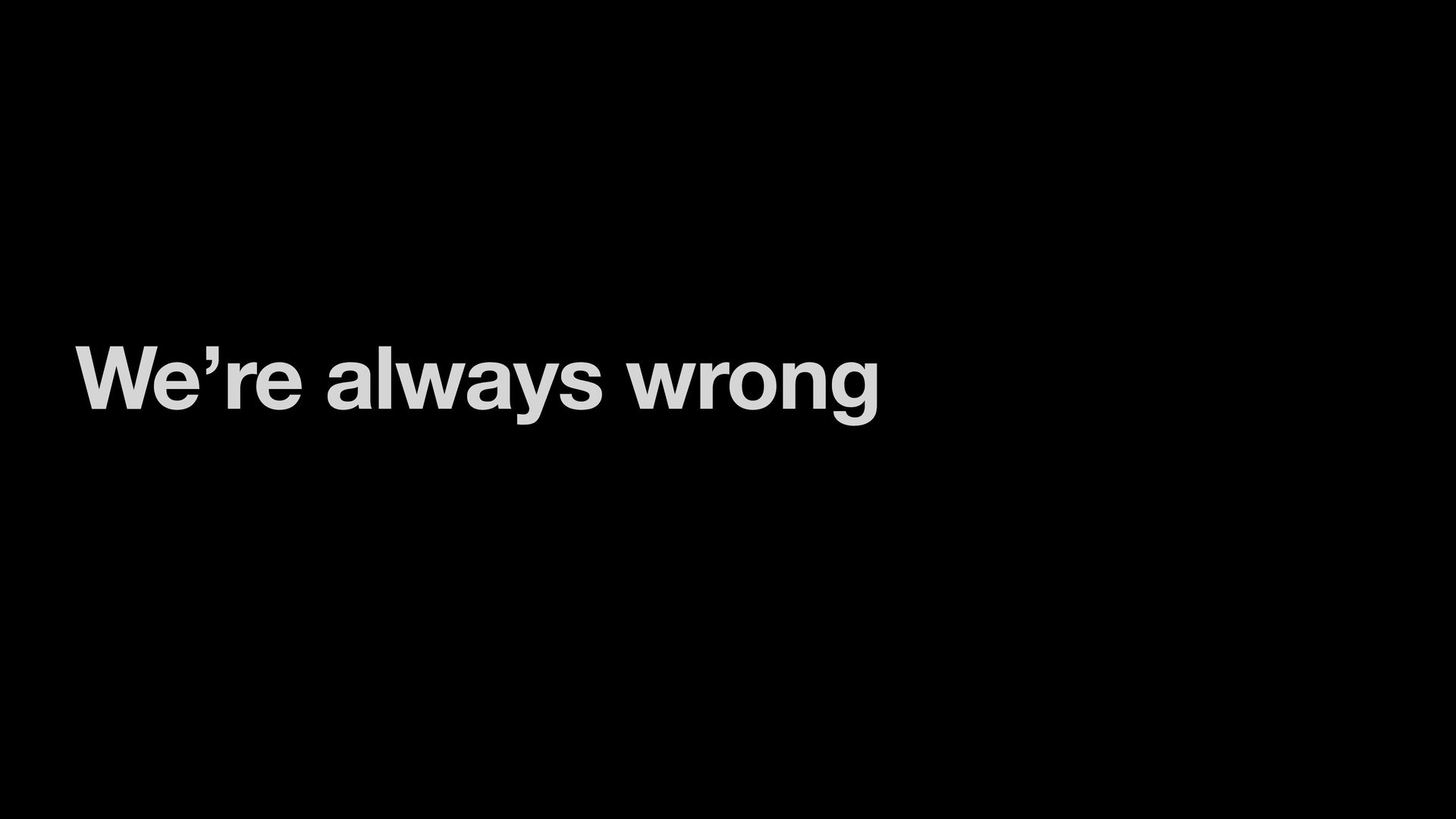

We’re always wrong
“We need to improve our delivery predictability”
Delivery Lead

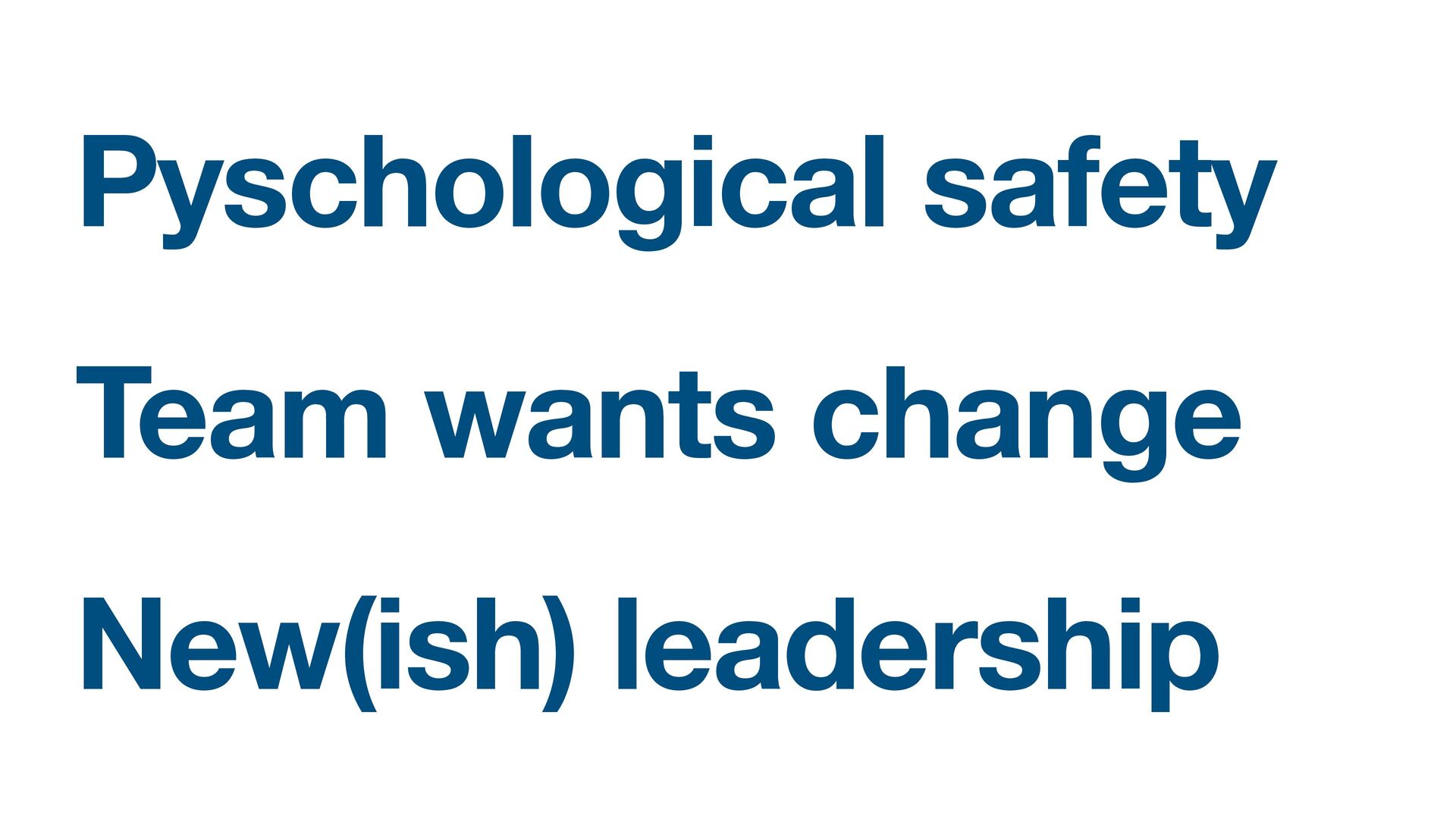

Pyschological safety Team wants change New(ish) leadership
How do we get out of this?
None
None

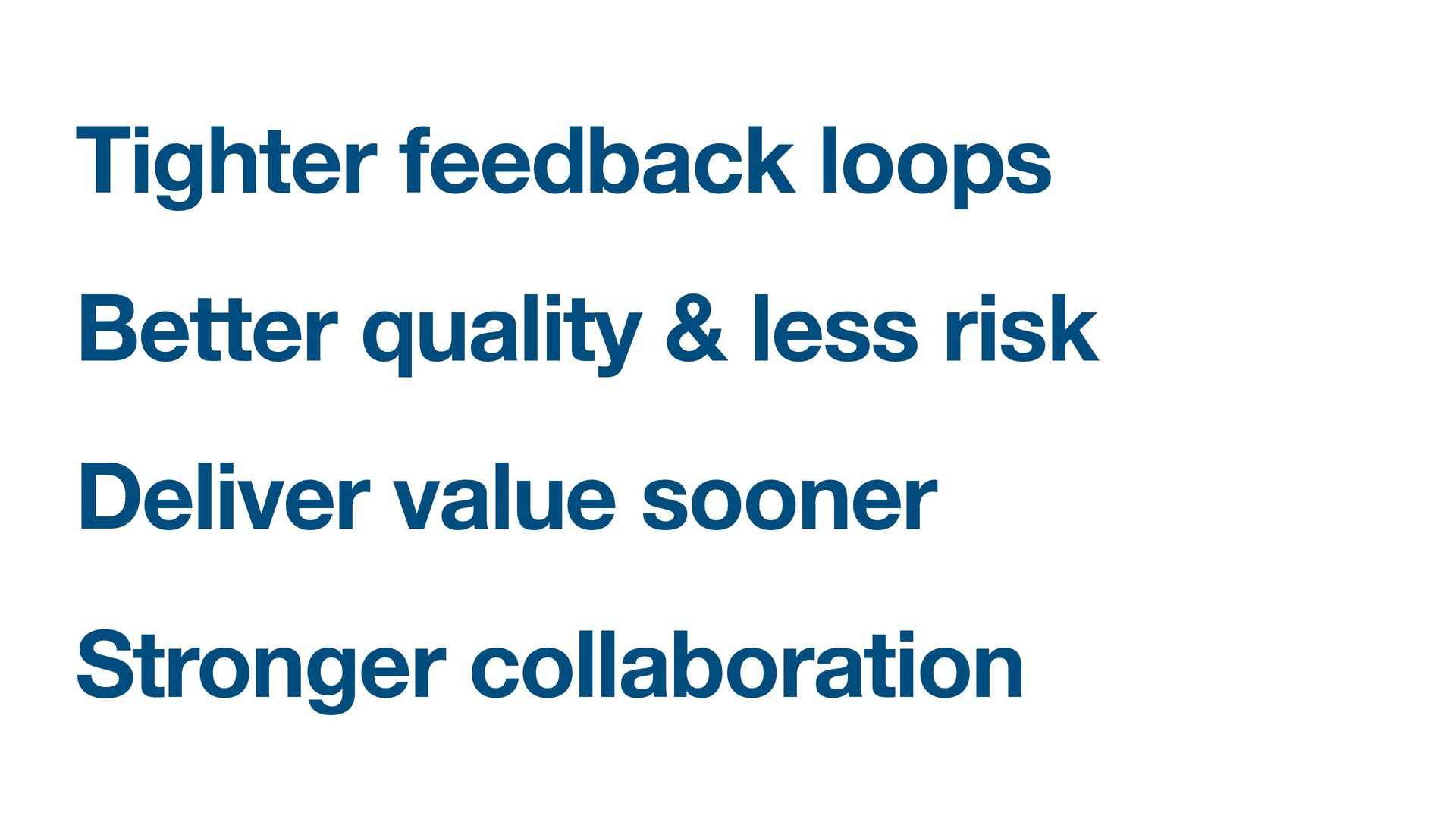

Tighter feedback loops Better quality & less risk Deliver value
sooner Stronger collaboration

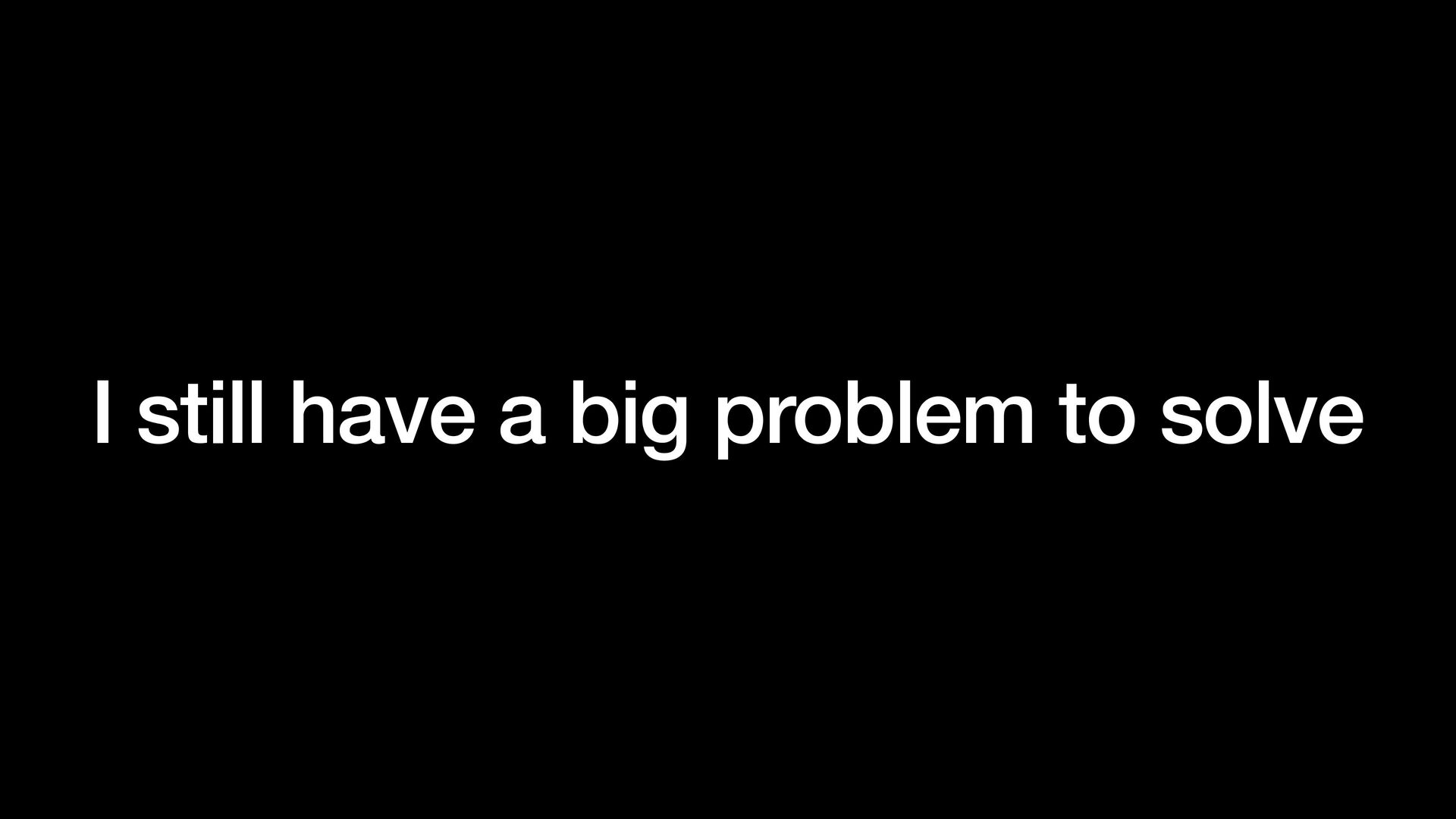

I still have a big problem to solve

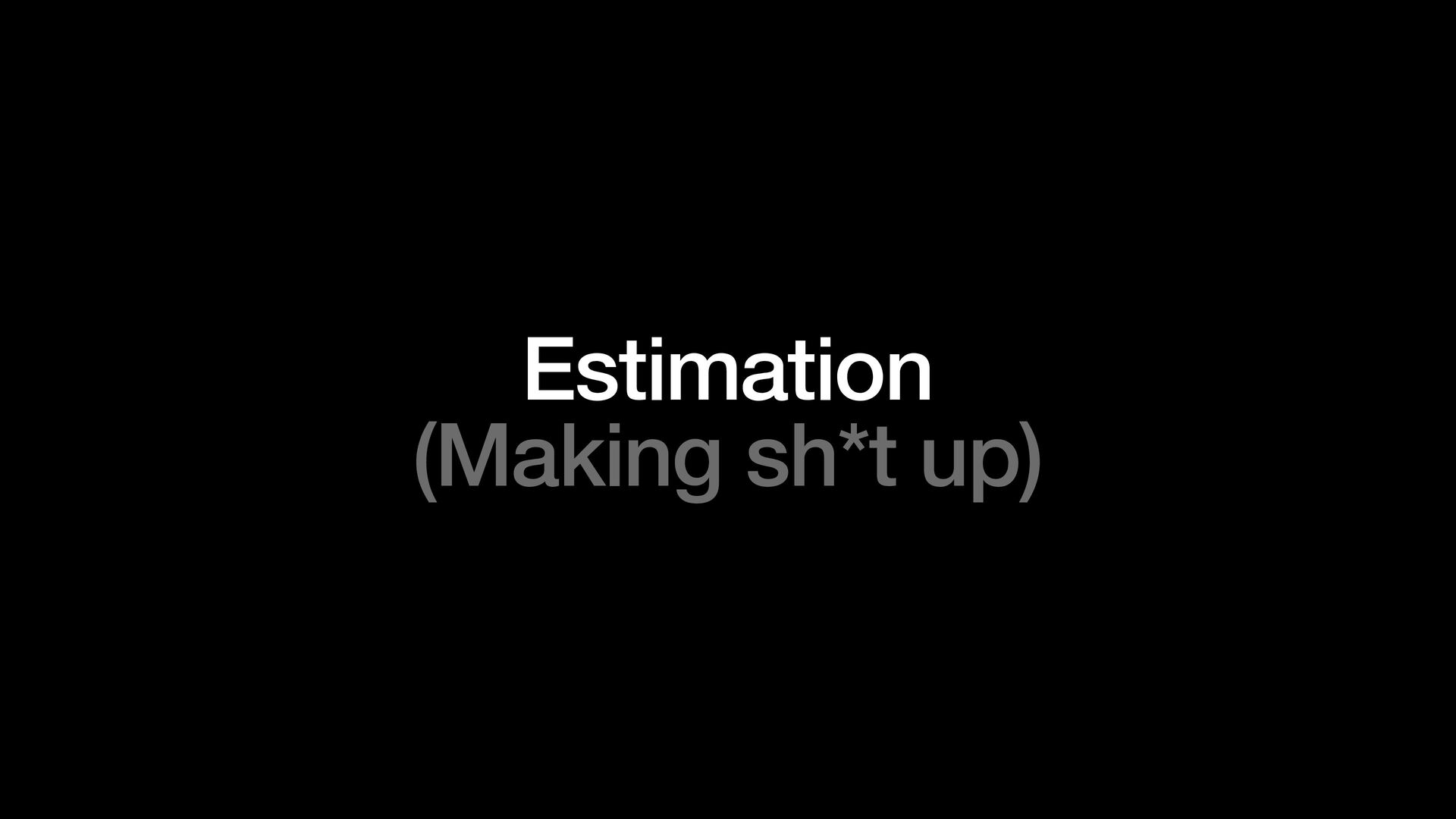

Estimation (Making sh*t up)
We’re bad at it

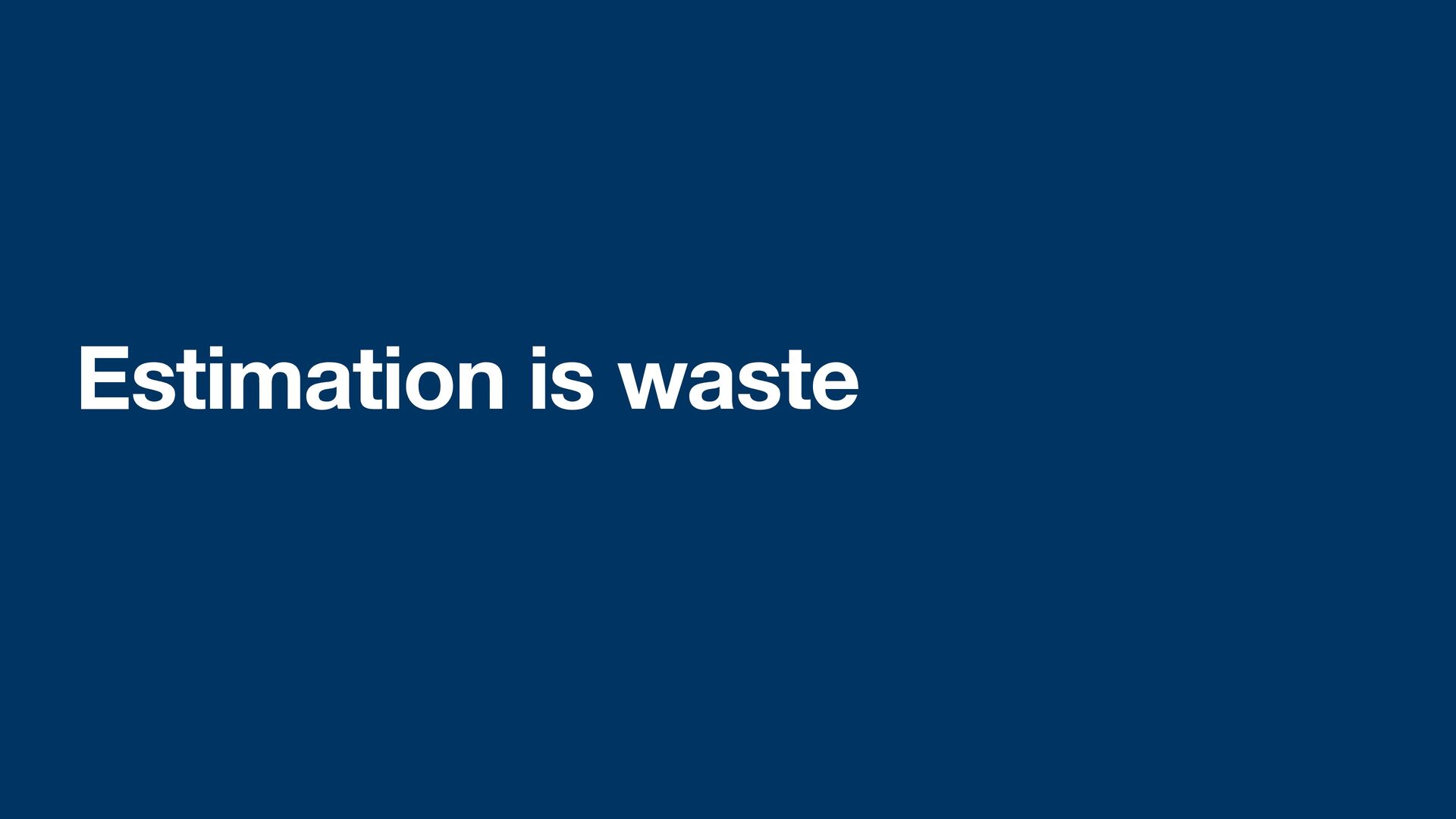

Estimation is waste

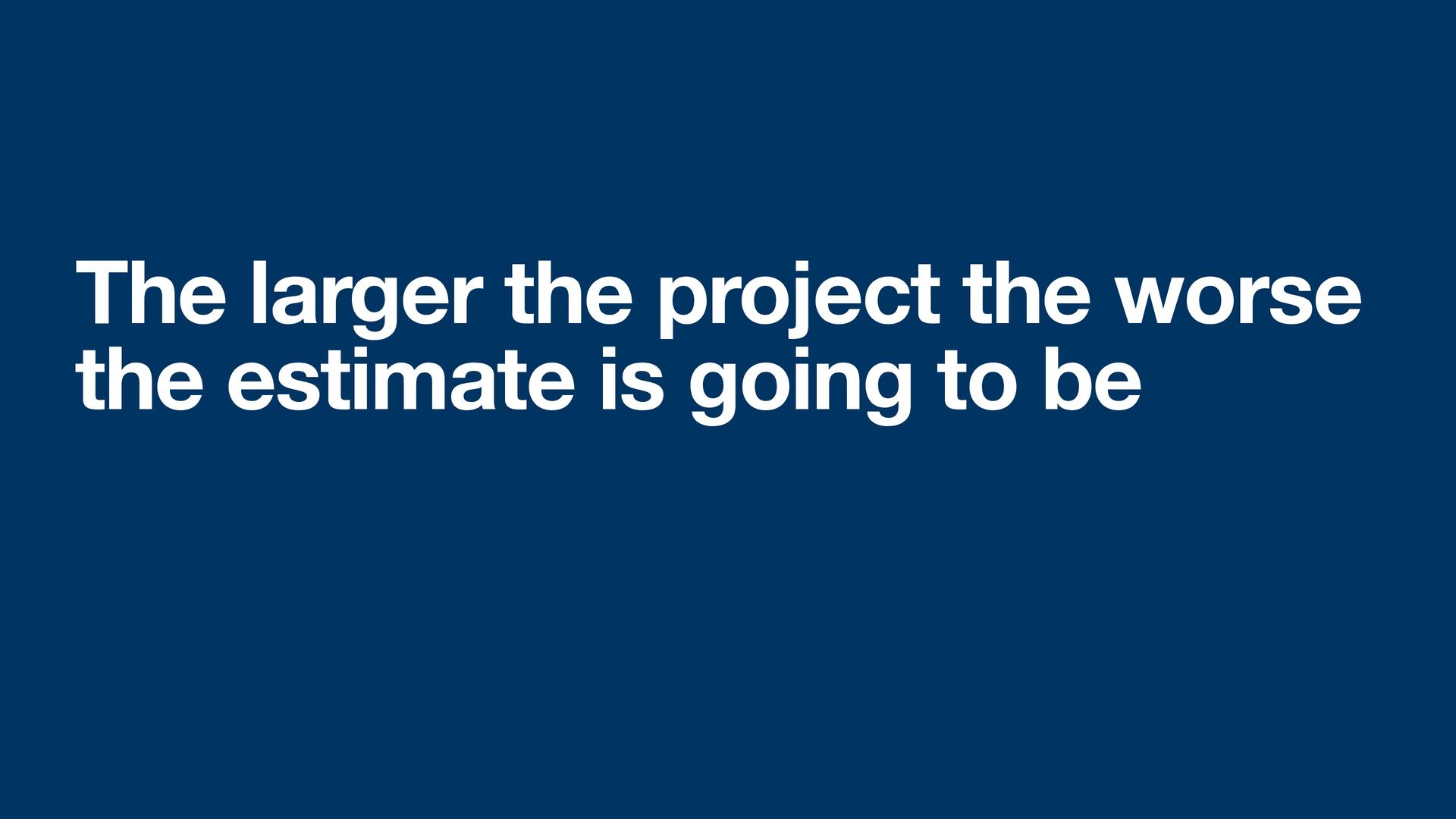

The larger the project the worse the estimate is going
to be

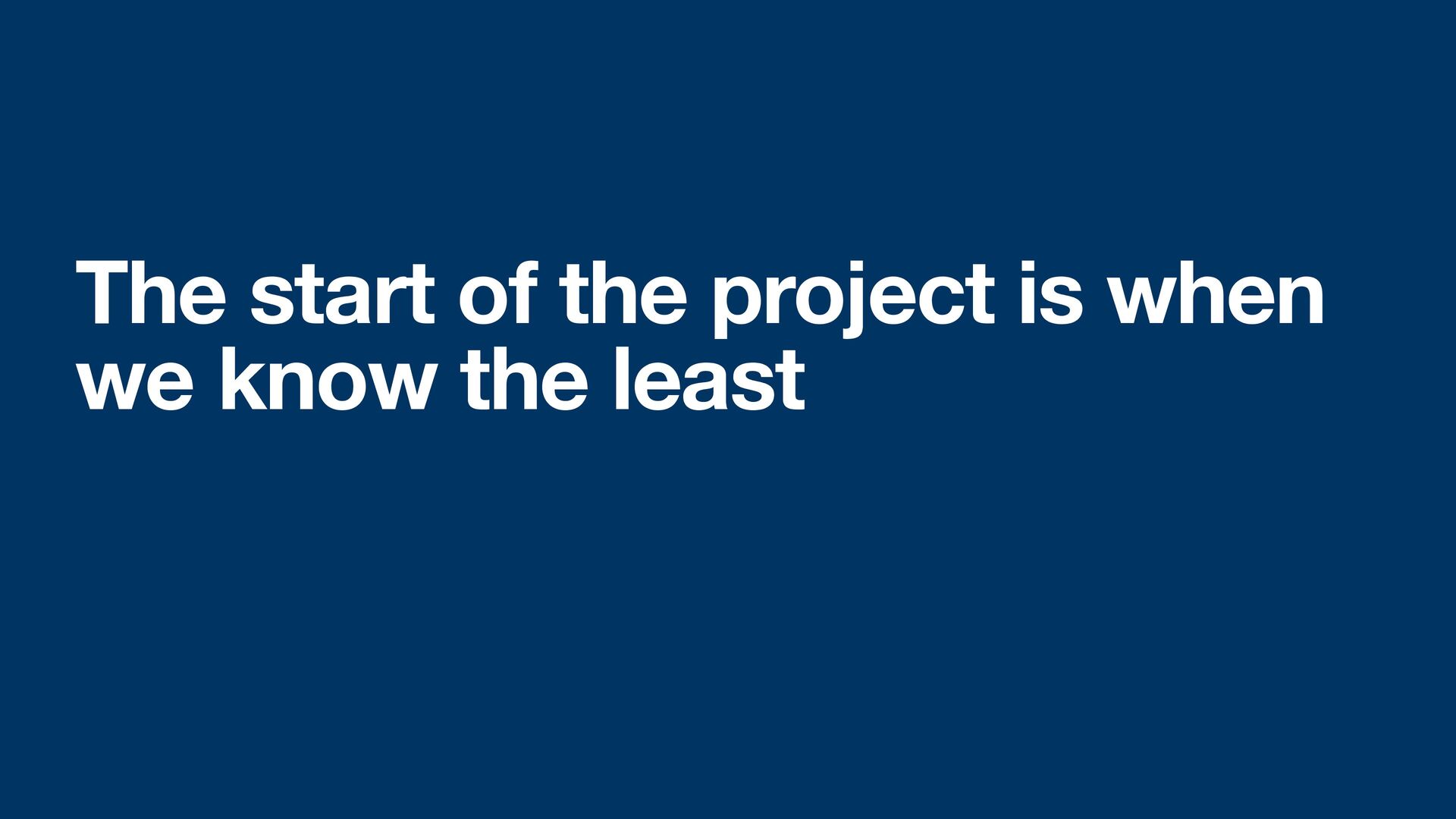

The start of the project is when we know the
least

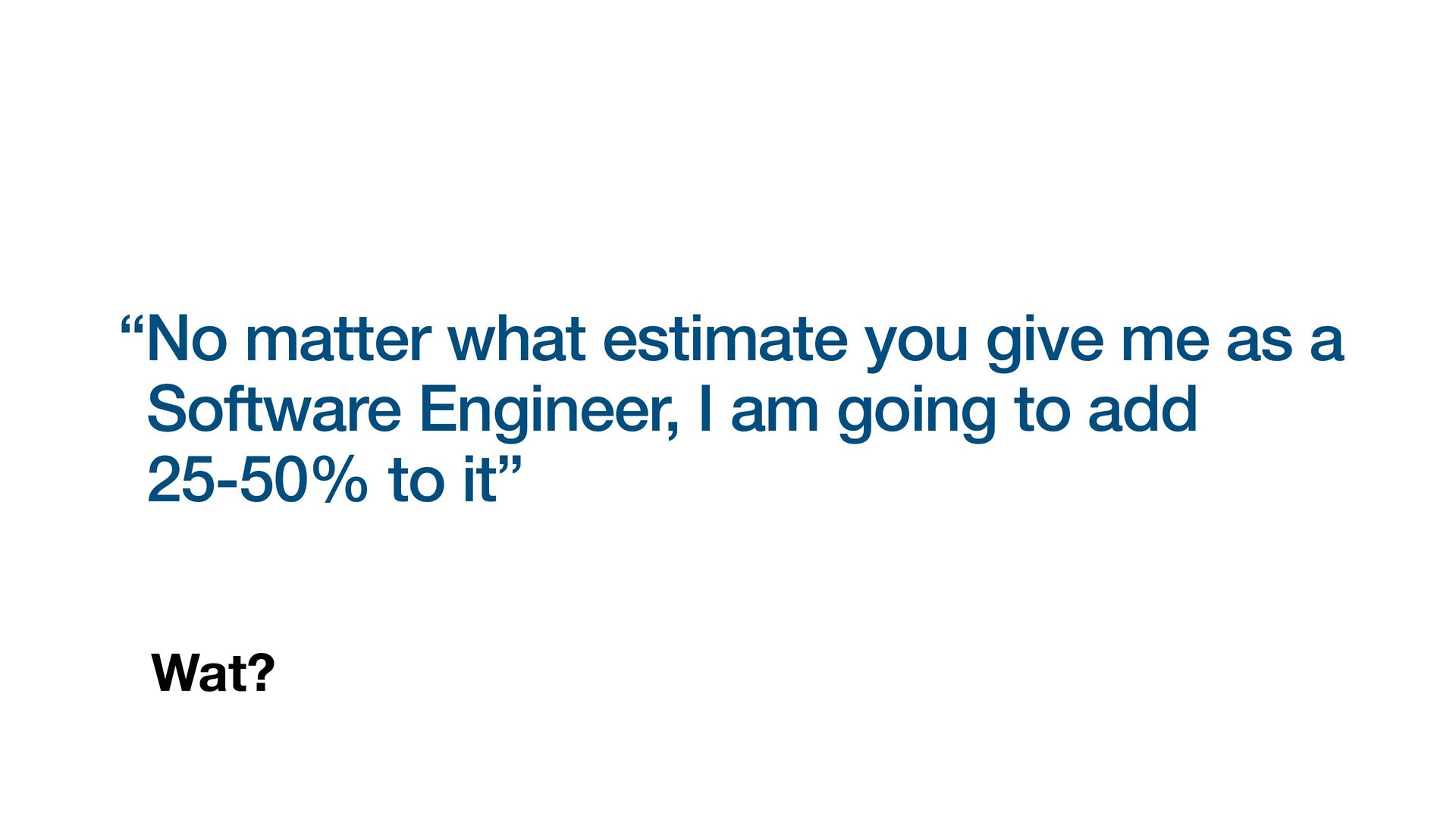

Wat? “No matter what estimate you give me as a
Software Engineer, I am going to add 25-50% to it”

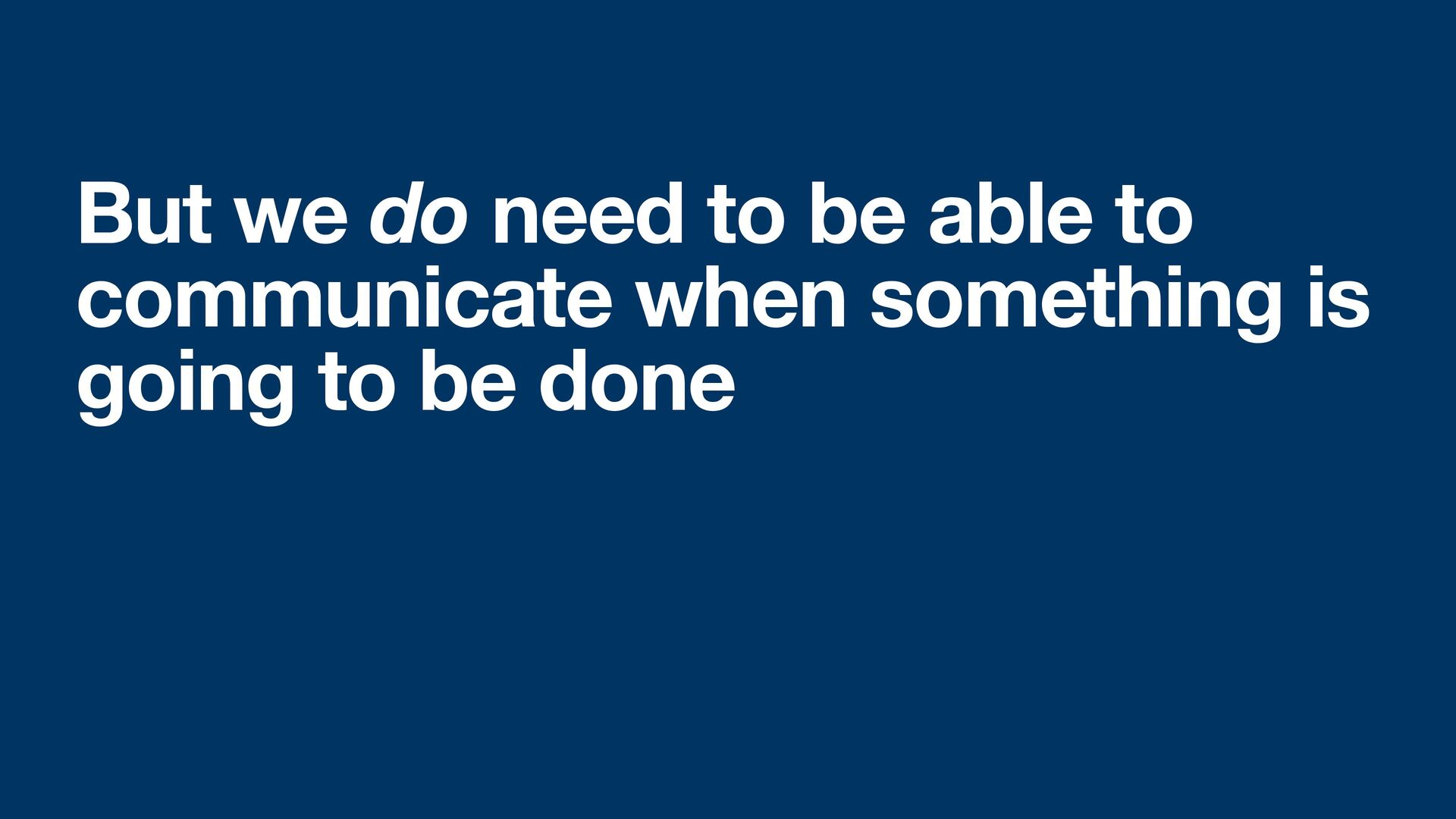

Estimation isn’t forecasting
But we do need to be able to communicate when
something is going to be done

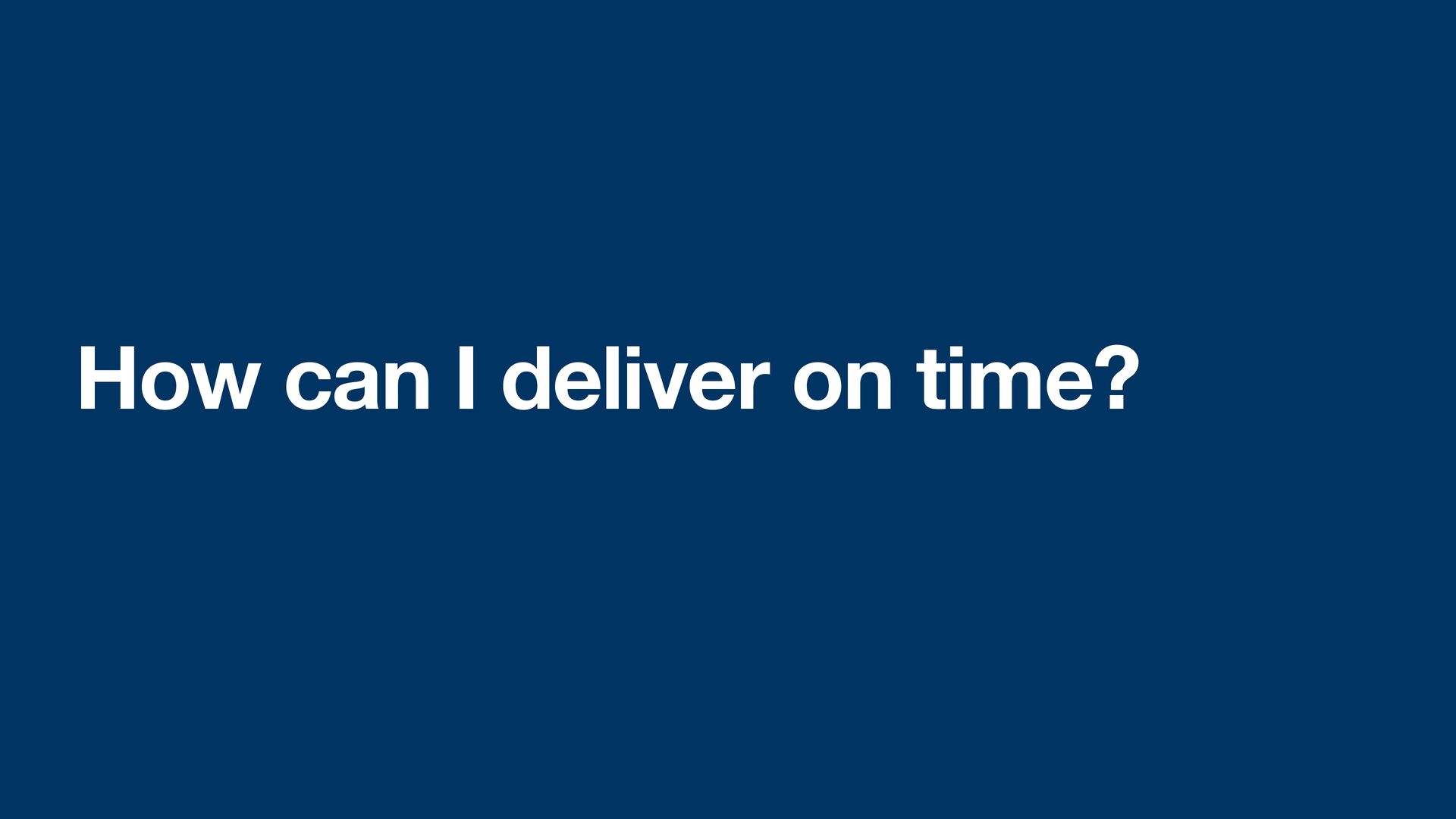

How can I deliver on time?

Days remaining = # of stories remaining / (WIP /
avg. cycle time)

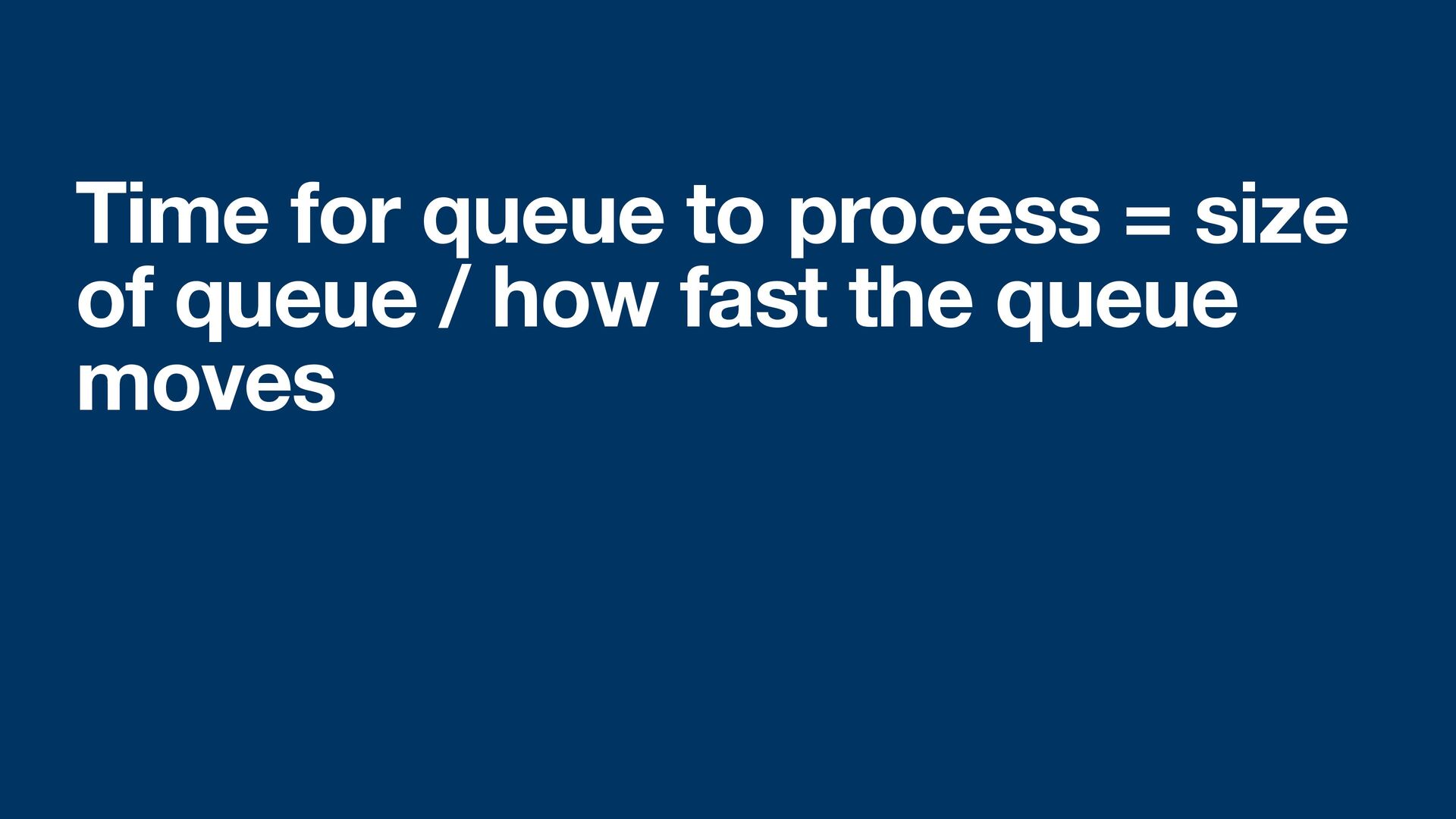

Time for queue to process = size of queue /
how fast the queue moves
Story Time in Progress Time in Review Time in QA

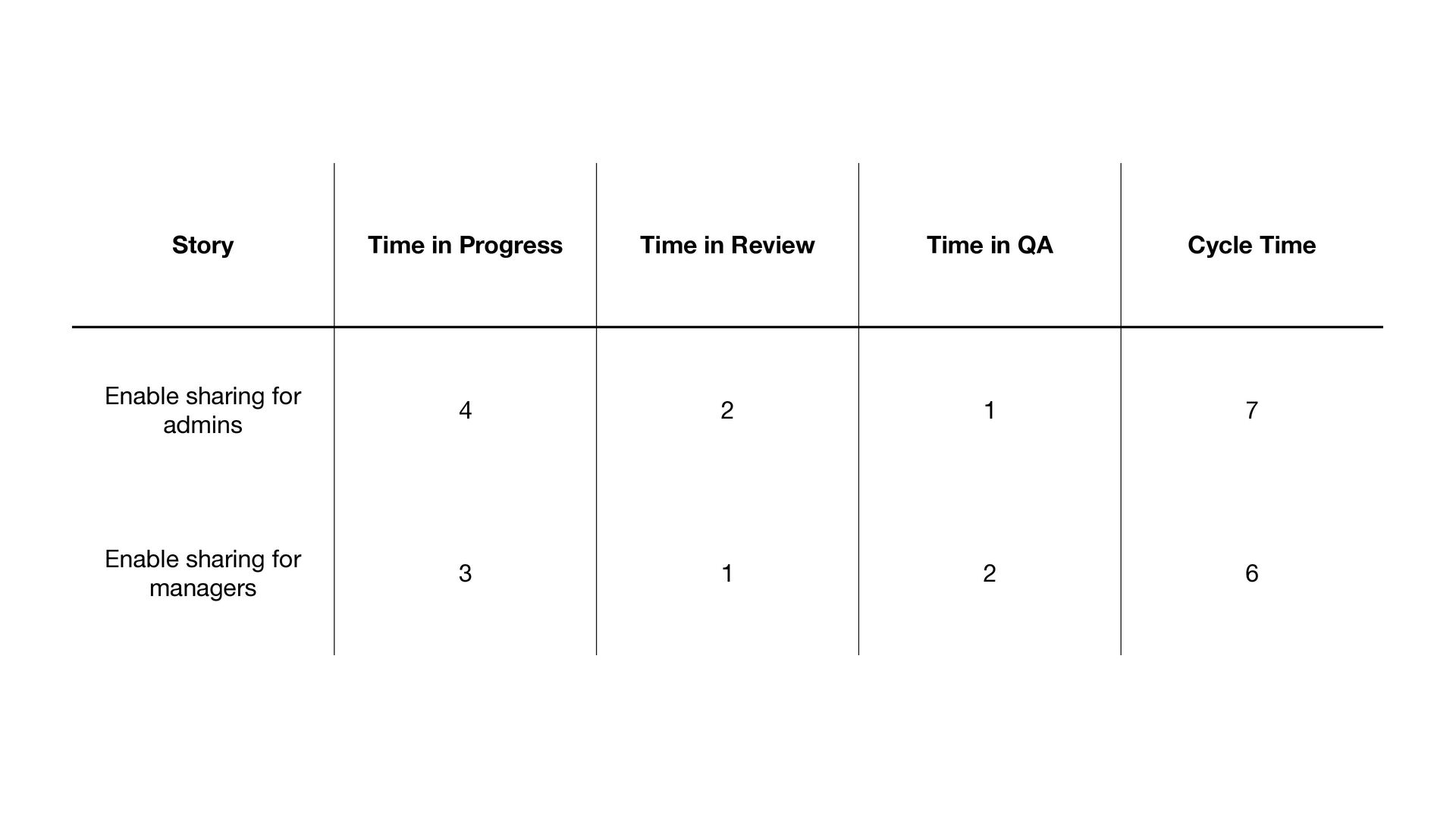

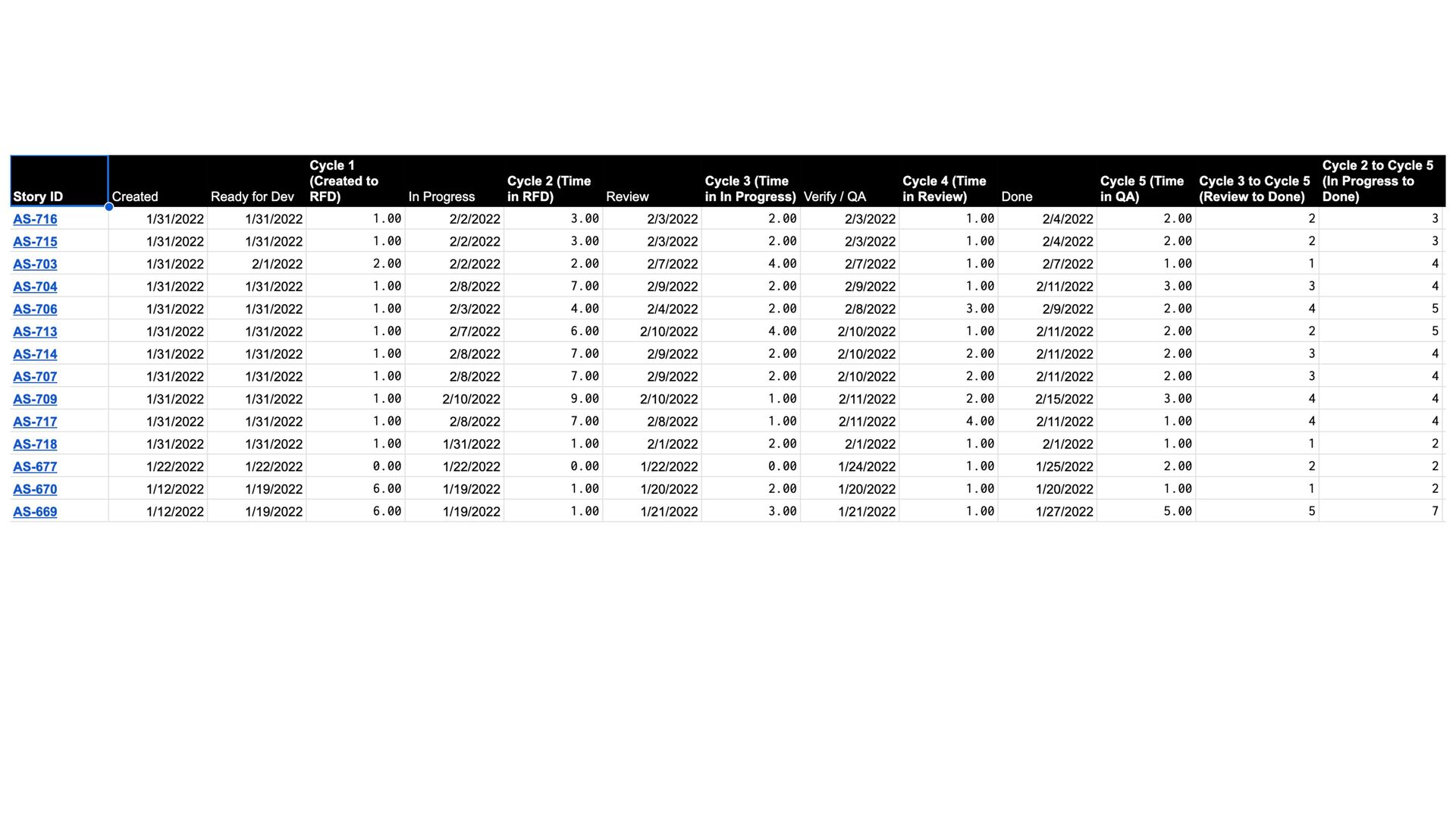

Cycle Time Enable sharing for admins 4 2 1 7 Enable sharing for managers 3 1 2 6

None
None
None

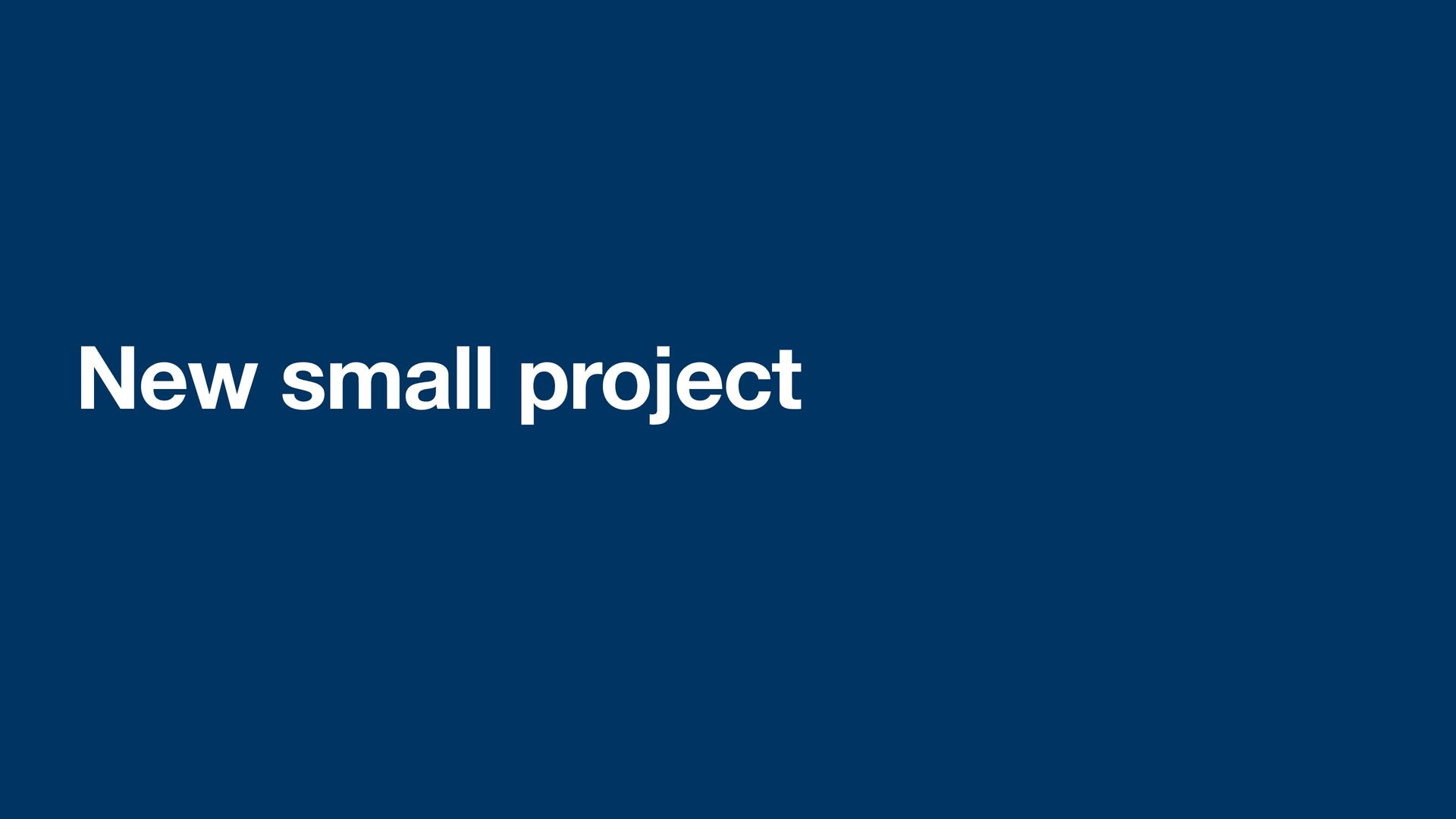

New small project

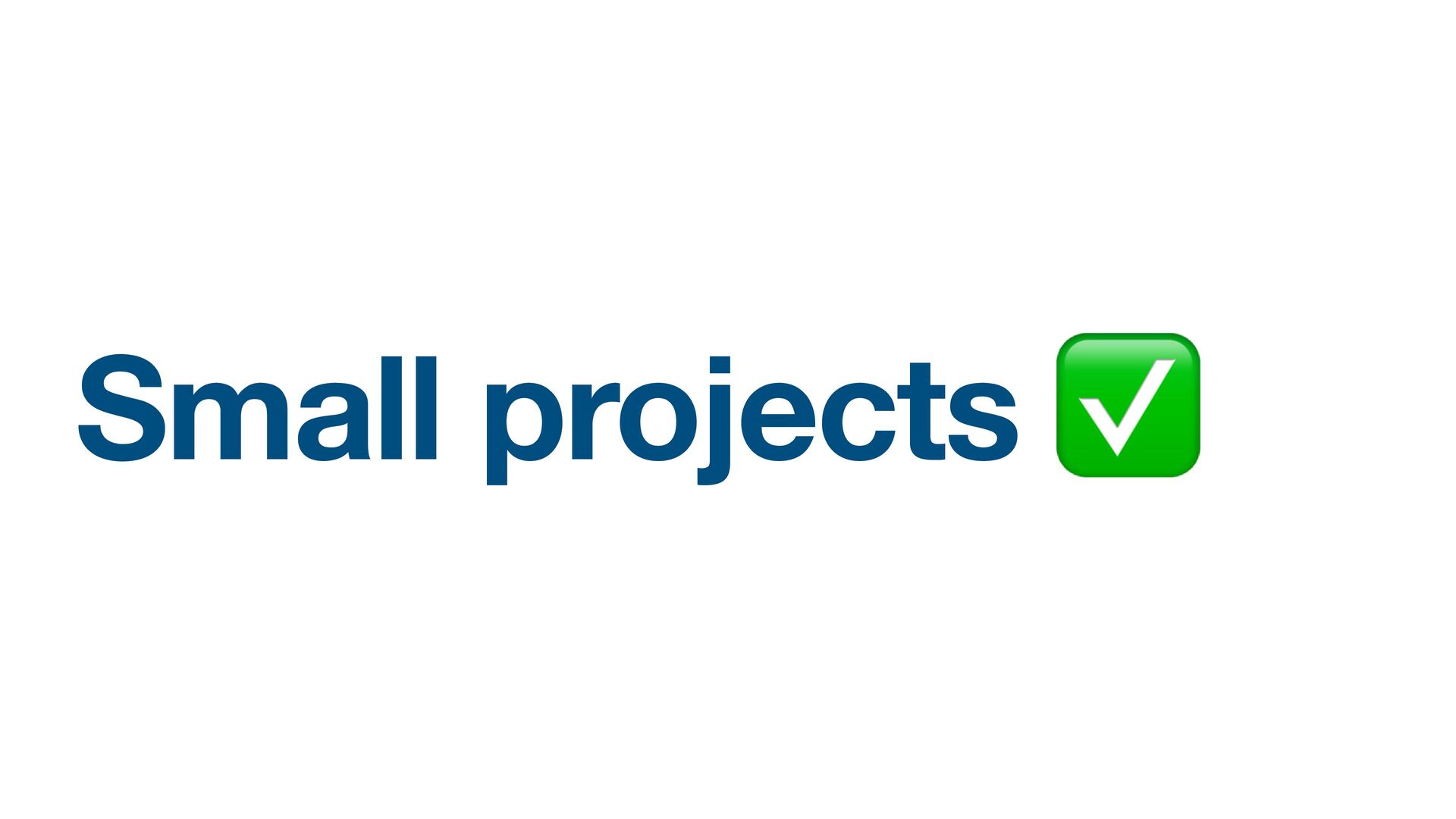

Small projects ✅

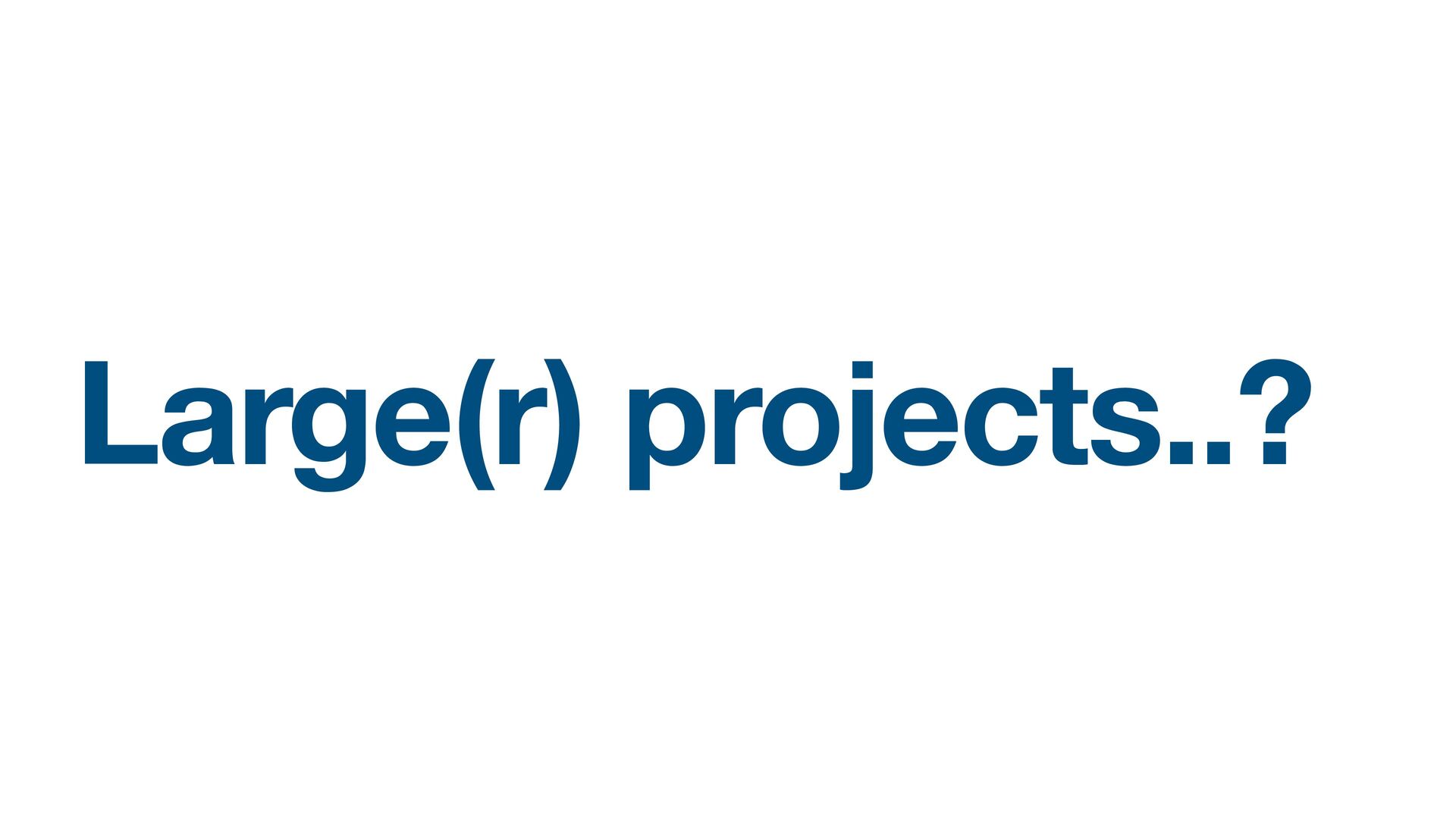

Large(r) projects..?
None
Size of the queue & how fast the queue moves
Days remaining = # of stories remaining / (WIP /
avg. cycle time)
None

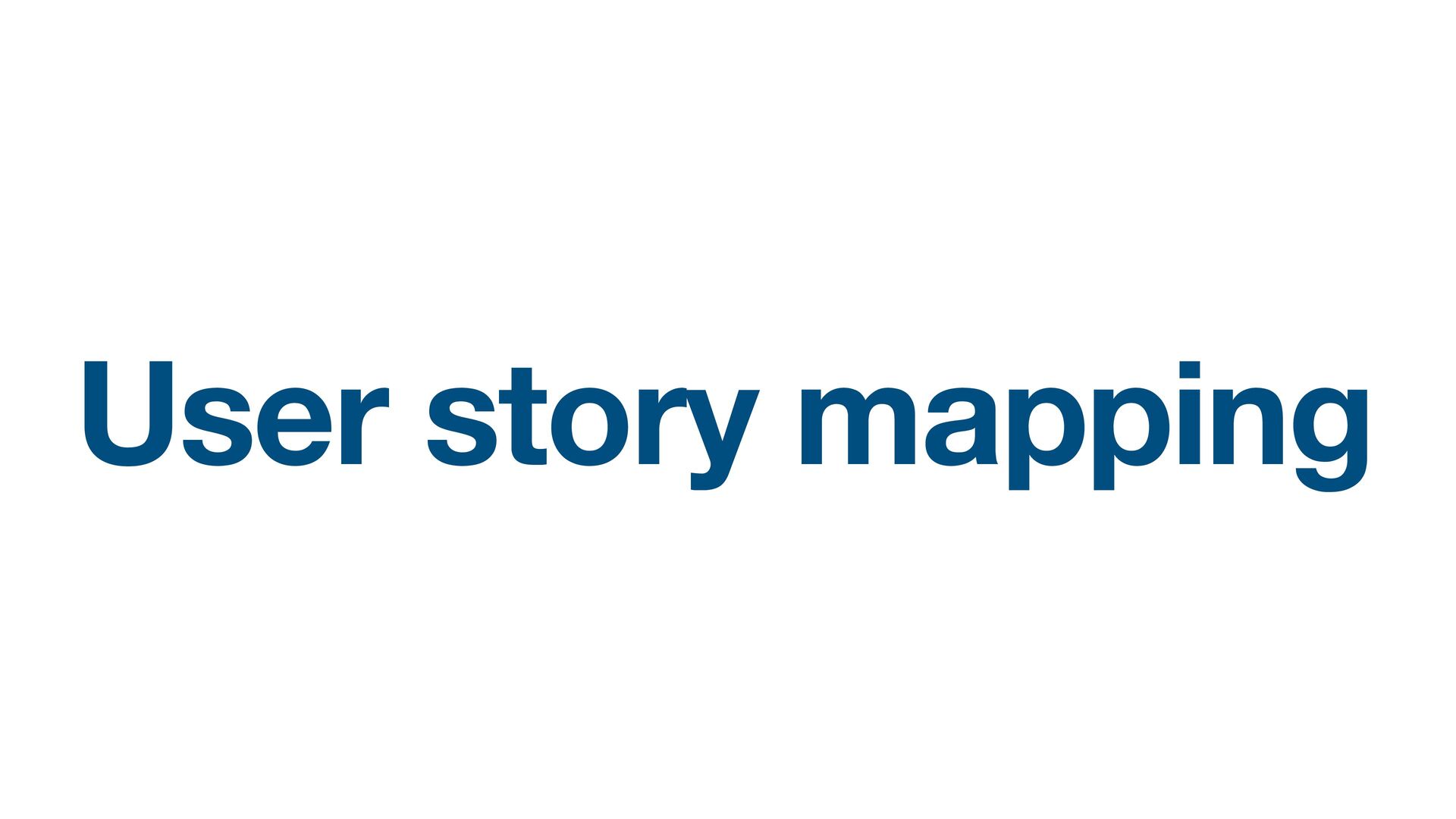

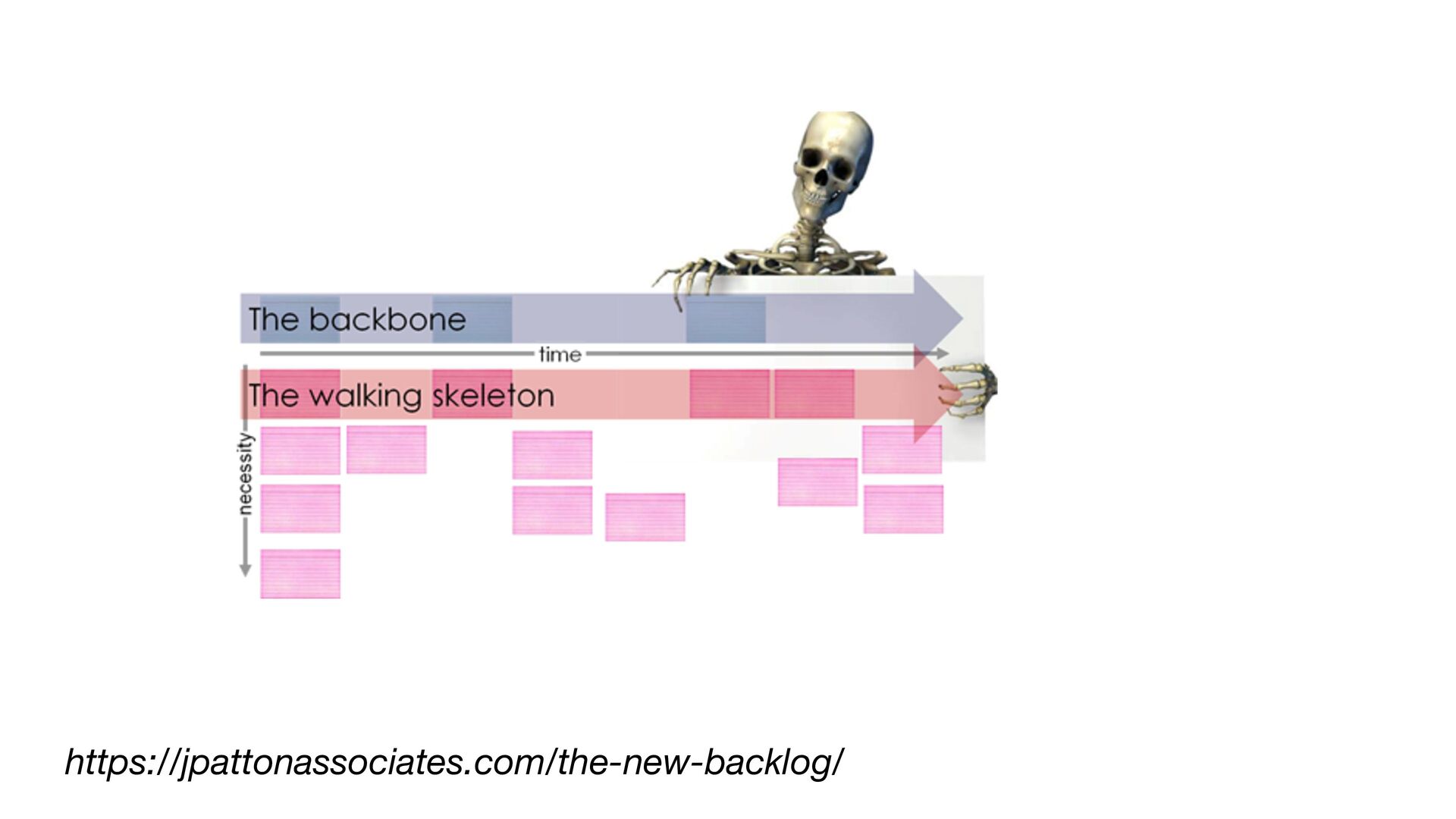

User story mapping

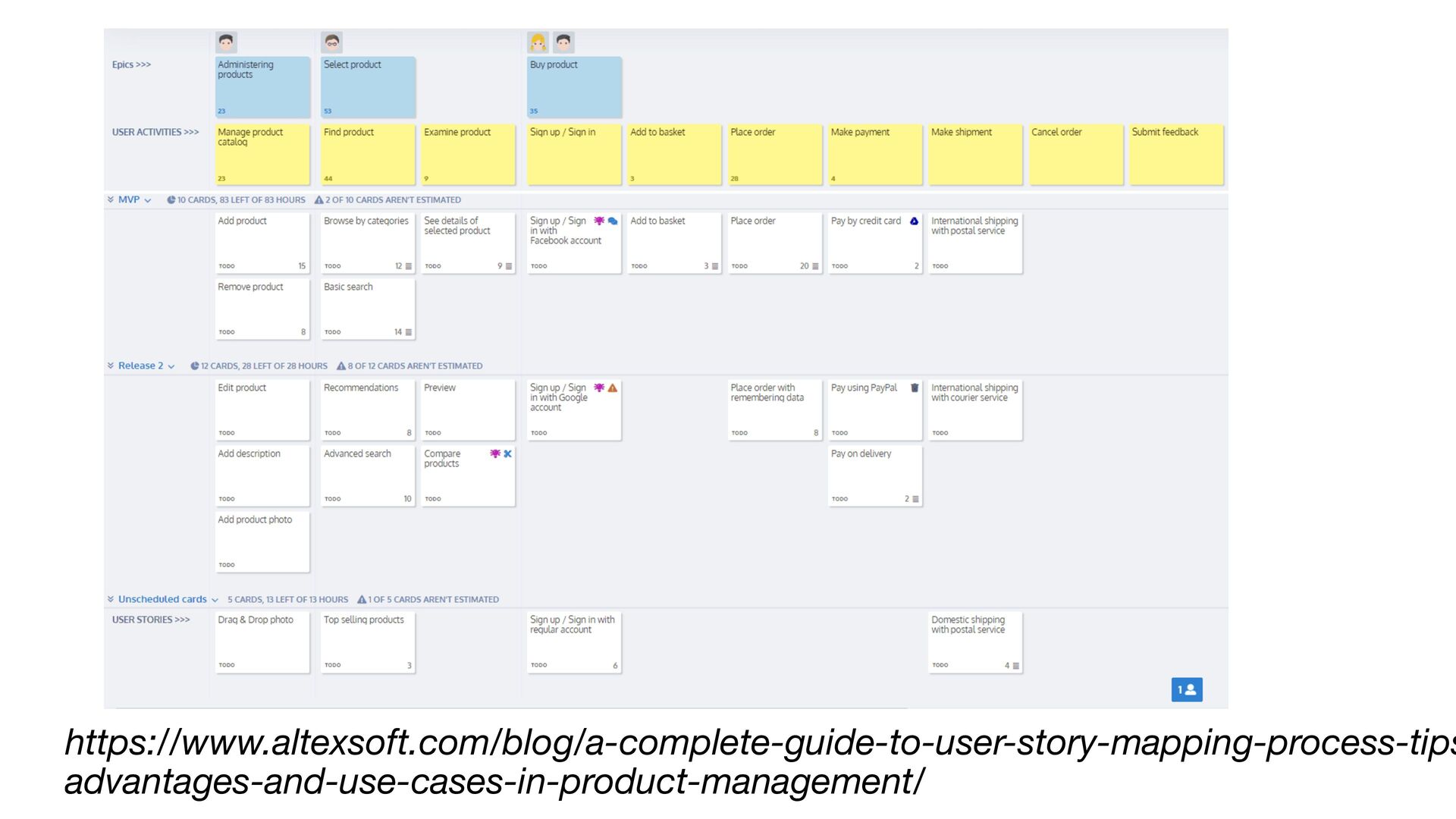

https://jpattonassociates.com/the-new-backlog/
https://www.altexsoft.com/blog/a-complete-guide-to-user-story-mapping-process-tips advantages-and-use-cases-in-product-management/

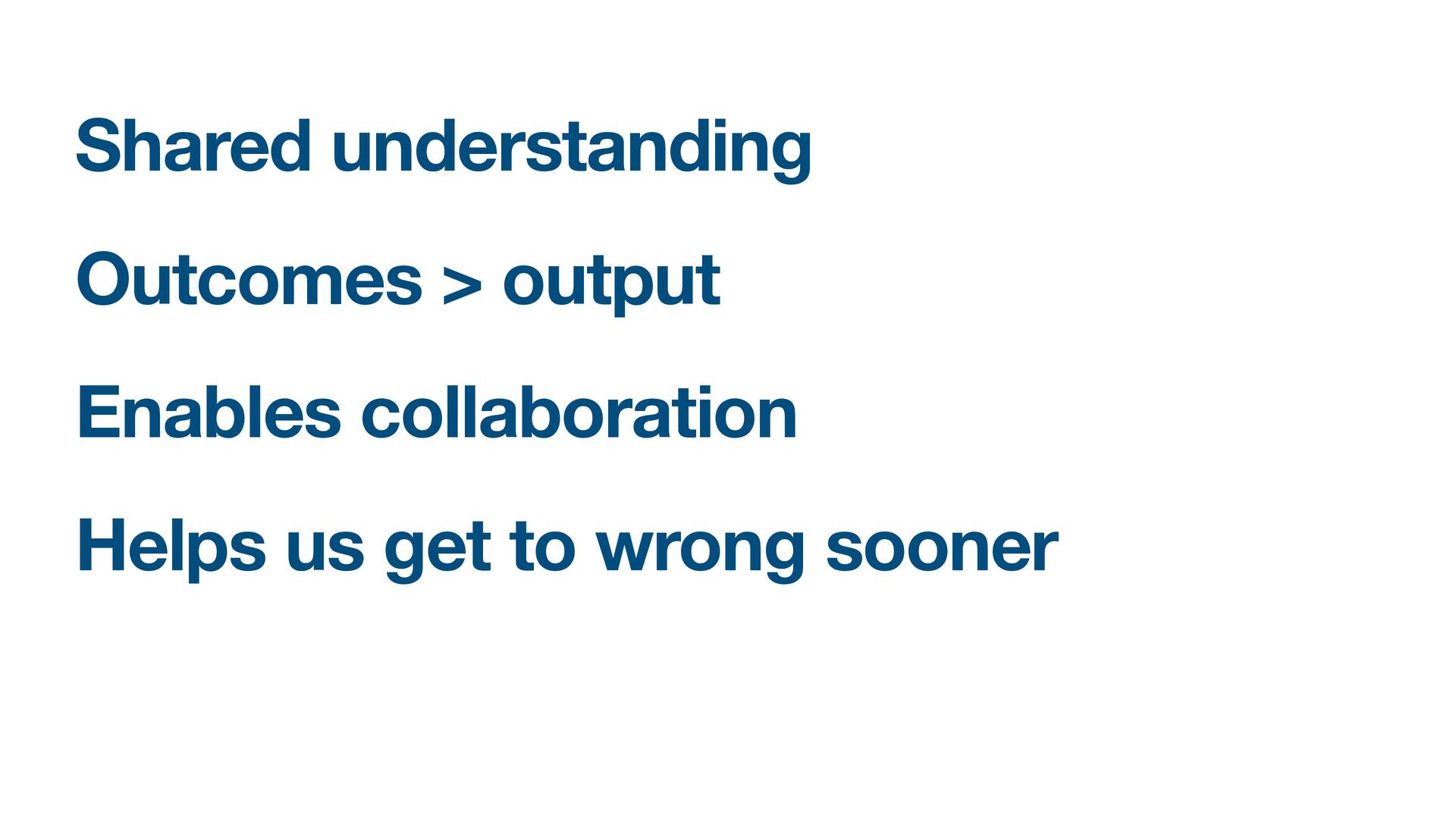

Shared understanding Outcomes > output Enables collaboration Helps us get
to wrong sooner

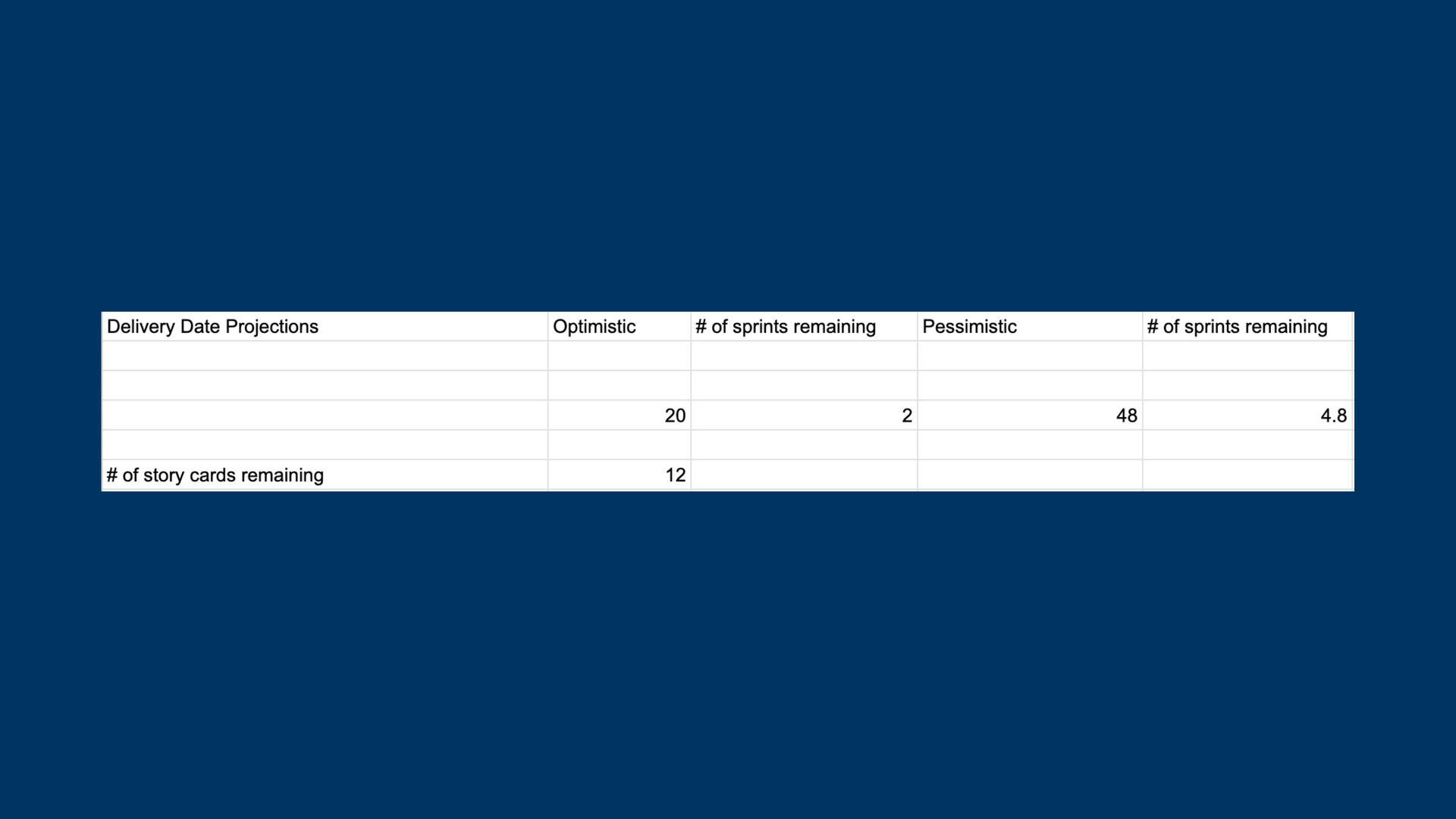

Days remaining = # of stories remaining / (WIP /
avg. cycle time)

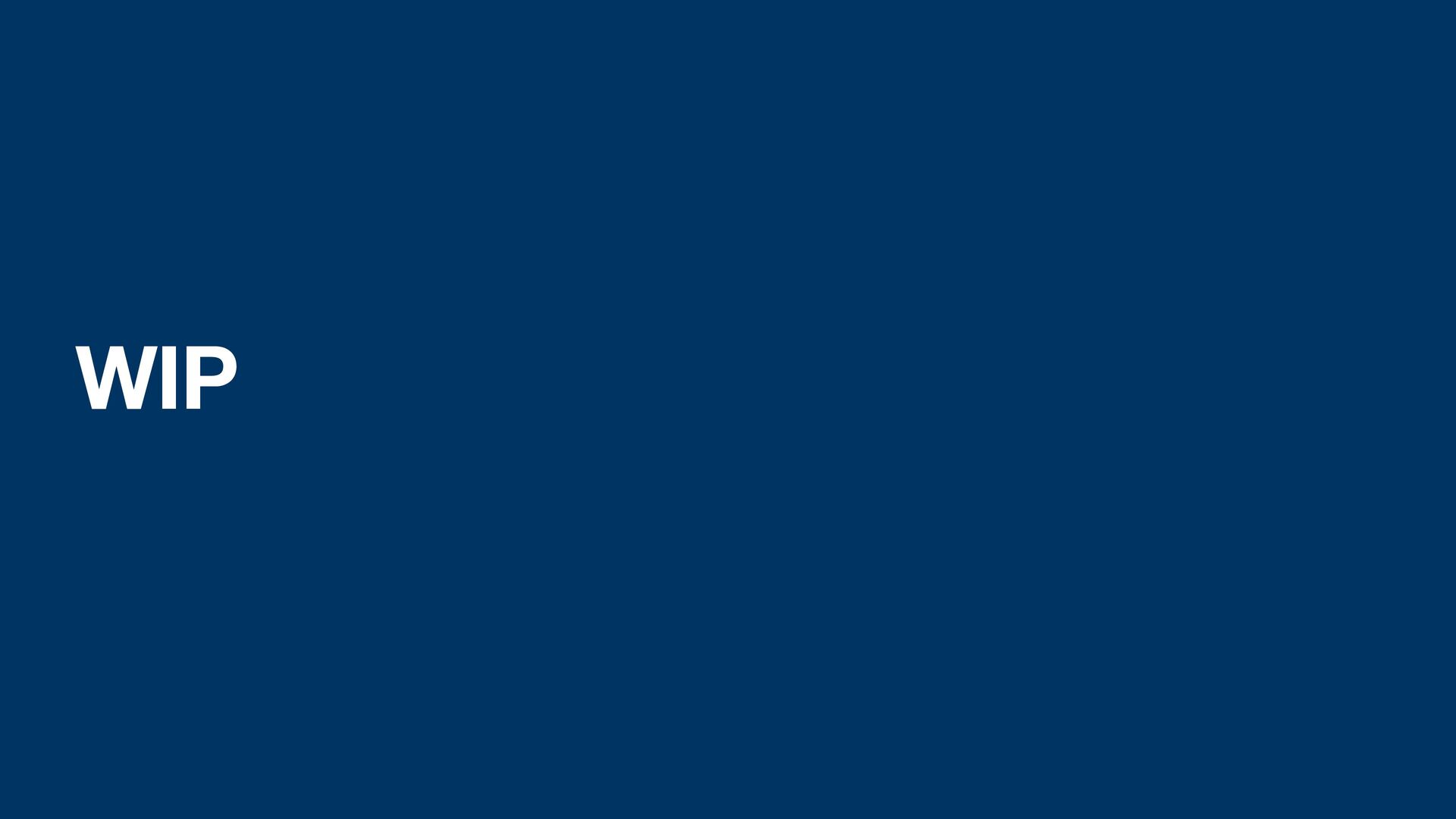

WIP

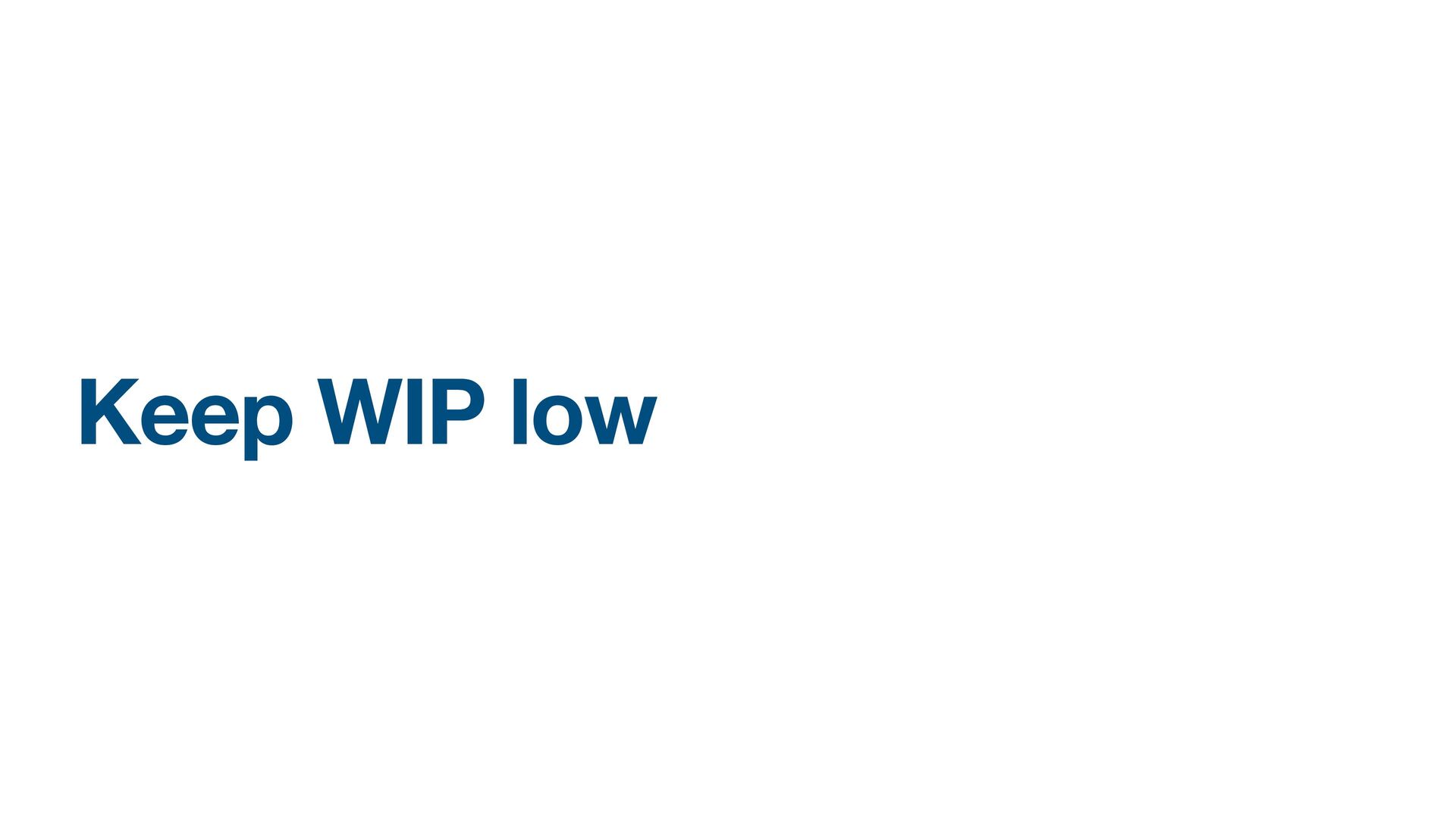

Keep WIP low

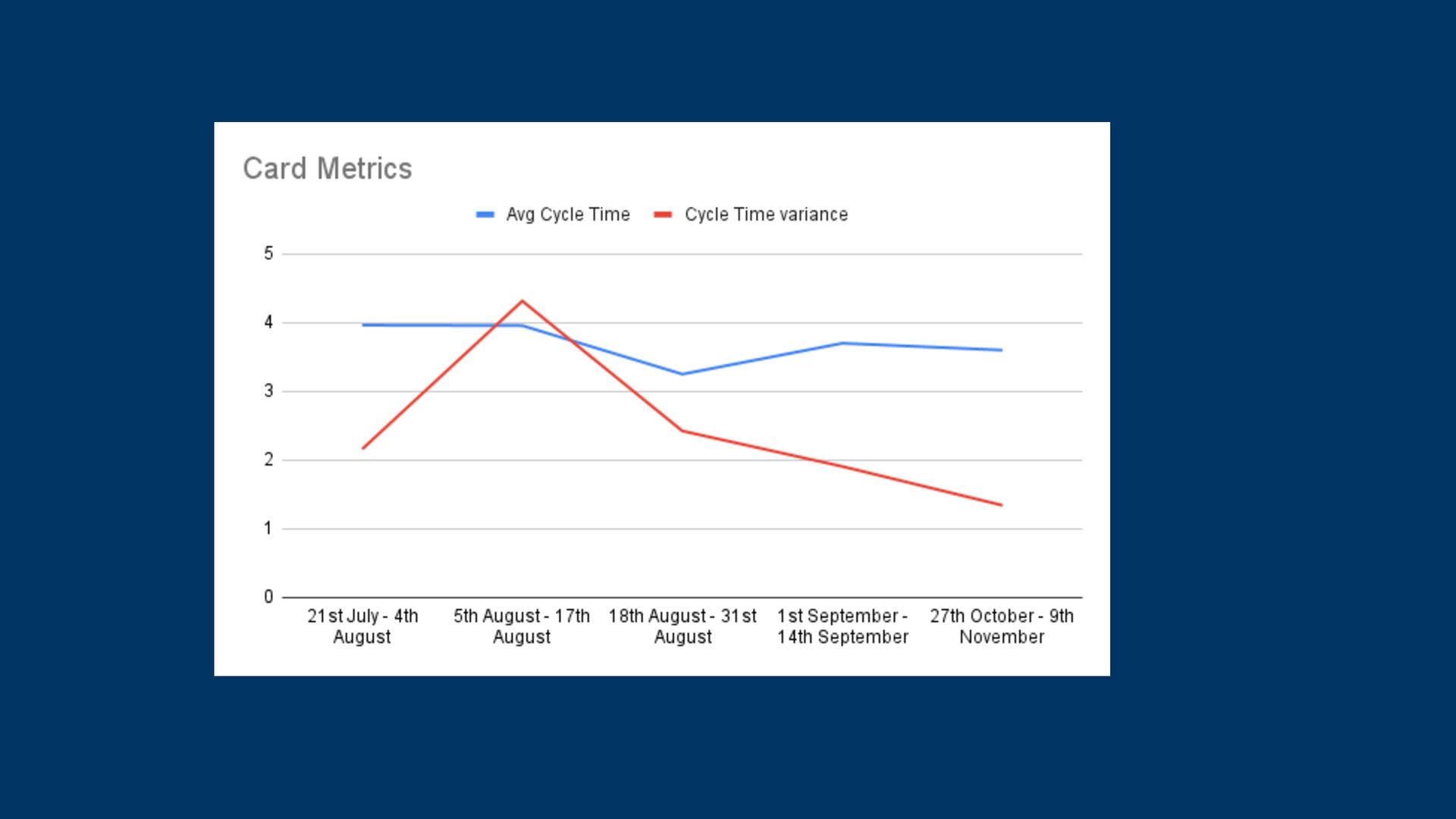

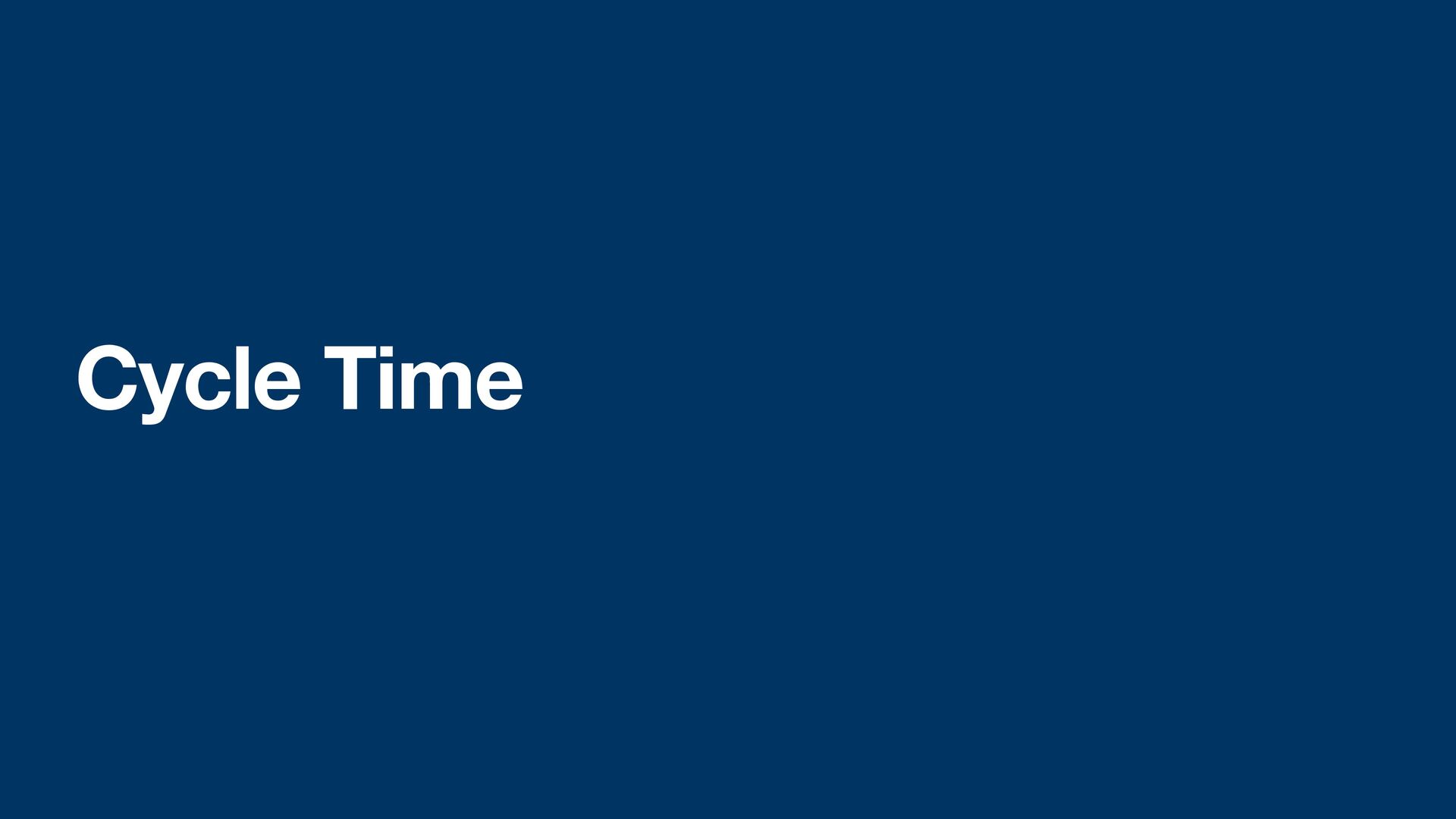

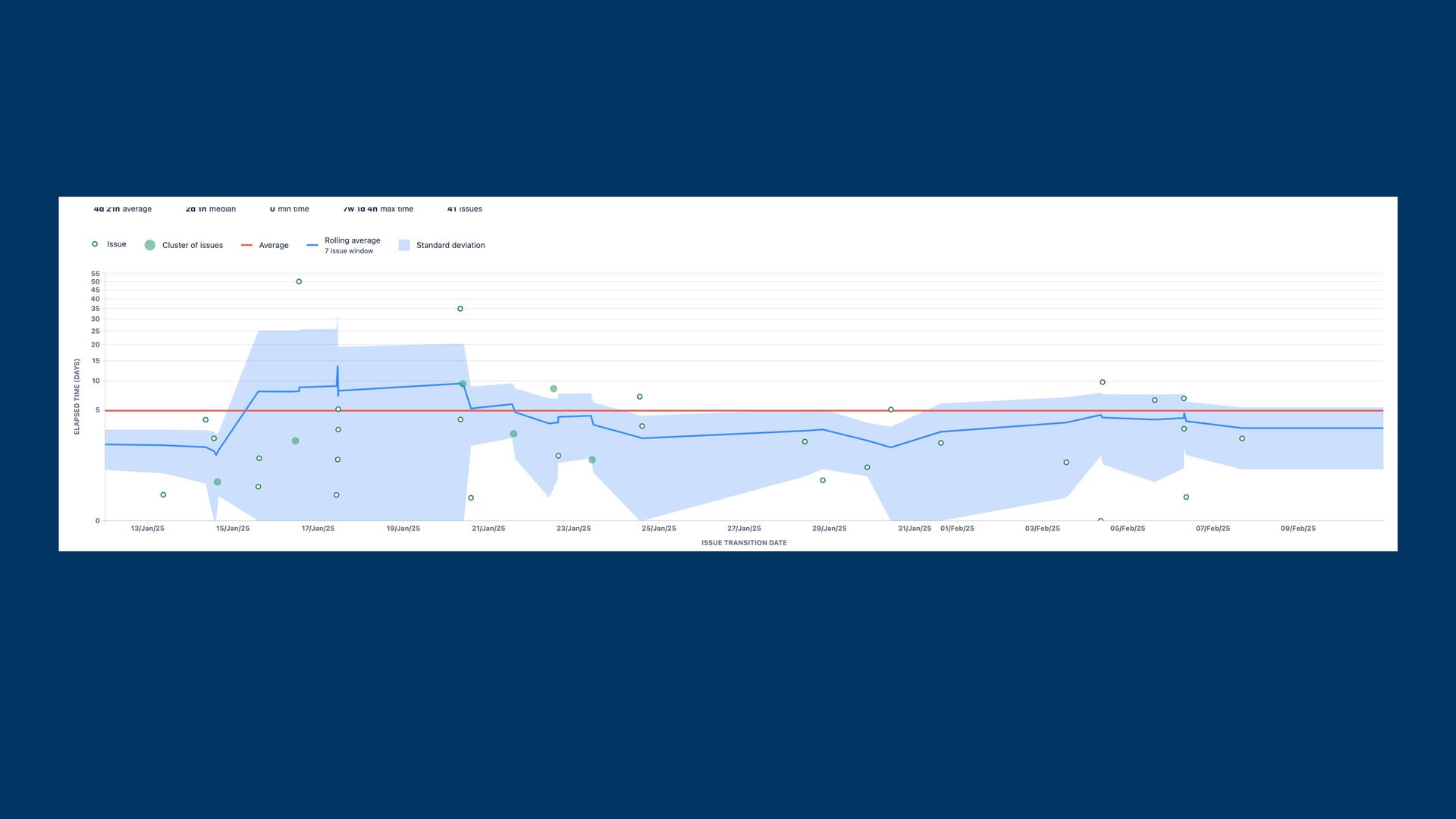

Cycle Time

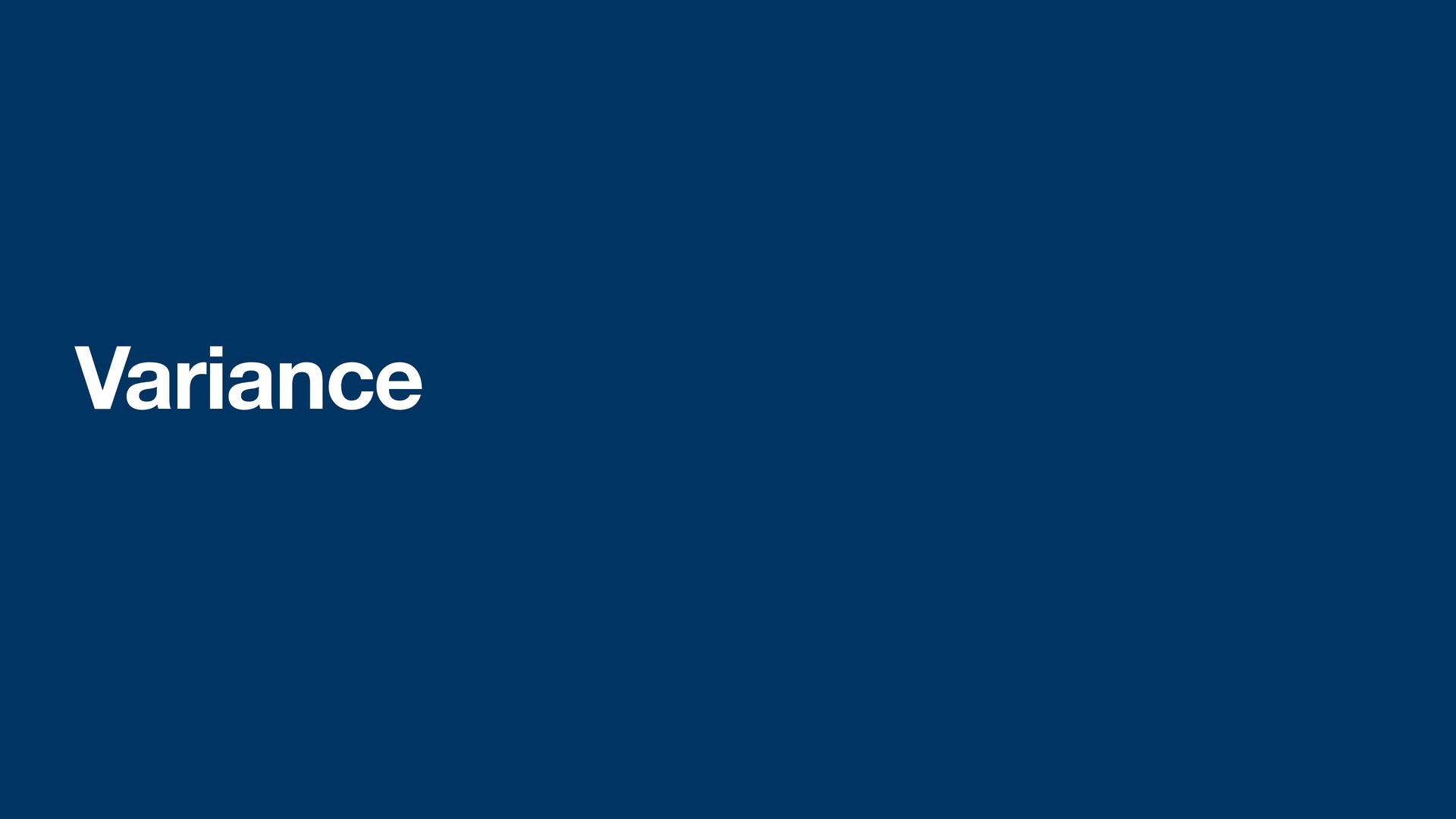

Variance
None
None

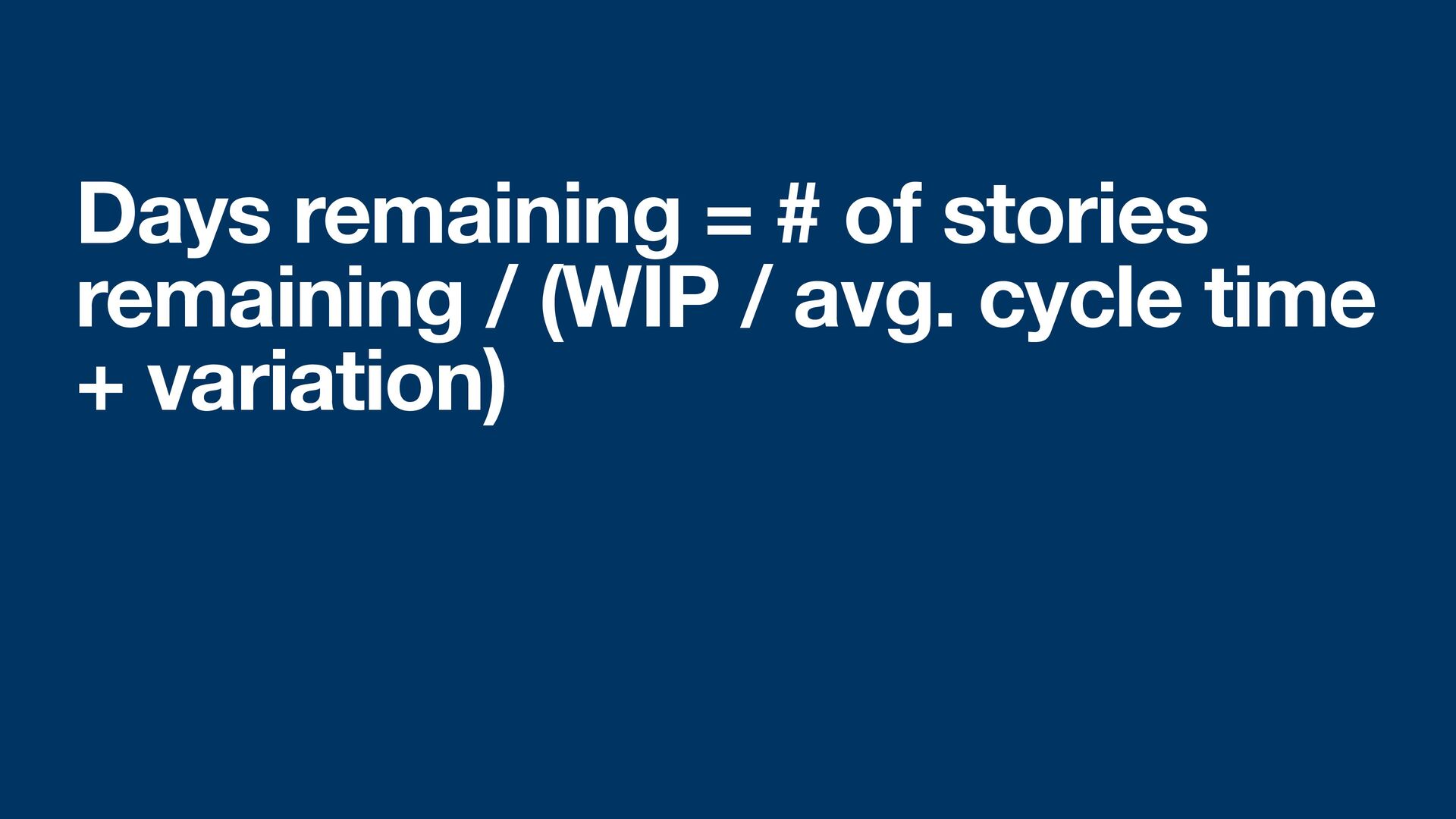

Days remaining = # of stories remaining / (WIP /
avg. cycle time + variation)
None

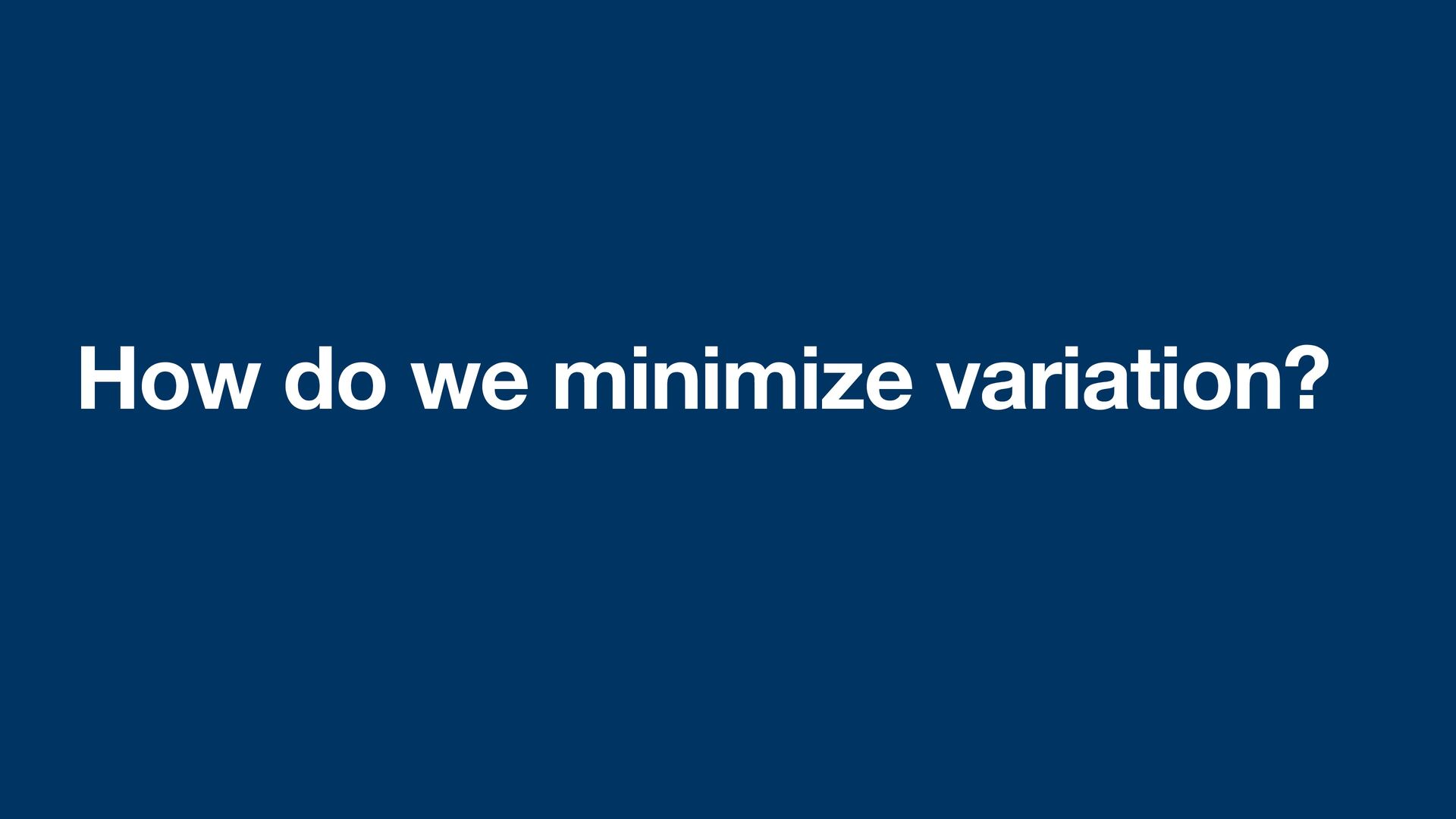

How do we minimize variation?

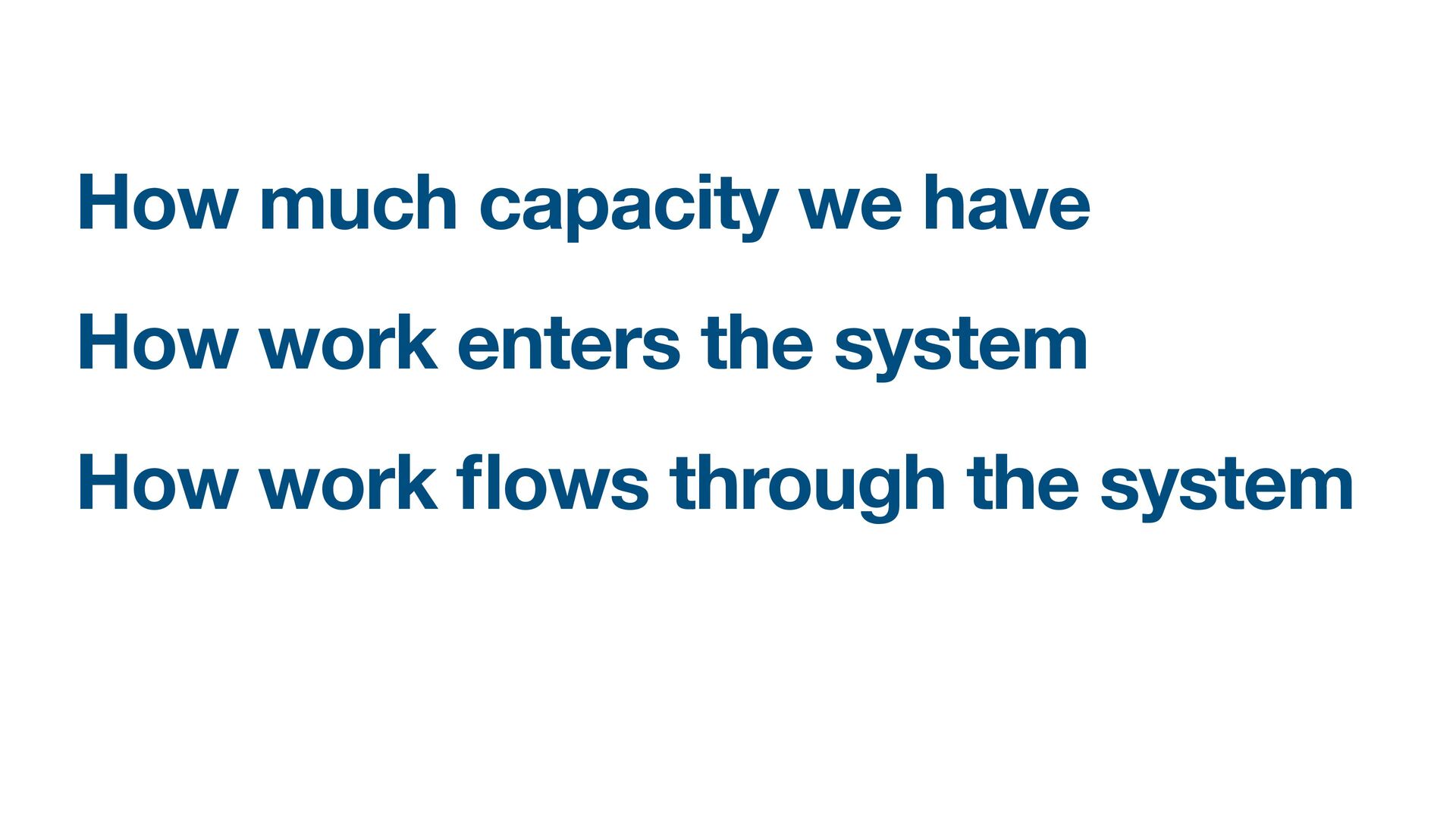

How much capacity we have How work enters the system
How work fl ows through the system
Slicing, Re fi nement, and Backlogs
None
Less rework Less risk Less time spent in meetings

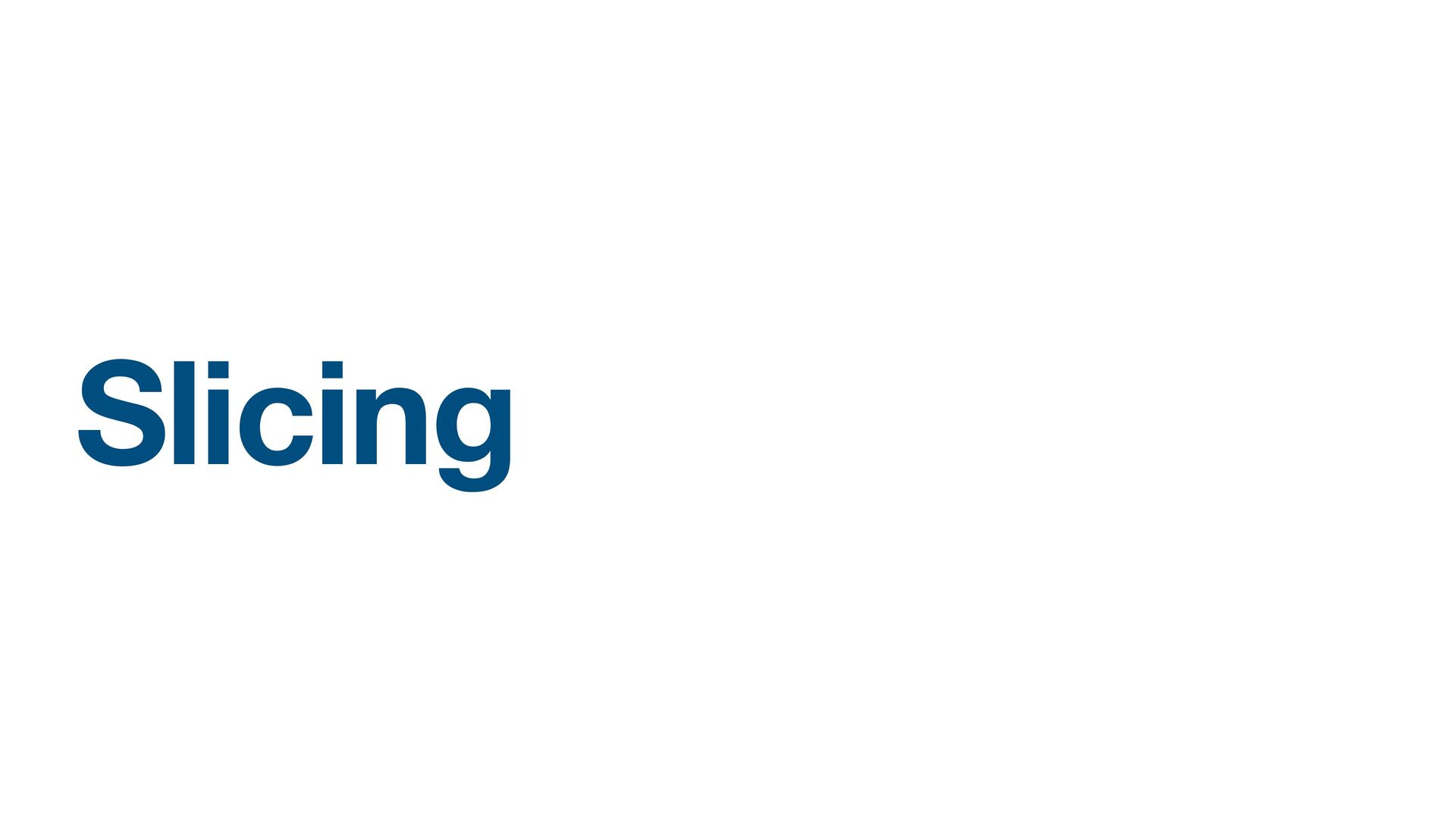

Slicing
None
Is it 3 days worth of work?

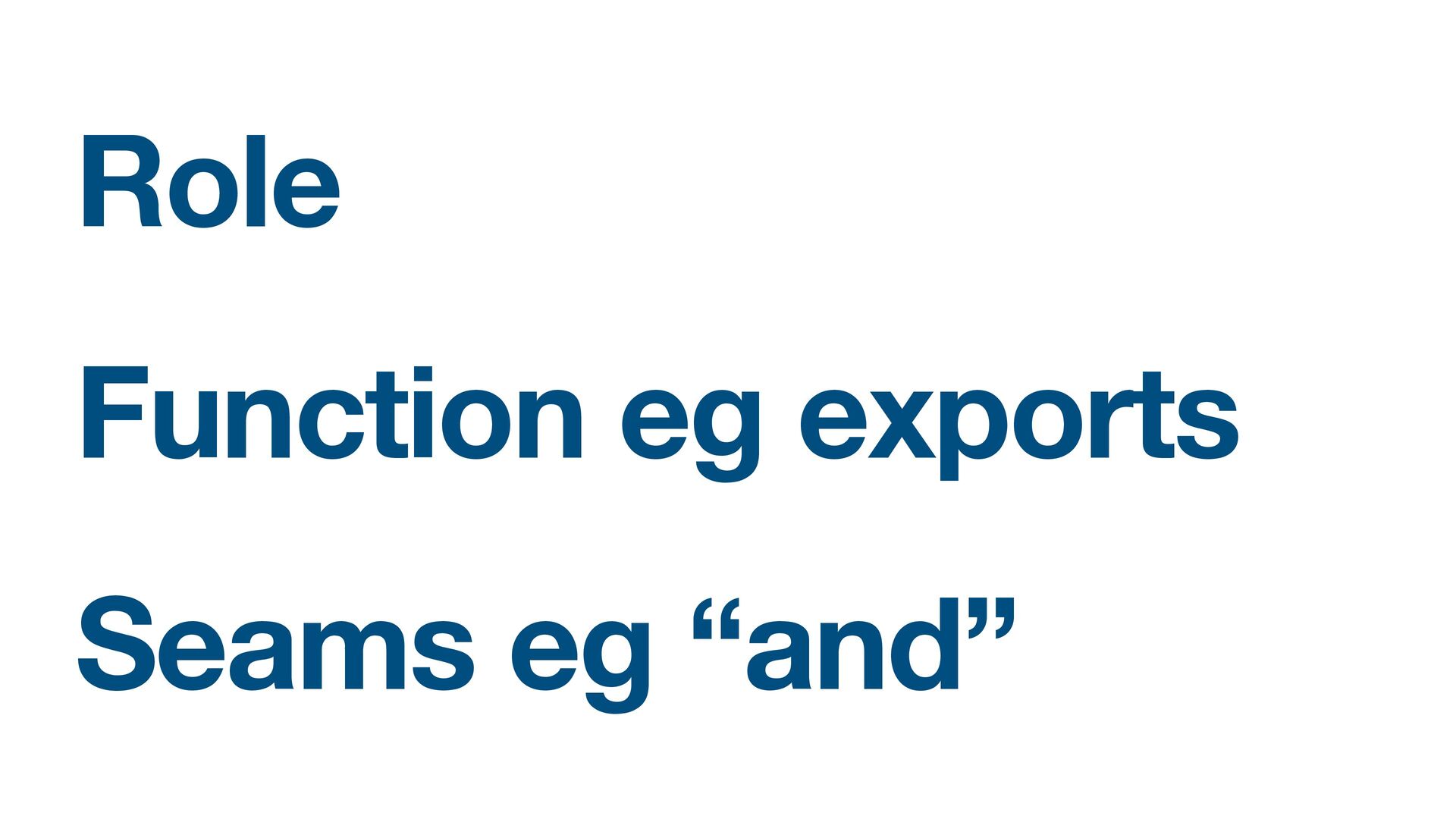

Role Function eg exports Seams eg “and”

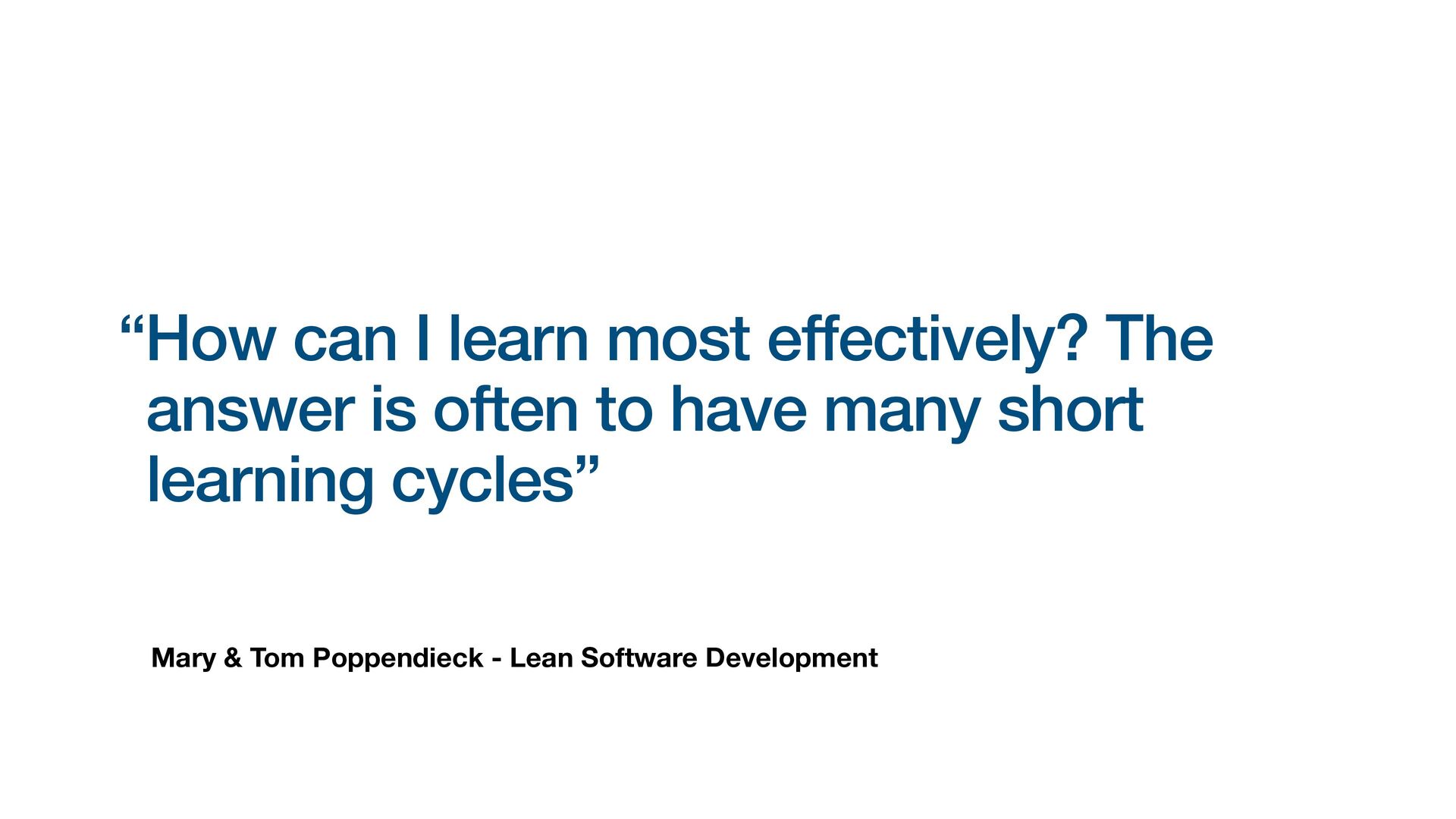

Mary & Tom Poppendieck - Lean Software Development “How can
I learn most effectively? The answer is often to have many short learning cycles”

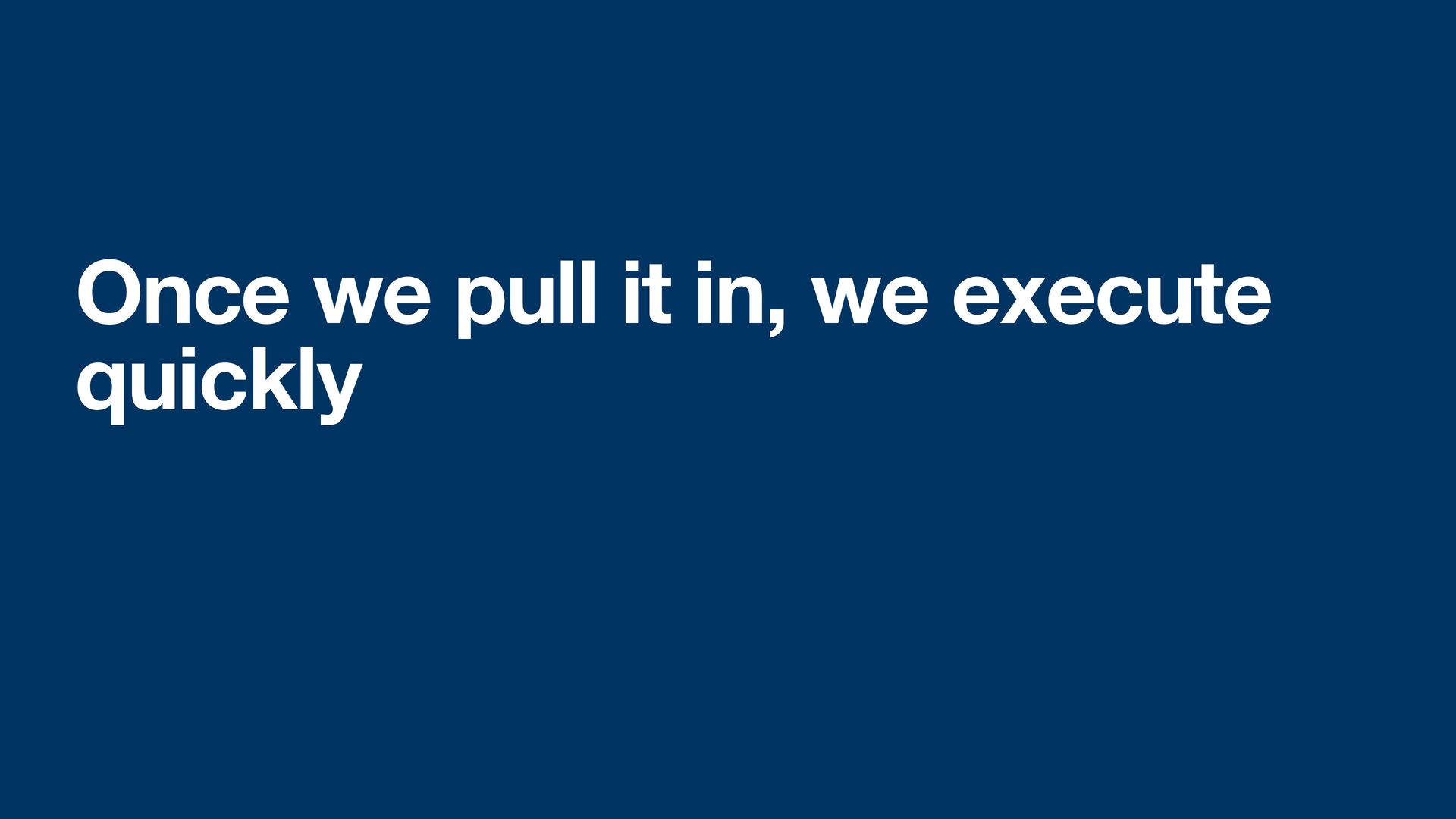

Once we pull it in, we execute quickly

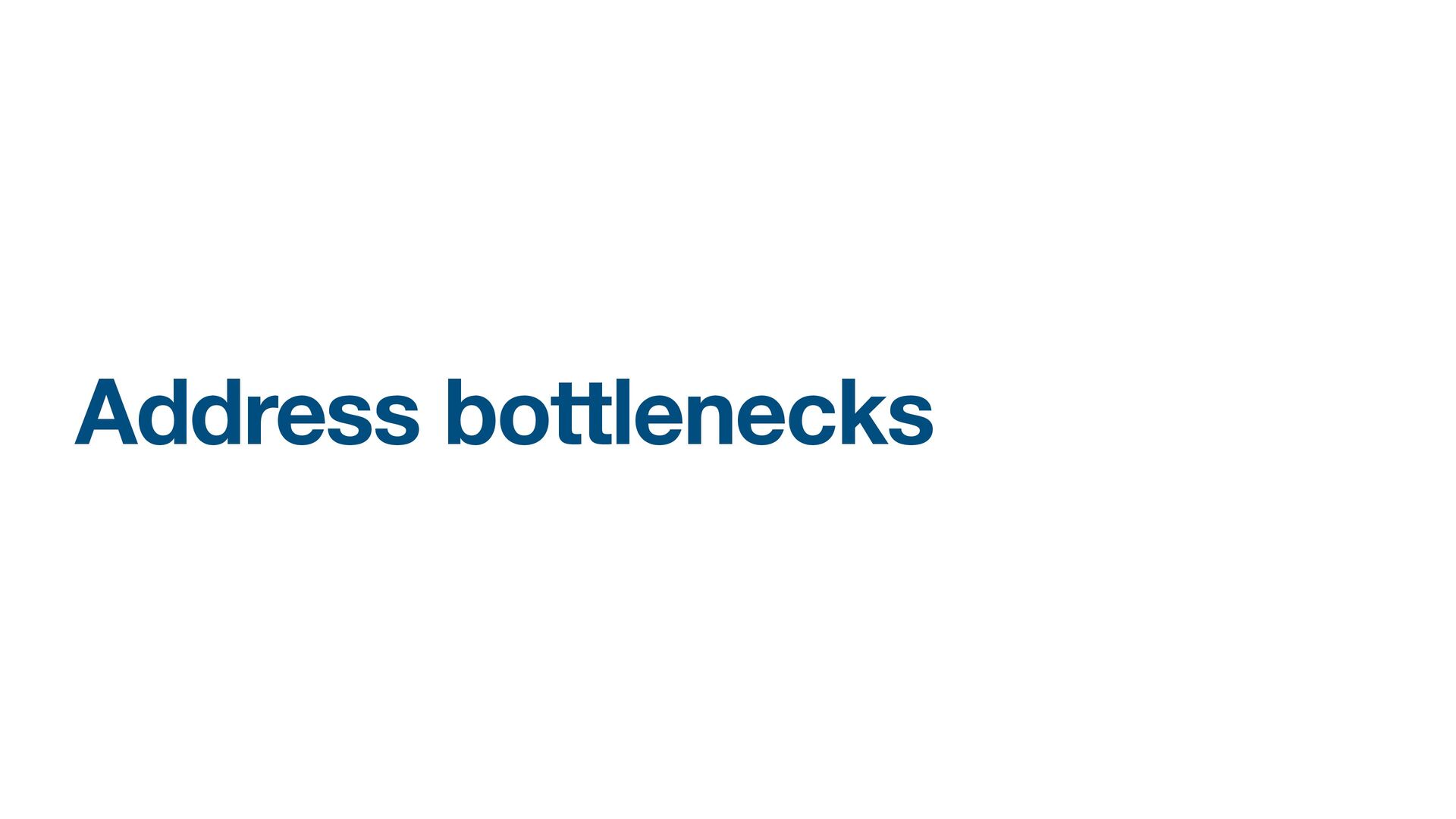

Address bottlenecks
None
None
Swarm

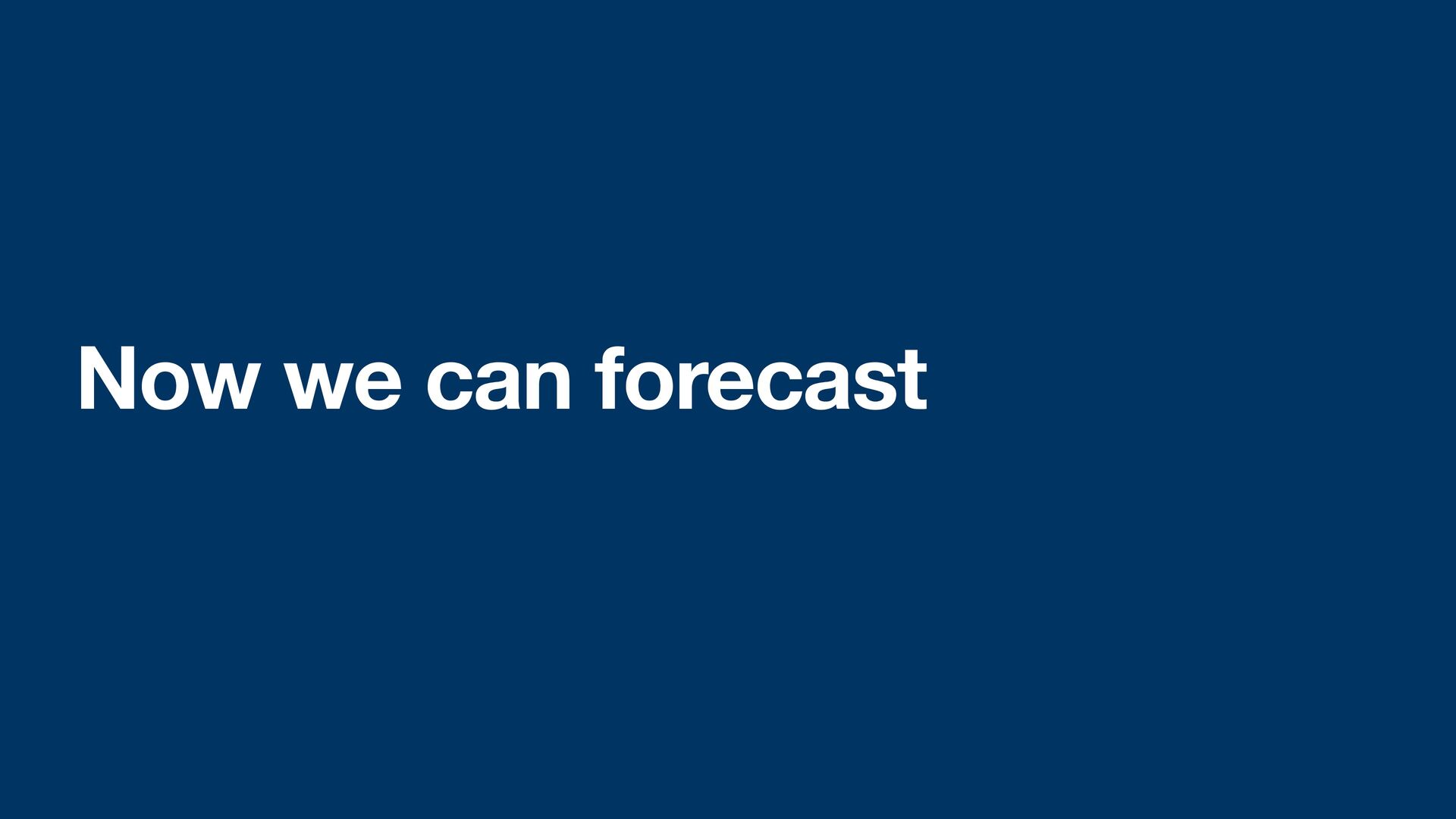

Now we can forecast
None
None

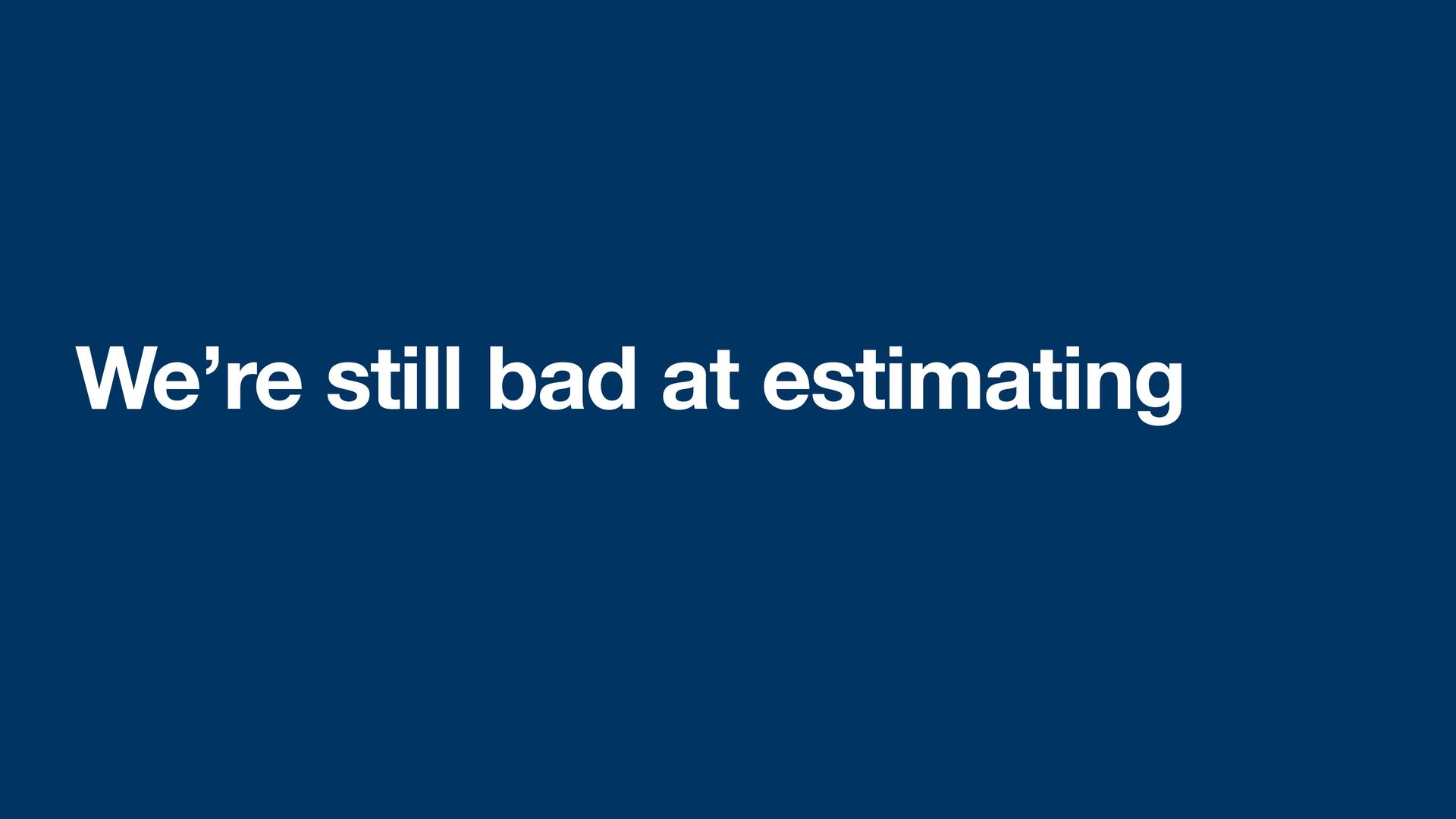

We’re still bad at estimating

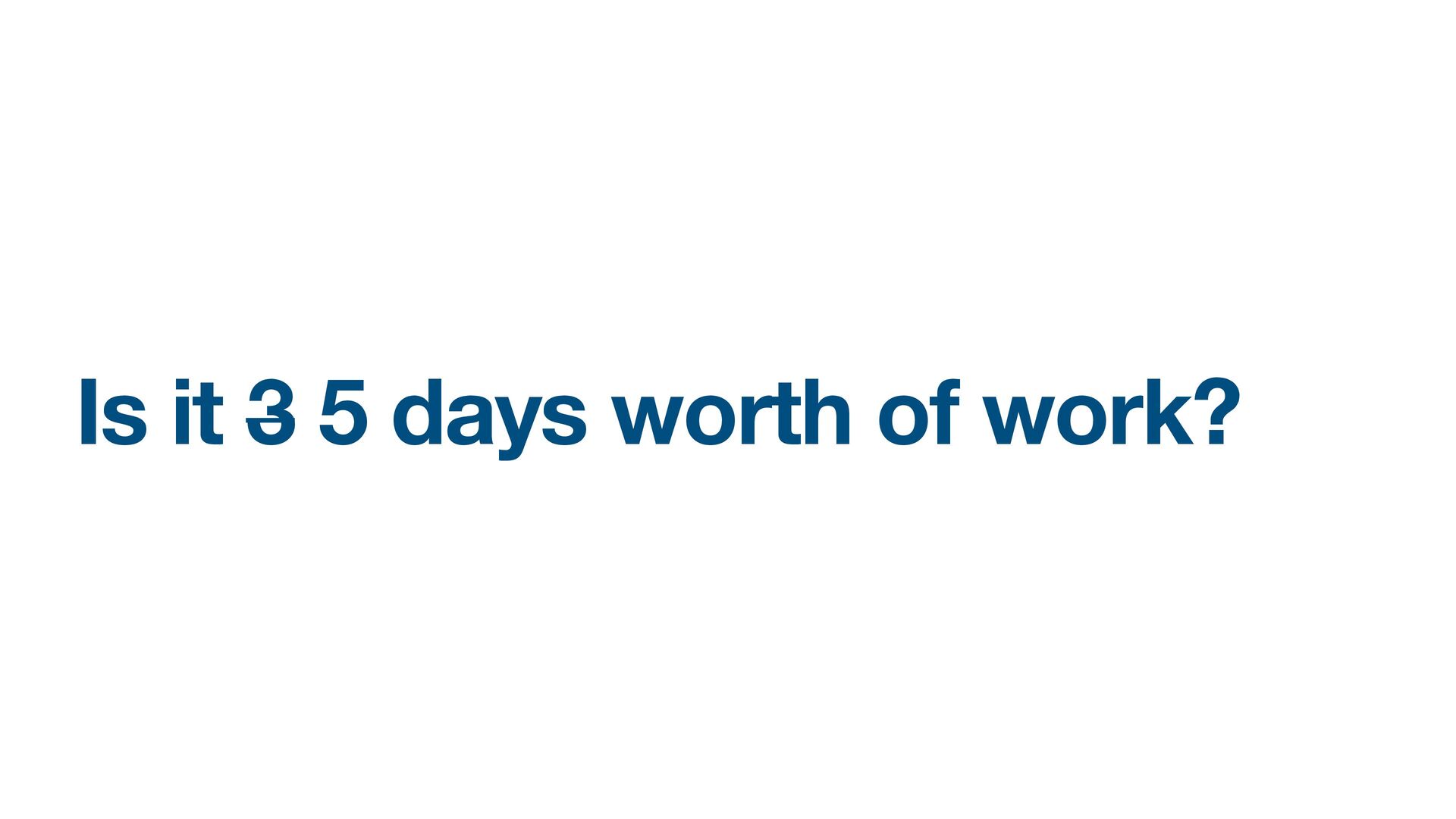

Is it 3 5 days worth of work?

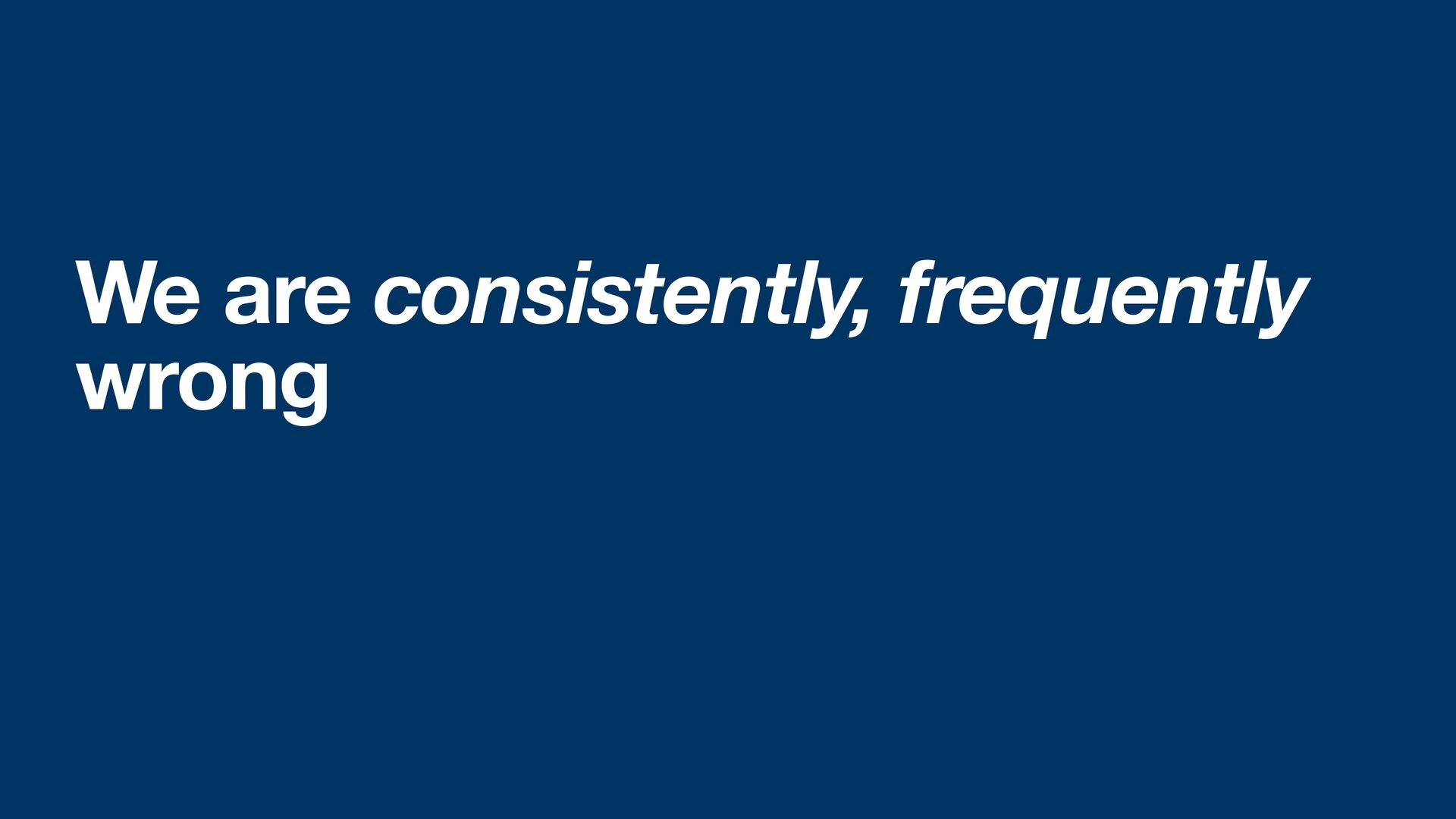

We are consistently, frequently wrong

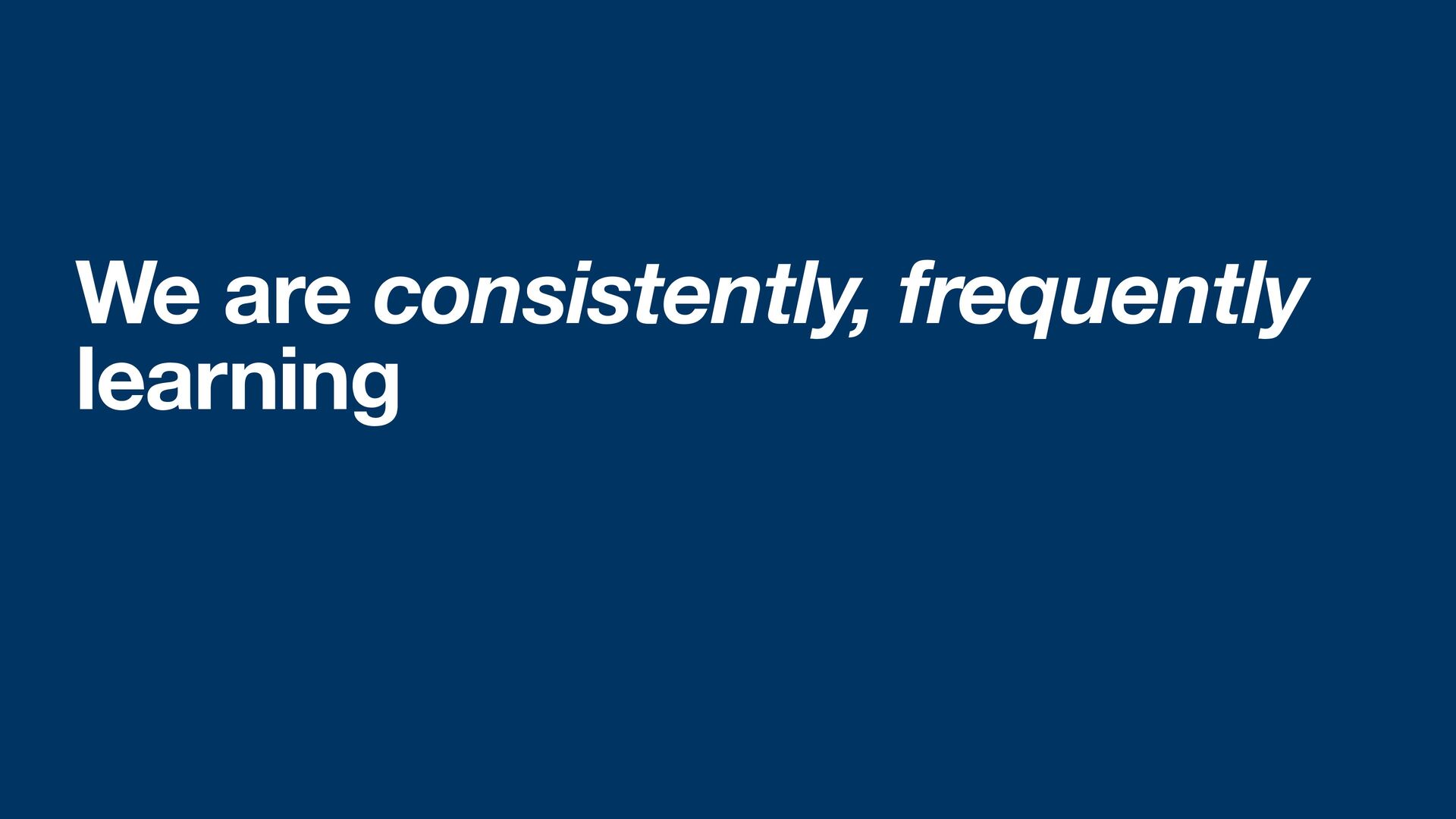

We are consistently, frequently learning

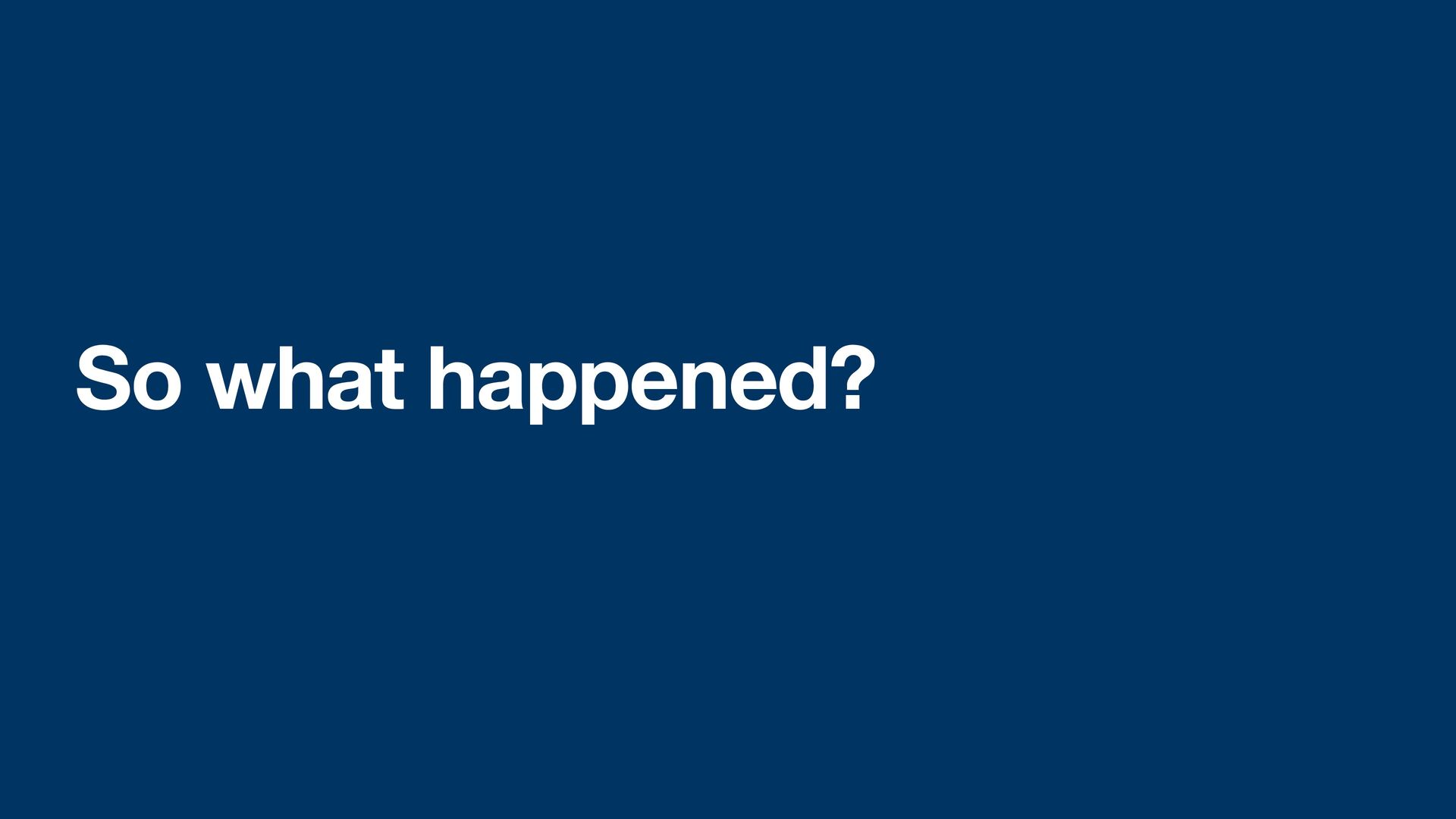

So what happened?
None

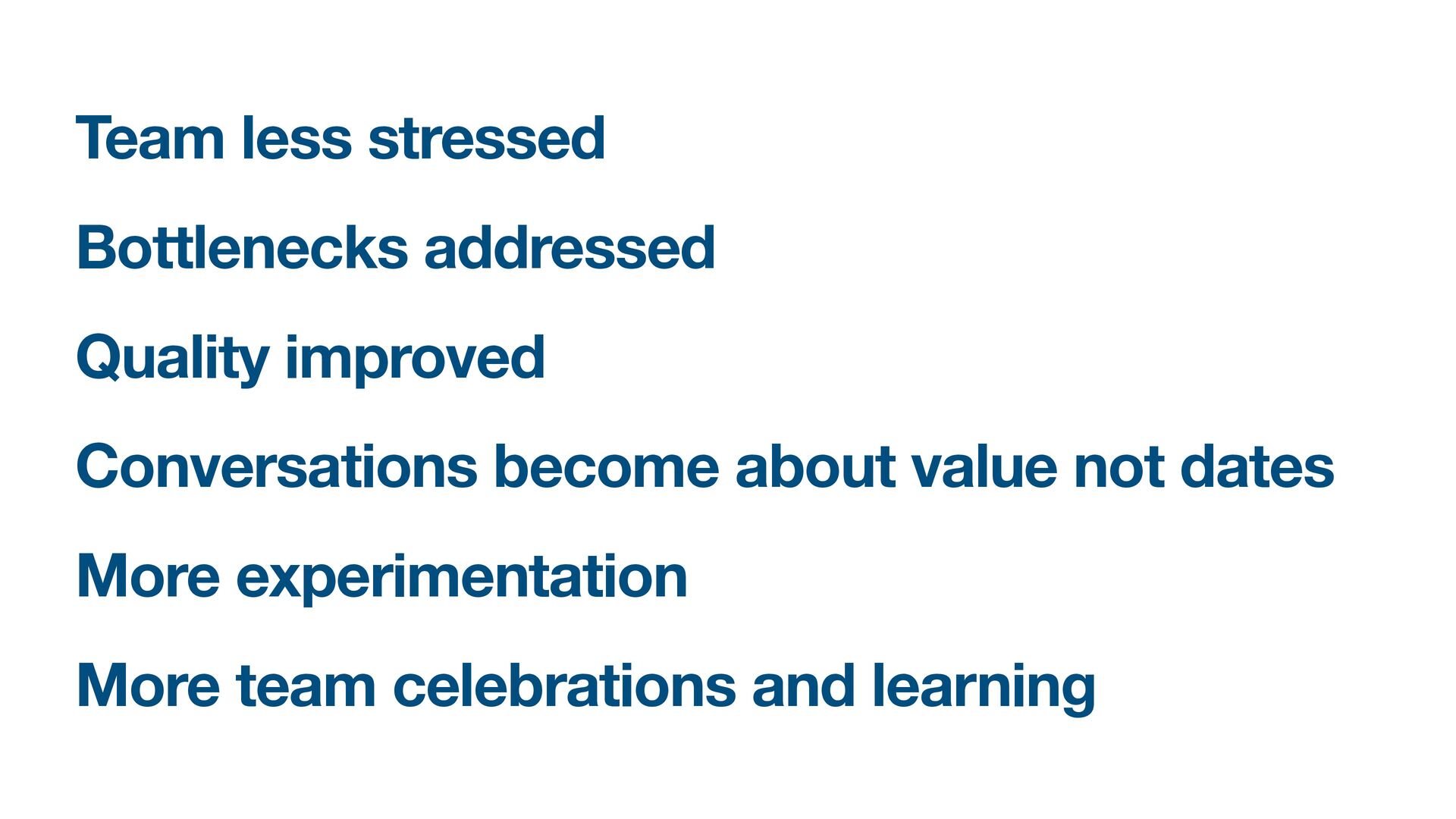

Team less stressed Bottlenecks addressed Quality improved Conversations become about
value not dates More experimentation More team celebrations and learning

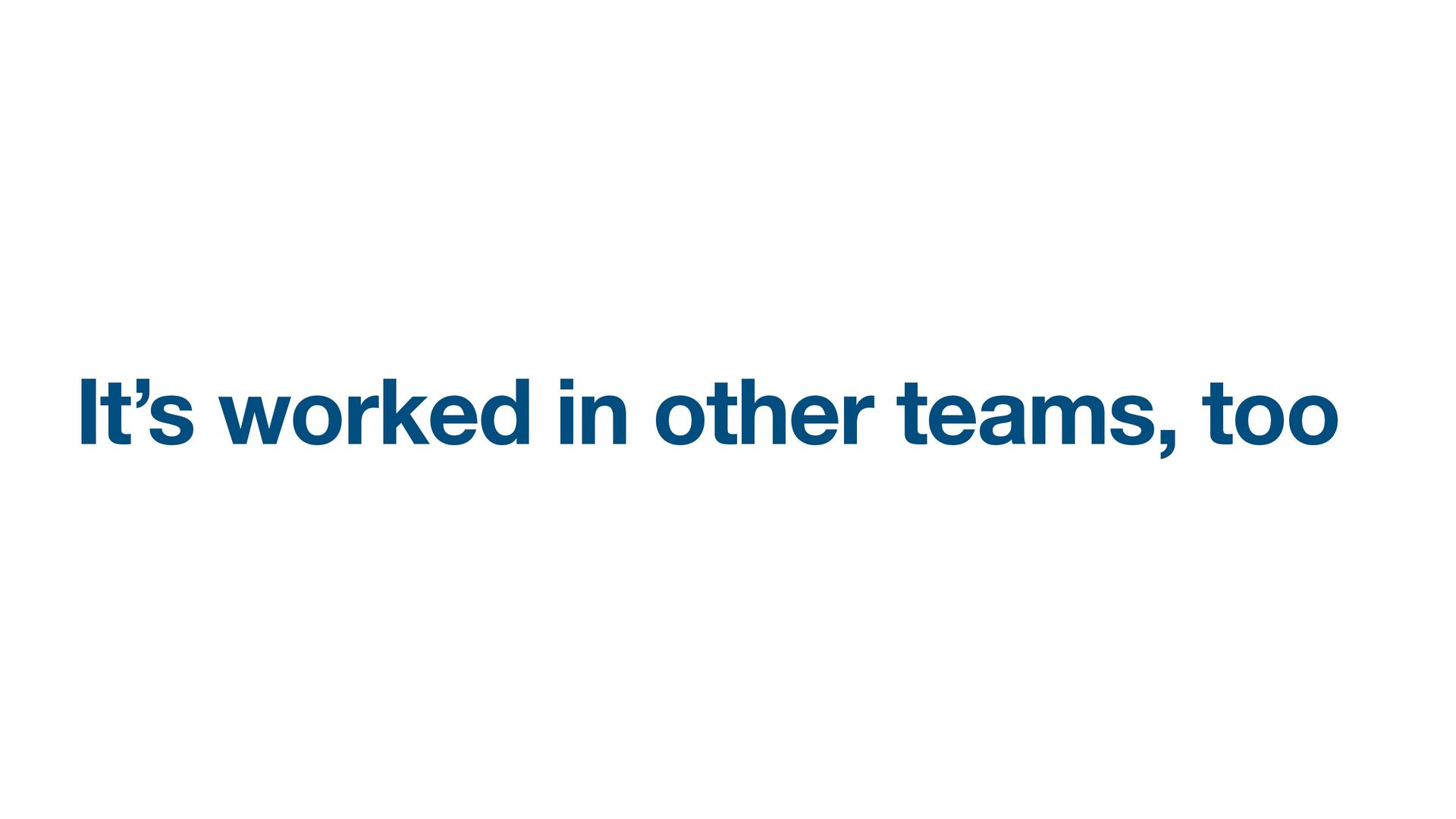

It’s worked in other teams, too

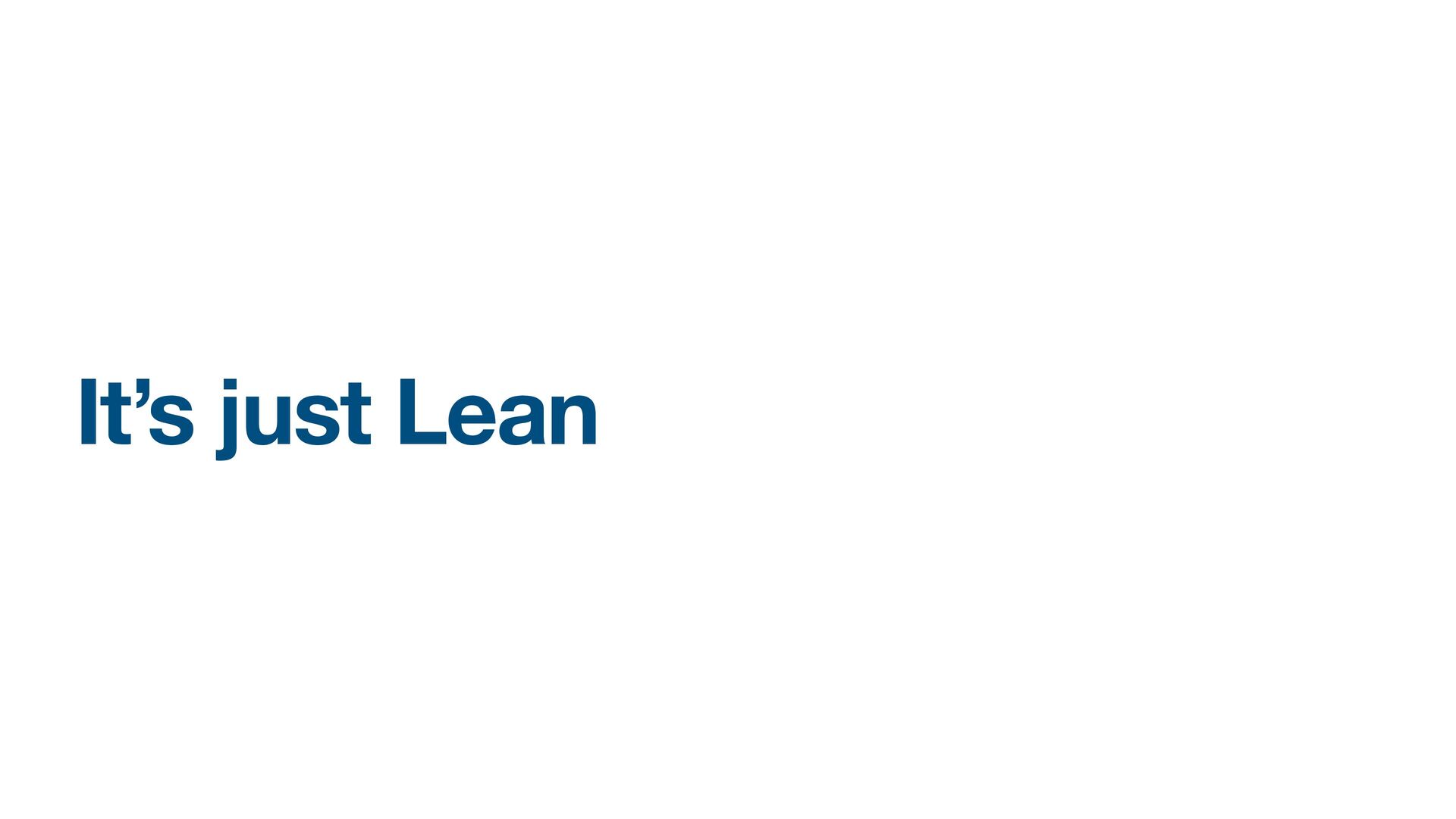

It’s just Lean

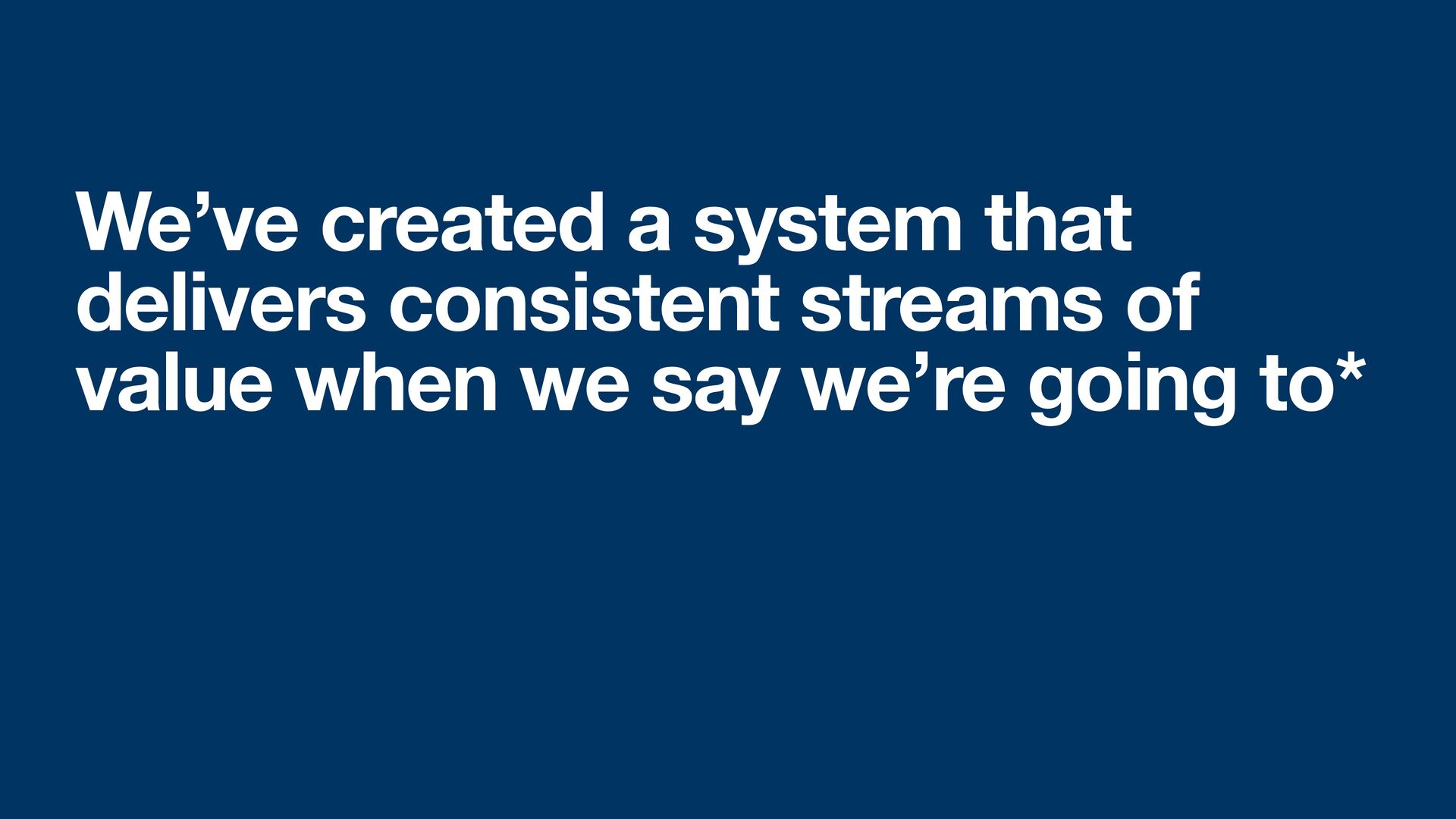

We’ve created a system that delivers consistent streams of value
when we say we’re going to*

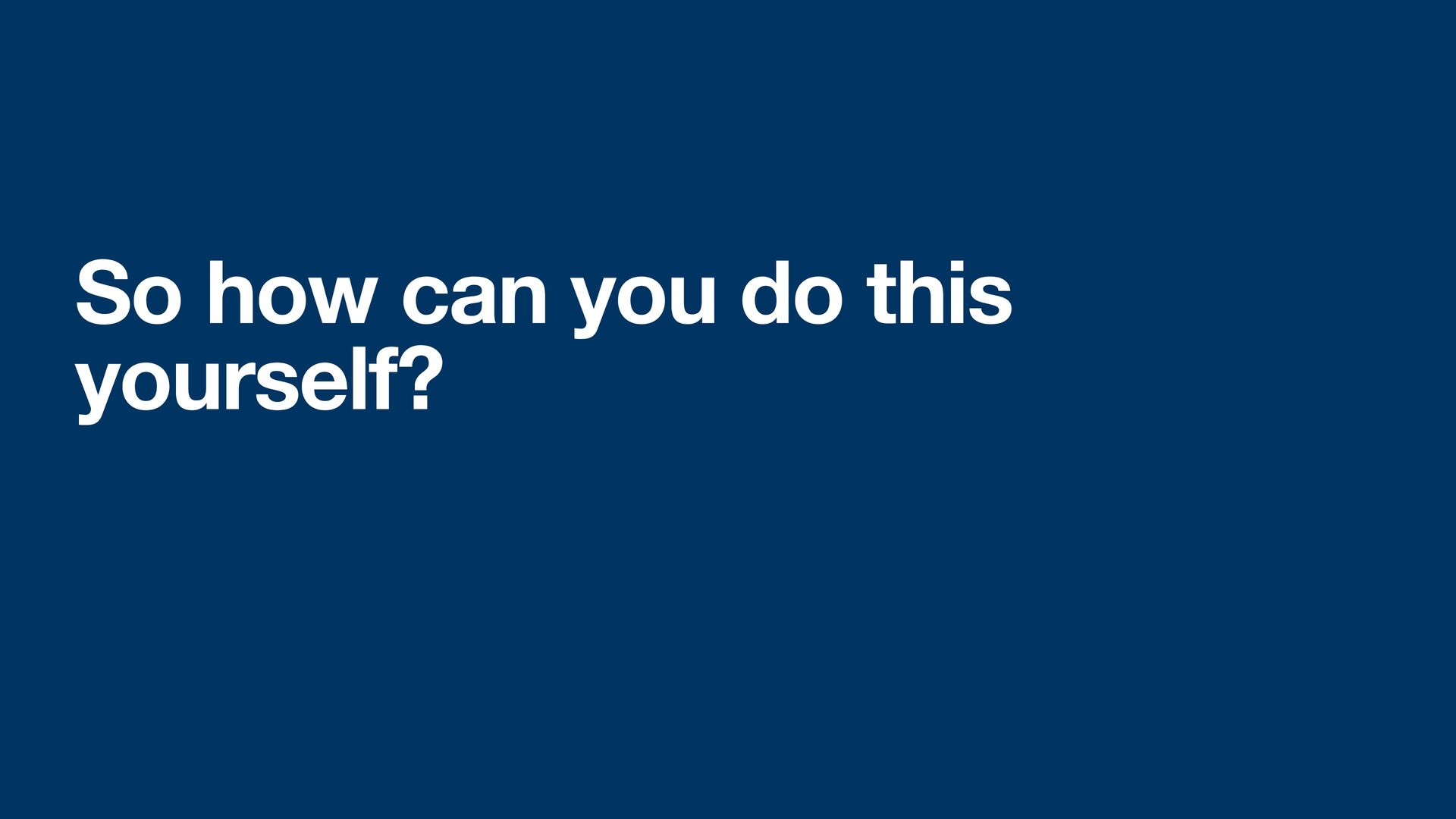

So how can you do this yourself?

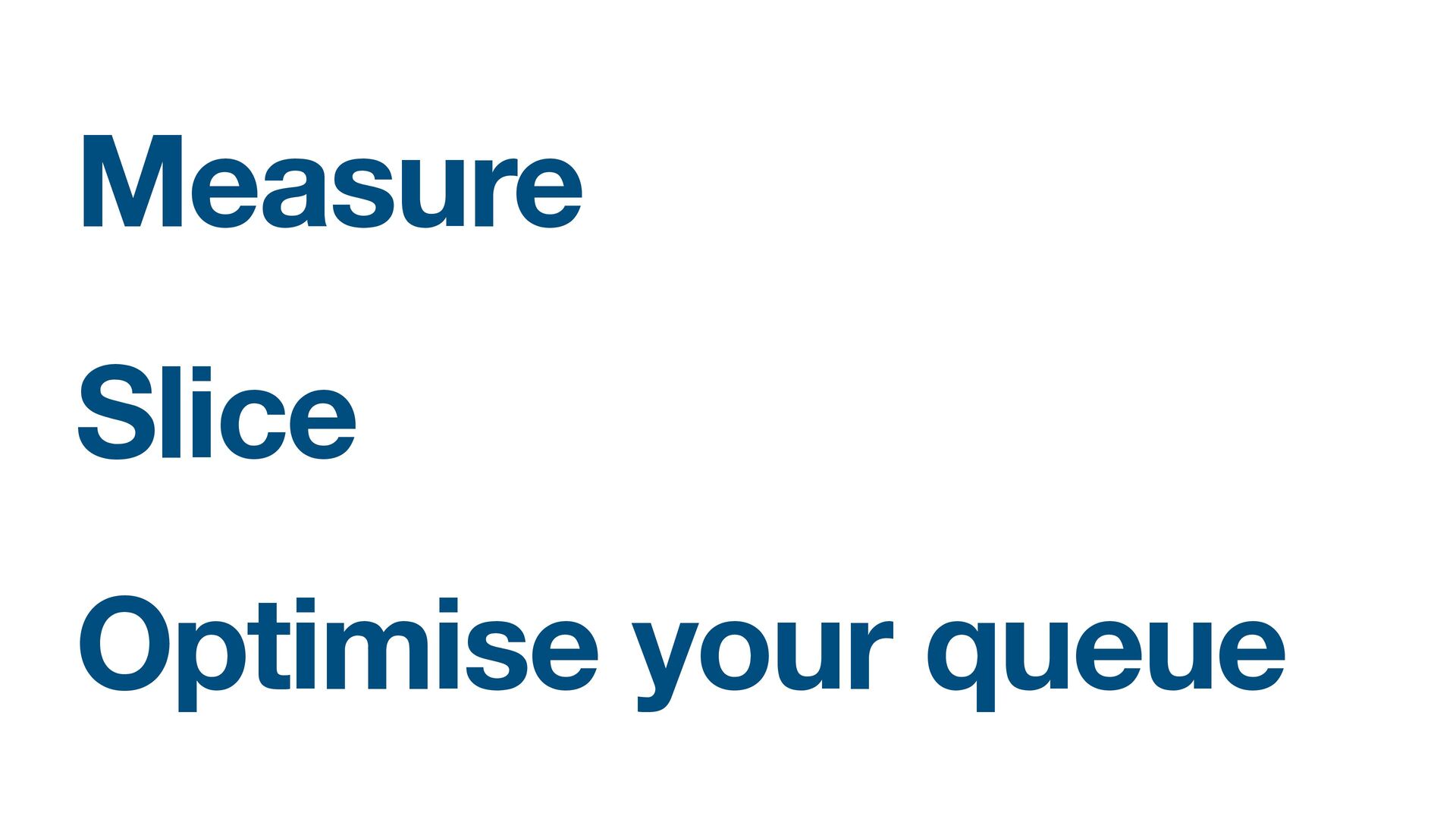

Measure Slice Optimise your queue

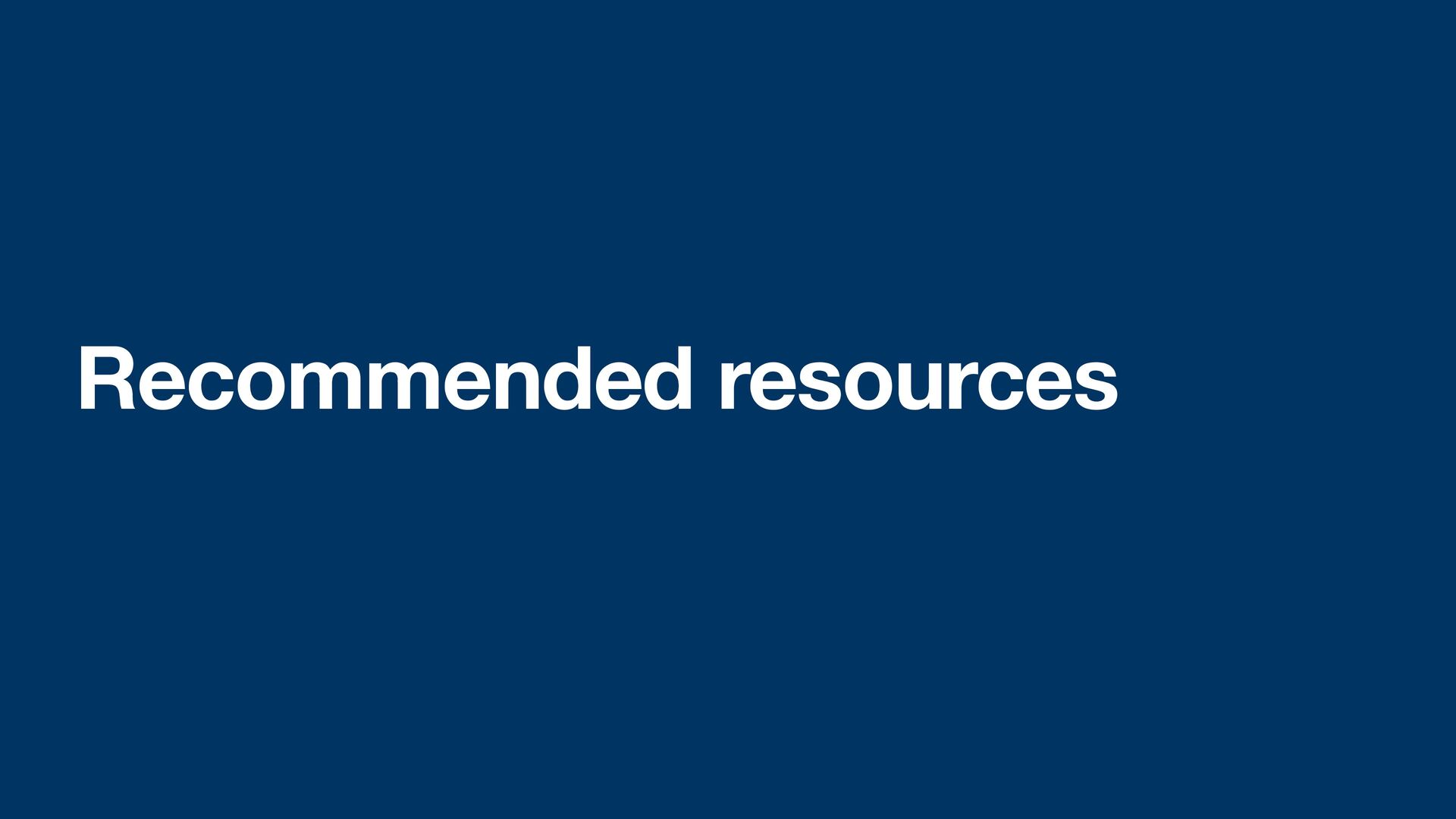

Recommended resources

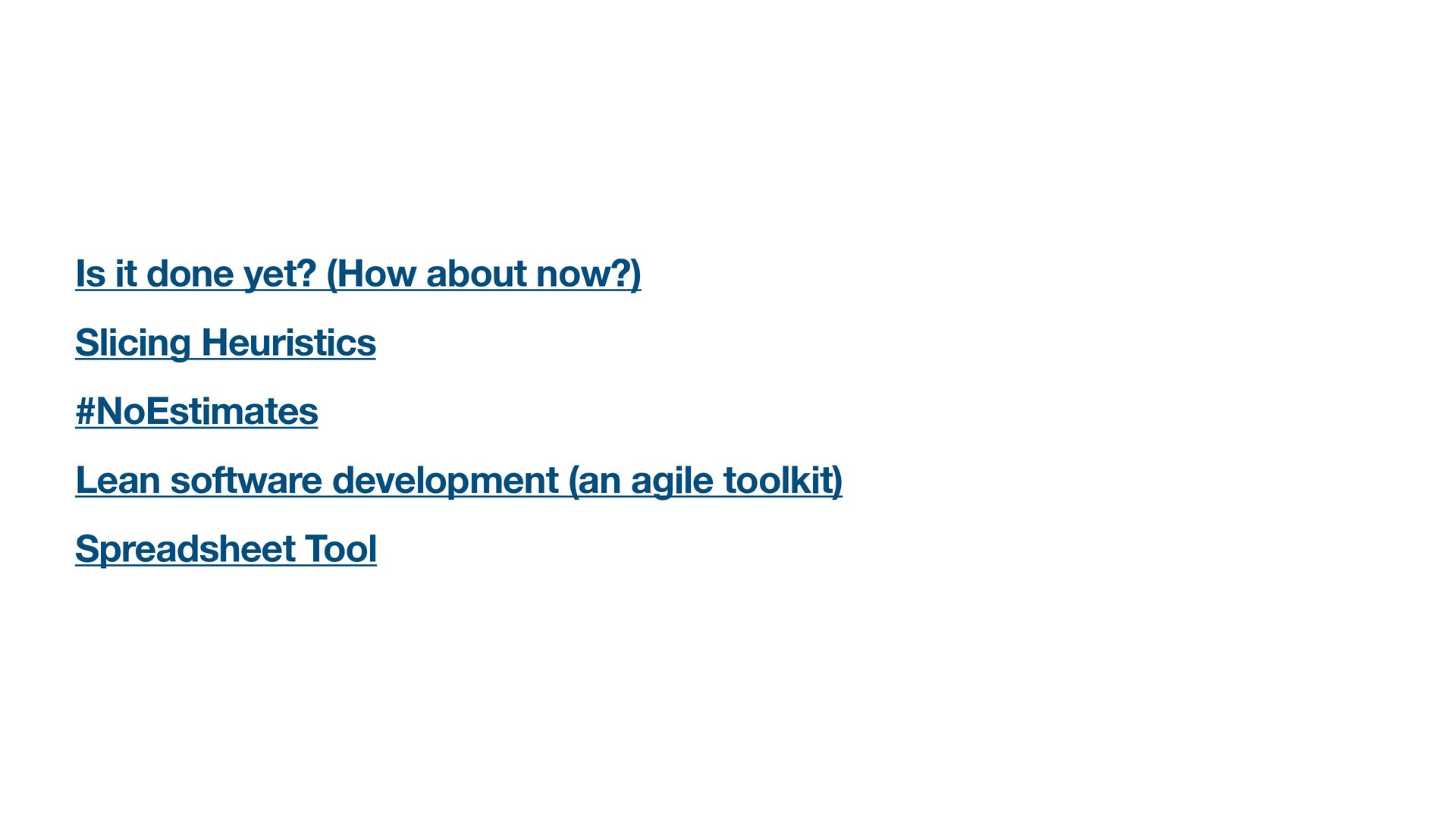

Is it done yet? (How about now?) Slicing Heuristics #NoEstimates
Lean software development (an agile toolkit) Spreadsheet Tool
Tom Ridge Sta ff Engineer Culture Amp Father D&D Nerd
Has Attack Eyebrows tom-j-ridge
Proudly sponsored by
