Common Solar Installation Mistakes Businesses Should Avoid

A commercial solar plant fails in slow motion, more often than on day one. The inverter turns on. The first bill is more attractive. And then year-one generation is 15–30 percent below proposal, because a water tank shadows a string every winter afternoon, the roof was never checked for load, or the cheapest bid used thin structure and mixed cables. It’s installation and design flaws, not “solar doesn’t work.”

Avatar for Sadik

Sadik

September 24, 2026

More Decks by Sadik

Other Decks in Technology

Transcript

  1. Common Solar Installation Mistakes Businesses Should Avoid A commercial solar

    plant rarely fails on day one — it fails in slow motion. The inverter turns on, the first bill looks promising, and then year-one generation lands 15–30% below proposal. A water tank shadows a string every winter afternoon, the roof was never checked for load, or the cheapest bid used thin structure and mixed cables. These are installation and design flaws — not proof that "solar doesn't work." This guide is your field reference for avoiding them.

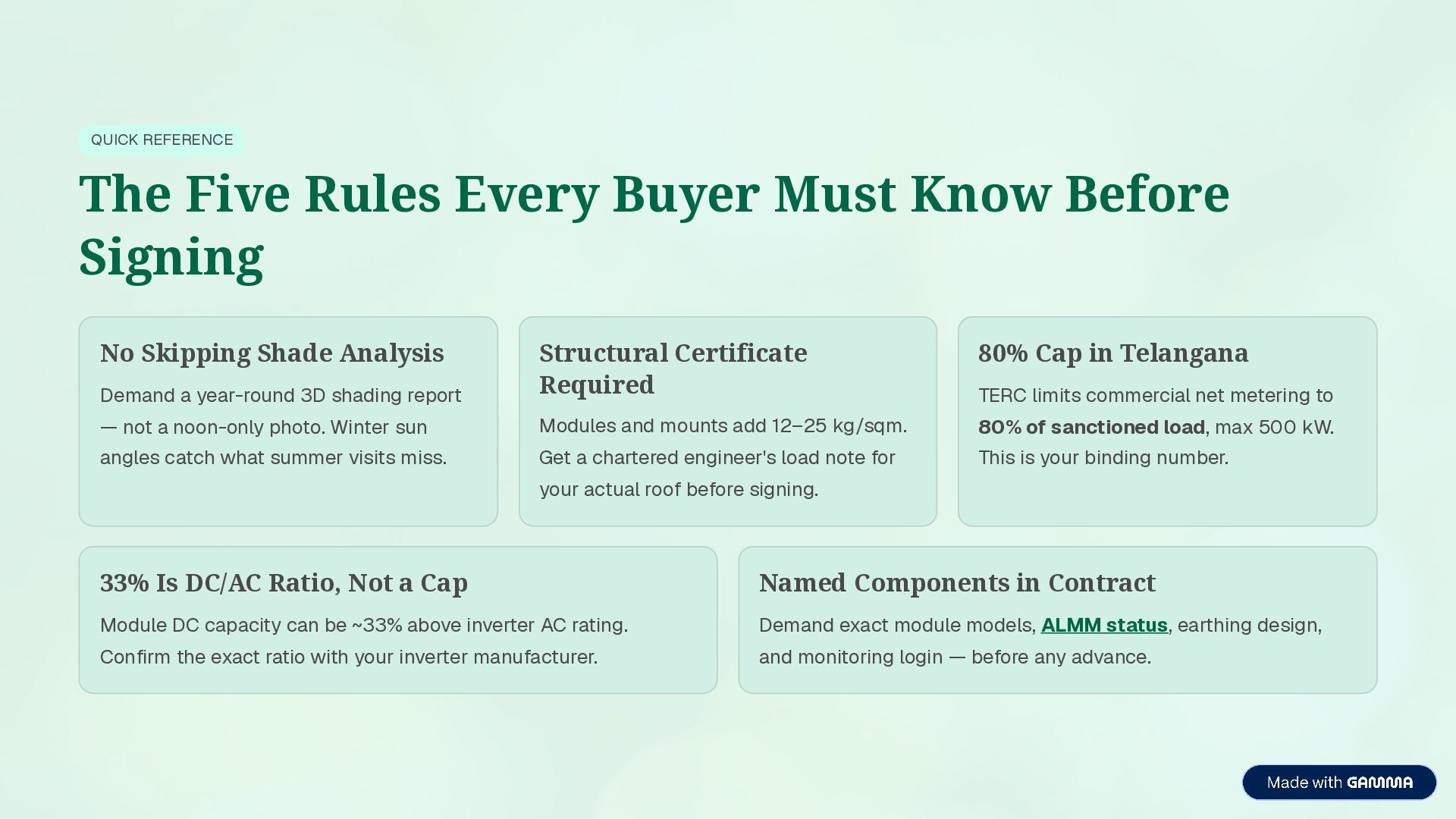

  2. QUICK REFERENCE The Five Rules Every Buyer Must Know Before

    Signing No Skipping Shade Analysis 80% Cap in Telangana Demand a year-round 3D shading report Structural Certificate Required — not a noon-only photo. Winter sun Modules and mounts add 12–25 kg/sqm. 80% of sanctioned load, max 500 kW. angles catch what summer visits miss. Get a chartered engineer's load note for This is your binding number. TERC limits commercial net metering to your actual roof before signing. 33% Is DC/AC Ratio, Not a Cap Named Components in Contract Module DC capacity can be ~33% above inverter AC rating. Demand exact module models, ALMM status, earthing design, Confirm the exact ratio with your inverter manufacturer. and monitoring login — before any advance.

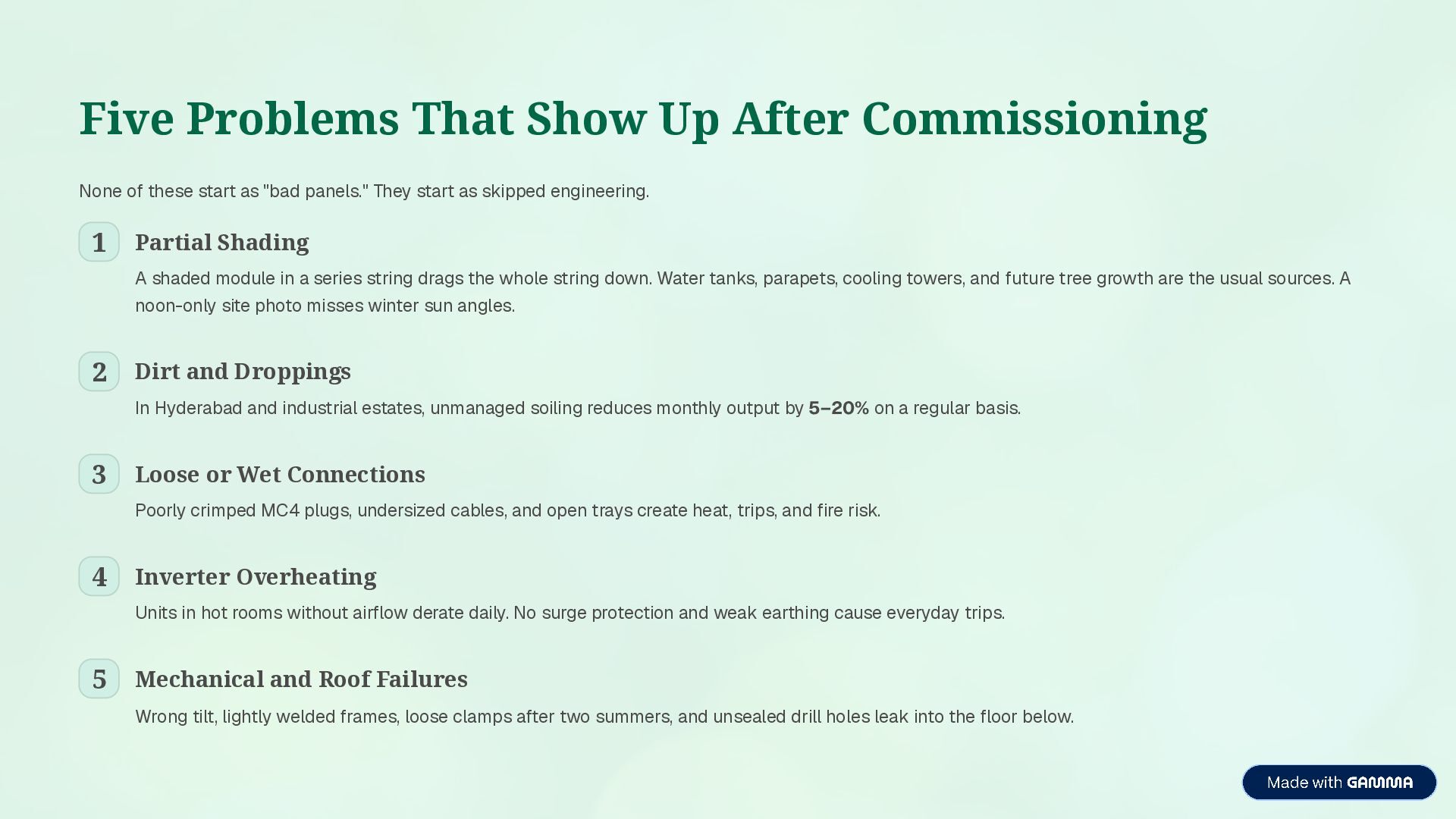

  3. Five Problems That Show Up After Commissioning None of these

    start as "bad panels." They start as skipped engineering. 1 Partial Shading A shaded module in a series string drags the whole string down. Water tanks, parapets, cooling towers, and future tree growth are the usual sources. A noon-only site photo misses winter sun angles. 2 Dirt and Droppings In Hyderabad and industrial estates, unmanaged soiling reduces monthly output by 5–20% on a regular basis. 3 Loose or Wet Connections Poorly crimped MC4 plugs, undersized cables, and open trays create heat, trips, and fire risk. 4 Inverter Overheating Units in hot rooms without airflow derate daily. No surge protection and weak earthing cause everyday trips. 5 Mechanical and Roof Failures Wrong tilt, lightly welded frames, loose clamps after two summers, and unsealed drill holes leak into the floor below.

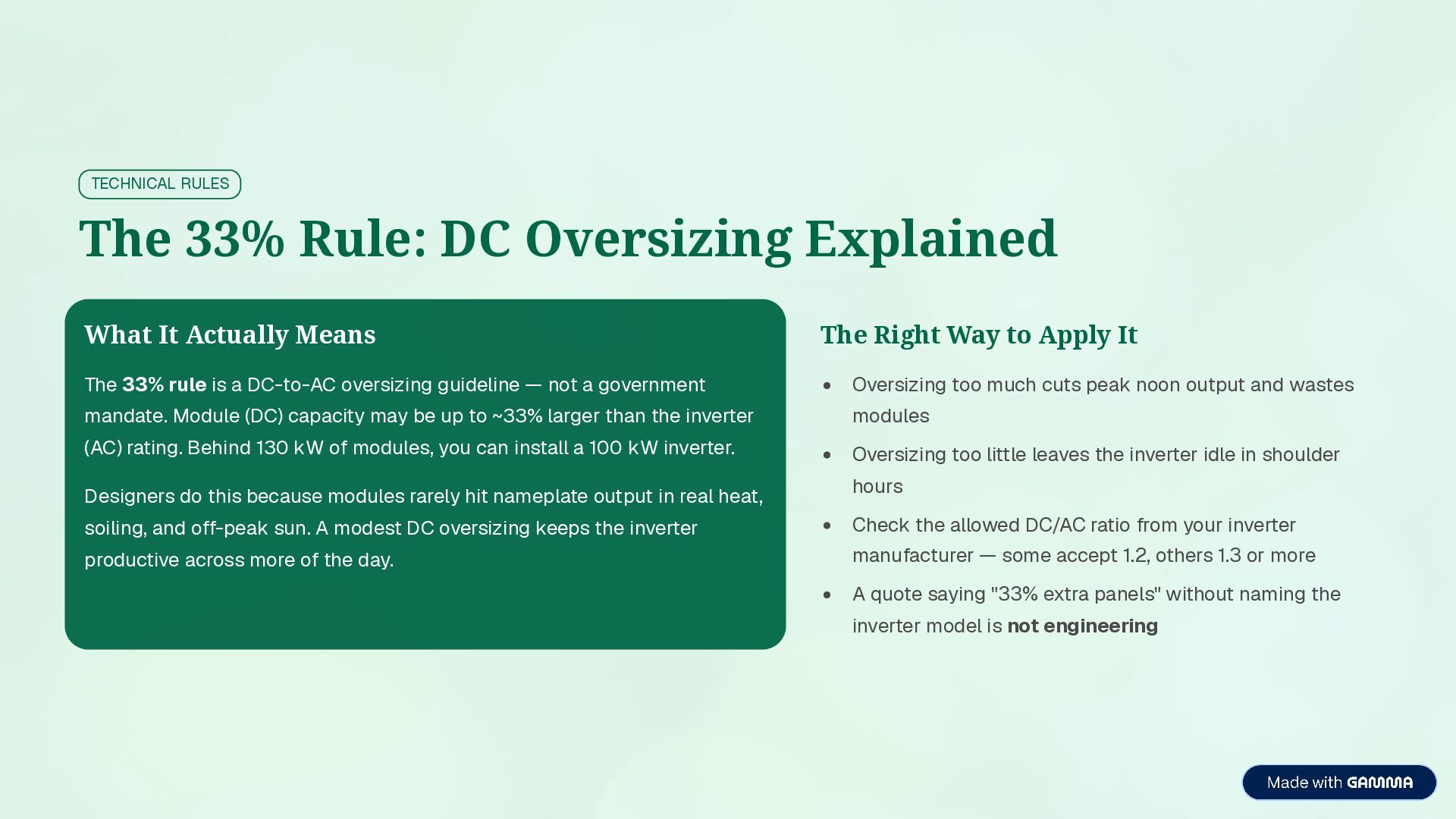

  4. TECHNICAL RULES The 33% Rule: DC Oversizing Explained What It

    Actually Means The Right Way to Apply It The 33% rule is a DC-to-AC oversizing guideline — not a government Oversizing too much cuts peak noon output and wastes mandate. Module (DC) capacity may be up to ~33% larger than the inverter modules (AC) rating. Behind 130 kW of modules, you can install a 100 kW inverter. Oversizing too little leaves the inverter idle in shoulder Designers do this because modules rarely hit nameplate output in real heat, hours soiling, and off-peak sun. A modest DC oversizing keeps the inverter Check the allowed DC/AC ratio from your inverter productive across more of the day. manufacturer — some accept 1.2, others 1.3 or more A quote saying "33% extra panels" without naming the inverter model is not engineering

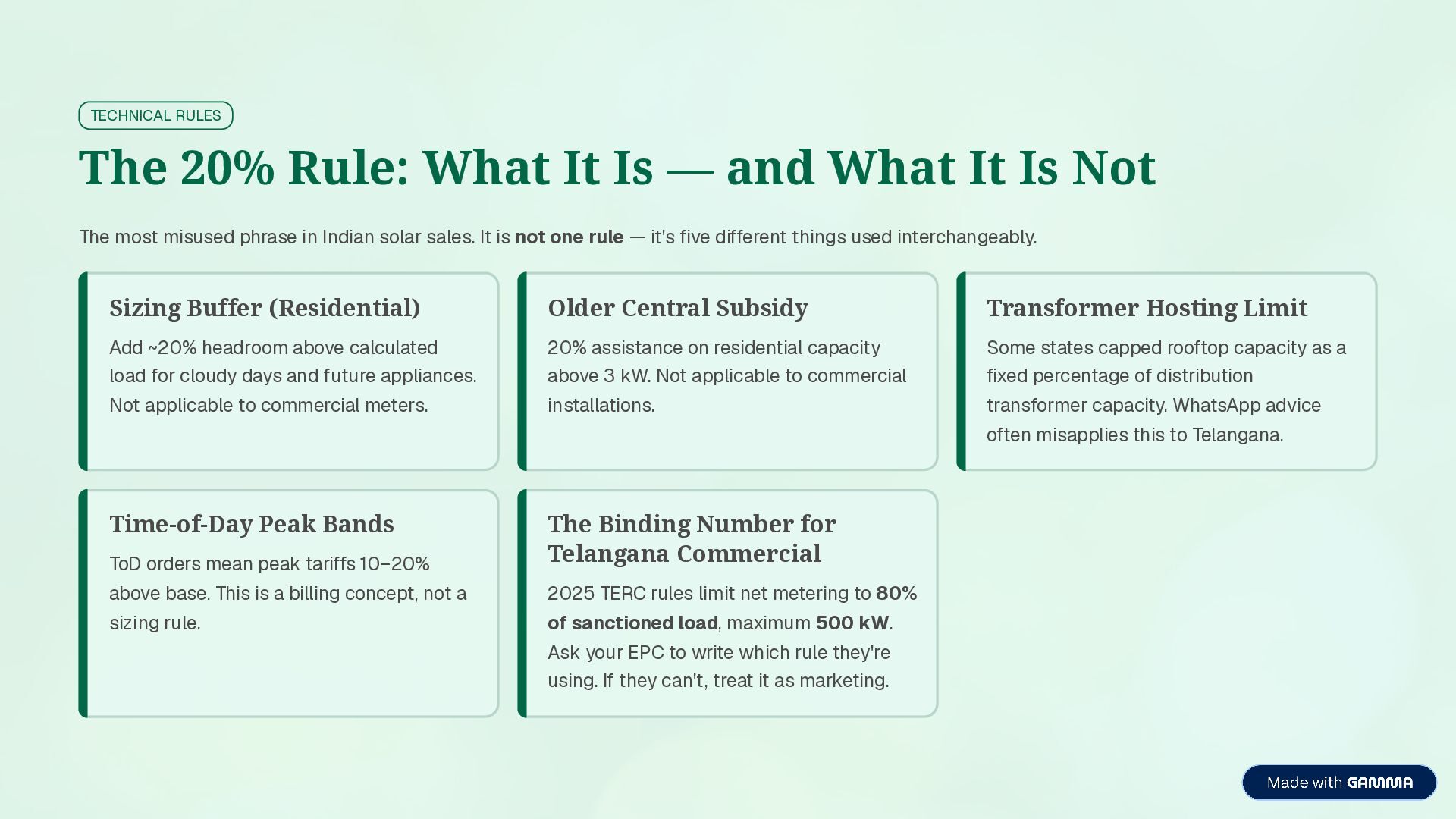

  5. TECHNICAL RULES The 20% Rule: What It Is — and

    What It Is Not The most misused phrase in Indian solar sales. It is not one rule — it's five different things used interchangeably. Sizing Buffer (Residential) Older Central Subsidy Transformer Hosting Limit Add ~20% headroom above calculated 20% assistance on residential capacity Some states capped rooftop capacity as a load for cloudy days and future appliances. above 3 kW. Not applicable to commercial fixed percentage of distribution Not applicable to commercial meters. installations. transformer capacity. WhatsApp advice often misapplies this to Telangana. Time-of-Day Peak Bands ToD orders mean peak tariffs 10–20% The Binding Number for Telangana Commercial above base. This is a billing concept, not a 2025 TERC rules limit net metering to 80% sizing rule. of sanctioned load, maximum 500 kW. Ask your EPC to write which rule they're using. If they can't, treat it as marketing.

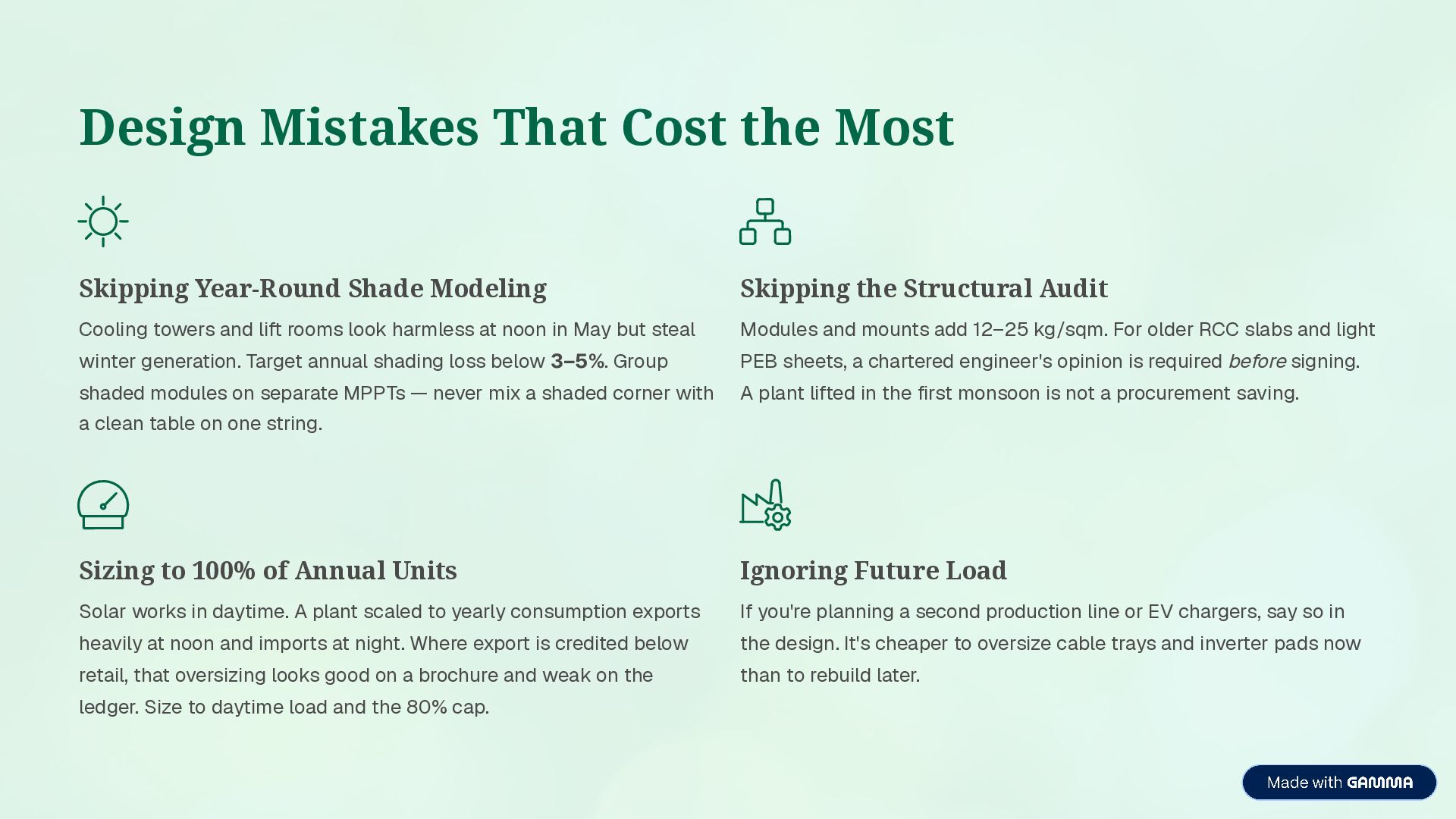

  6. Design Mistakes That Cost the Most Skipping Year-Round Shade Modeling

    Skipping the Structural Audit Cooling towers and lift rooms look harmless at noon in May but steal Modules and mounts add 12–25 kg/sqm. For older RCC slabs and light winter generation. Target annual shading loss below 3–5%. Group PEB sheets, a chartered engineer's opinion is required before signing. shaded modules on separate MPPTs — never mix a shaded corner with A plant lifted in the first monsoon is not a procurement saving. a clean table on one string. Sizing to 100% of Annual Units Ignoring Future Load Solar works in daytime. A plant scaled to yearly consumption exports If you're planning a second production line or EV chargers, say so in heavily at noon and imports at night. Where export is credited below the design. It's cheaper to oversize cable trays and inverter pads now retail, that oversizing looks good on a brochure and weak on the than to rebuild later. ledger. Size to daytime load and the 80% cap.

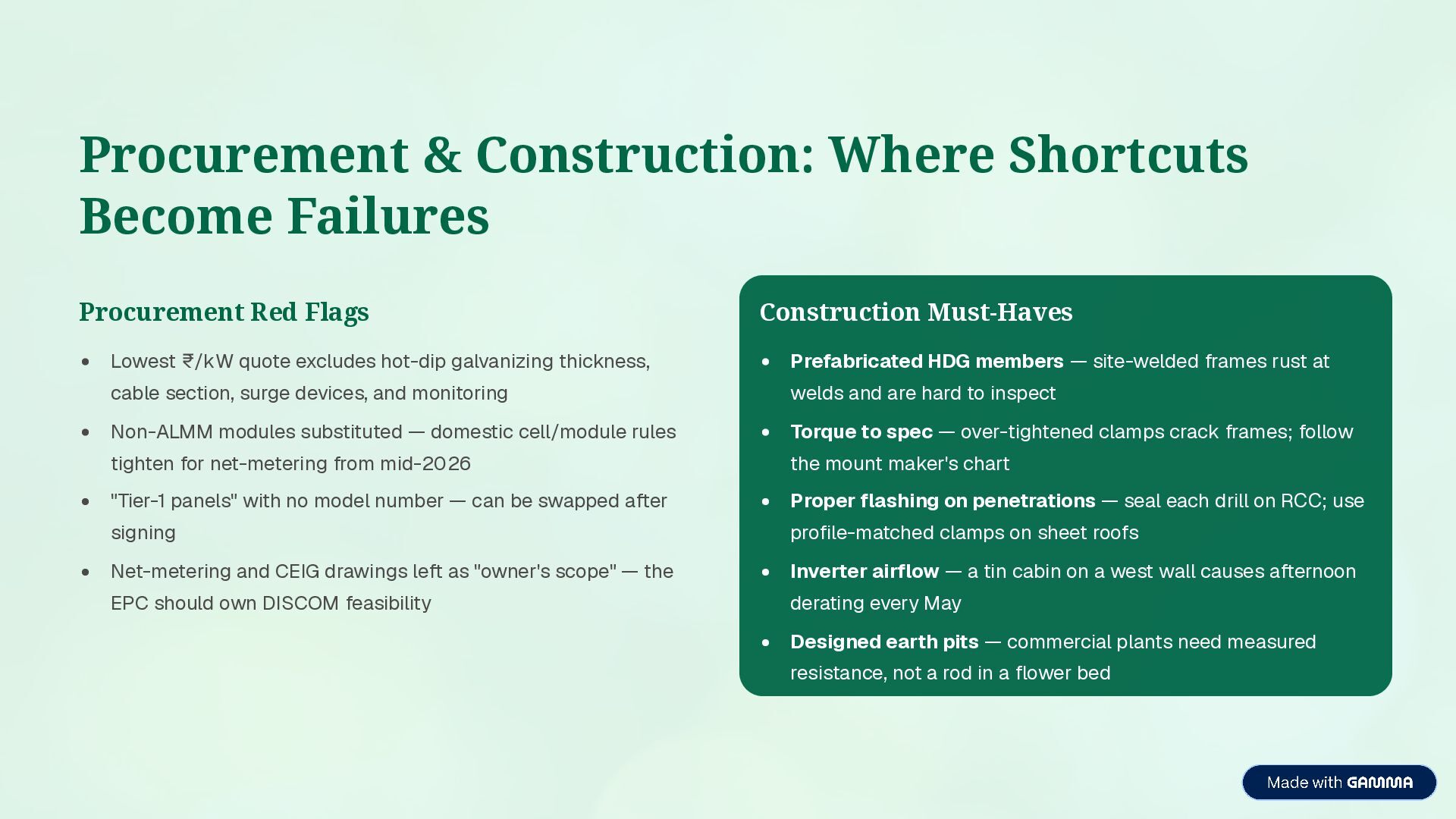

  7. Procurement & Construction: Where Shortcuts Become Failures Procurement Red Flags

    Construction Must-Haves Lowest ₹/kW quote excludes hot-dip galvanizing thickness, Prefabricated HDG members — site-welded frames rust at cable section, surge devices, and monitoring welds and are hard to inspect Non-ALMM modules substituted — domestic cell/module rules Torque to spec — over-tightened clamps crack frames; follow tighten for net-metering from mid-2026 the mount maker's chart "Tier-1 panels" with no model number — can be swapped after Proper flashing on penetrations — seal each drill on RCC; use signing profile-matched clamps on sheet roofs Net-metering and CEIG drawings left as "owner's scope" — the Inverter airflow — a tin cabin on a west wall causes afternoon EPC should own DISCOM feasibility derating every May Designed earth pits — commercial plants need measured resistance, not a rod in a flower bed

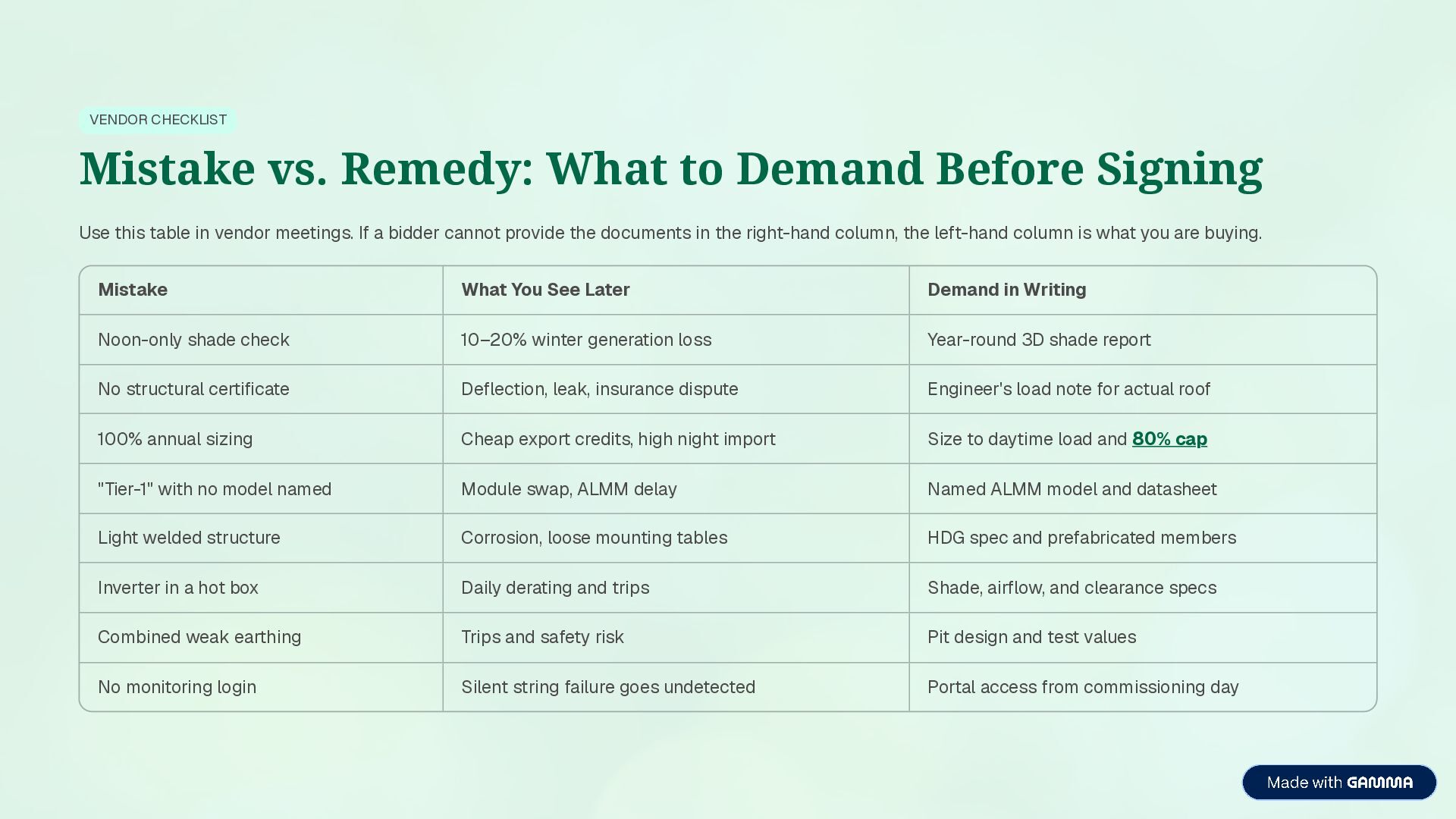

  8. VENDOR CHECKLIST Mistake vs. Remedy: What to Demand Before Signing

    Use this table in vendor meetings. If a bidder cannot provide the documents in the right-hand column, the left-hand column is what you are buying. Mistake What You See Later Demand in Writing Noon-only shade check 10–20% winter generation loss Year-round 3D shade report No structural certificate Deflection, leak, insurance dispute Engineer's load note for actual roof 100% annual sizing Cheap export credits, high night import Size to daytime load and 80% cap "Tier-1" with no model named Module swap, ALMM delay Named ALMM model and datasheet Light welded structure Corrosion, loose mounting tables HDG spec and prefabricated members Inverter in a hot box Daily derating and trips Shade, airflow, and clearance specs Combined weak earthing Trips and safety risk Pit design and test values No monitoring login Silent string failure goes undetected Portal access from commissioning day

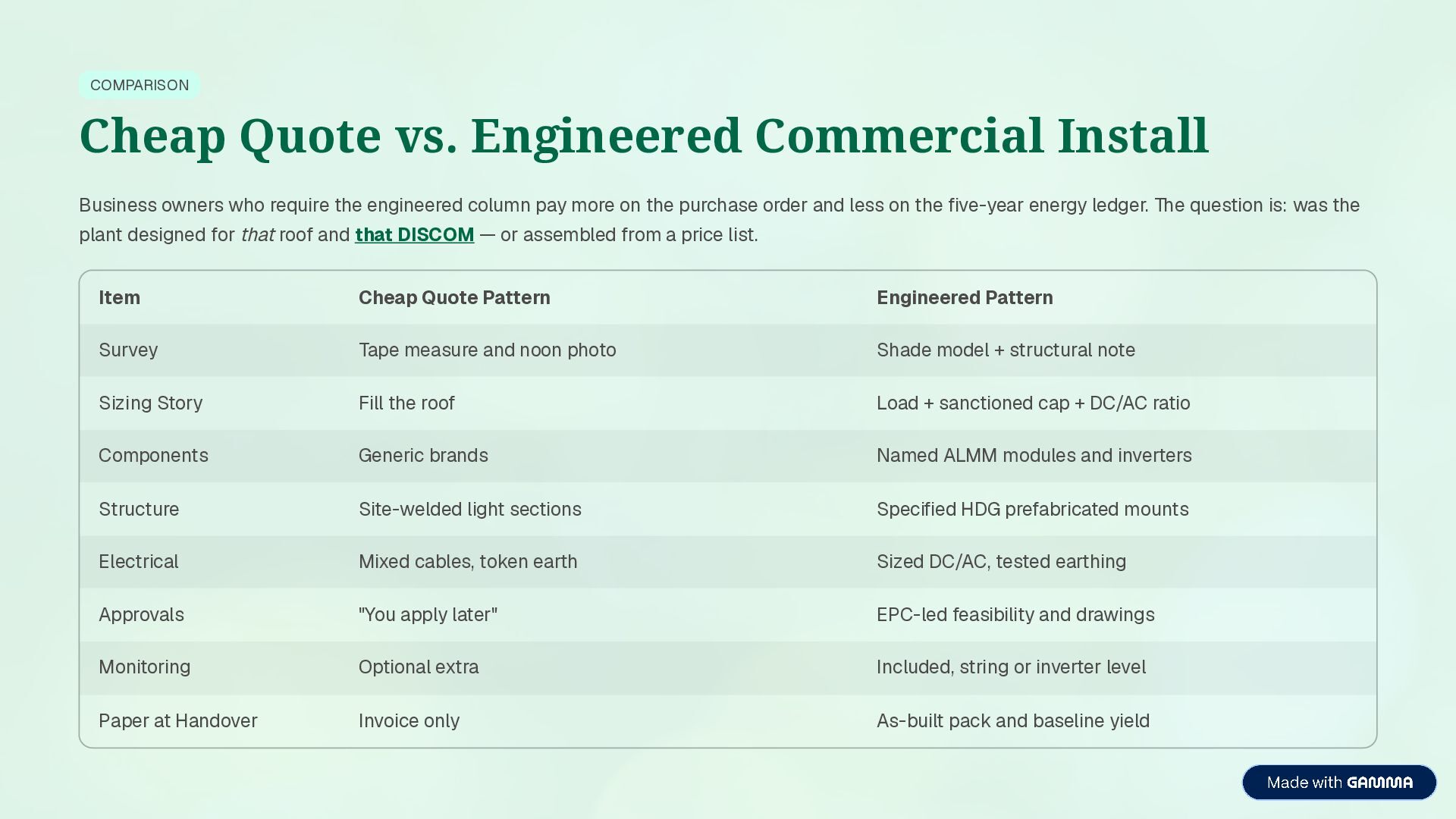

  9. COMPARISON Cheap Quote vs. Engineered Commercial Install Business owners who

    require the engineered column pay more on the purchase order and less on the five-year energy ledger. The question is: was the plant designed for that roof and that DISCOM — or assembled from a price list. Item Cheap Quote Pattern Engineered Pattern Survey Tape measure and noon photo Shade model + structural note Sizing Story Fill the roof Load + sanctioned cap + DC/AC ratio Components Generic brands Named ALMM modules and inverters Structure Site-welded light sections Specified HDG prefabricated mounts Electrical Mixed cables, token earth Sized DC/AC, tested earthing Approvals "You apply later" EPC-led feasibility and drawings Monitoring Optional extra Included, string or inverter level Paper at Handover Invoice only As-built pack and baseline yield

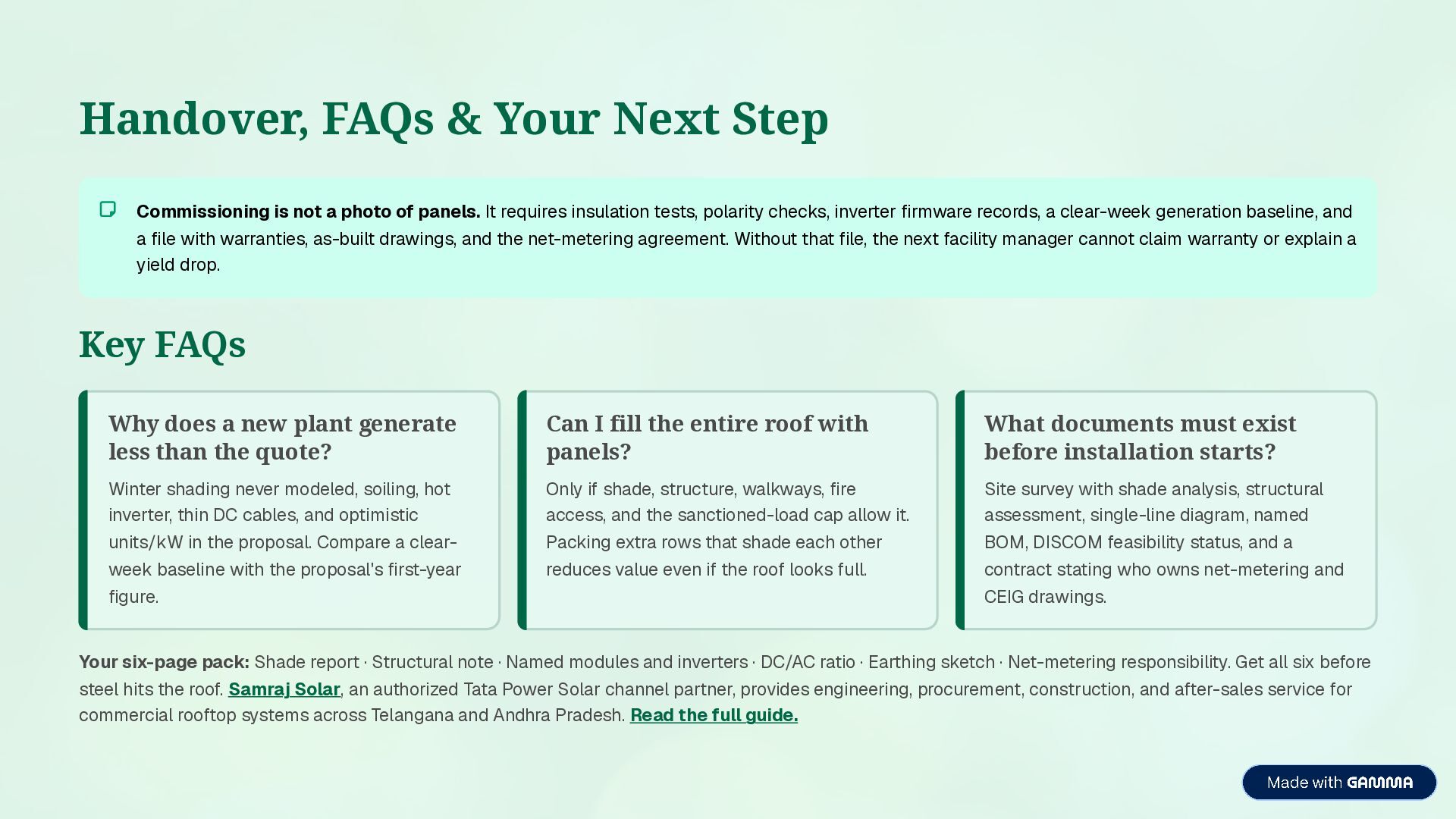

  10. Handover, FAQs & Your Next Step Commissioning is not a

    photo of panels. It requires insulation tests, polarity checks, inverter firmware records, a clear-week generation baseline, and a file with warranties, as-built drawings, and the net-metering agreement. Without that file, the next facility manager cannot claim warranty or explain a yield drop. Key FAQs Why does a new plant generate less than the quote? Can I fill the entire roof with panels? What documents must exist before installation starts? Winter shading never modeled, soiling, hot inverter, thin DC cables, and optimistic Only if shade, structure, walkways, fire access, and the sanctioned-load cap allow it. Site survey with shade analysis, structural assessment, single-line diagram, named units/kW in the proposal. Compare a clear- Packing extra rows that shade each other BOM, DISCOM feasibility status, and a week baseline with the proposal's first-year reduces value even if the roof looks full. contract stating who owns net-metering and figure. CEIG drawings. Your six-page pack: Shade report · Structural note · Named modules and inverters · DC/AC ratio · Earthing sketch · Net-metering responsibility. Get all six before steel hits the roof. Samraj Solar, an authorized Tata Power Solar channel partner, provides engineering, procurement, construction, and after-sales service for commercial rooftop systems across Telangana and Andhra Pradesh. Read the full guide.
